For mechanical installation contractors, Bidfident prices machine installs and line moves the way the work is done: machines positioned and levelled by number, laser alignment with the kit charged by the hour, conveyor by the metre, holding-down bolts and grout, rigging as an item, electrical as a subcontract, and the supervisor and forklift hire by the week.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • Every machine install built from scratch

    Positioning a machine always needs the same labour, holding-down bolts and grout, yet each tender starts from a blank row. In Bidfident an assembly fills a whole line at once, and typing a description finds it in the rate library with its price.

  • Riggers and fitters at one rate

    One blended rate hides the difference between the rigging gang and the mechanical fitters. In Bidfident each trade has its own rate, and typing a new trade in the Trade cell adds it to the library with its rate, without leaving the sheet.

  • The electrical quote that never came

    The control wiring is priced by someone else, and the quote is still missing on tender day. In Bidfident you carry an allowance for the package until quotes arrive, then the lowest is flagged and carried unless you choose another.

How Bidfident fits your work

  • Bidfident screenshot: machine installs from the rate library

    Machine installs from the rate library

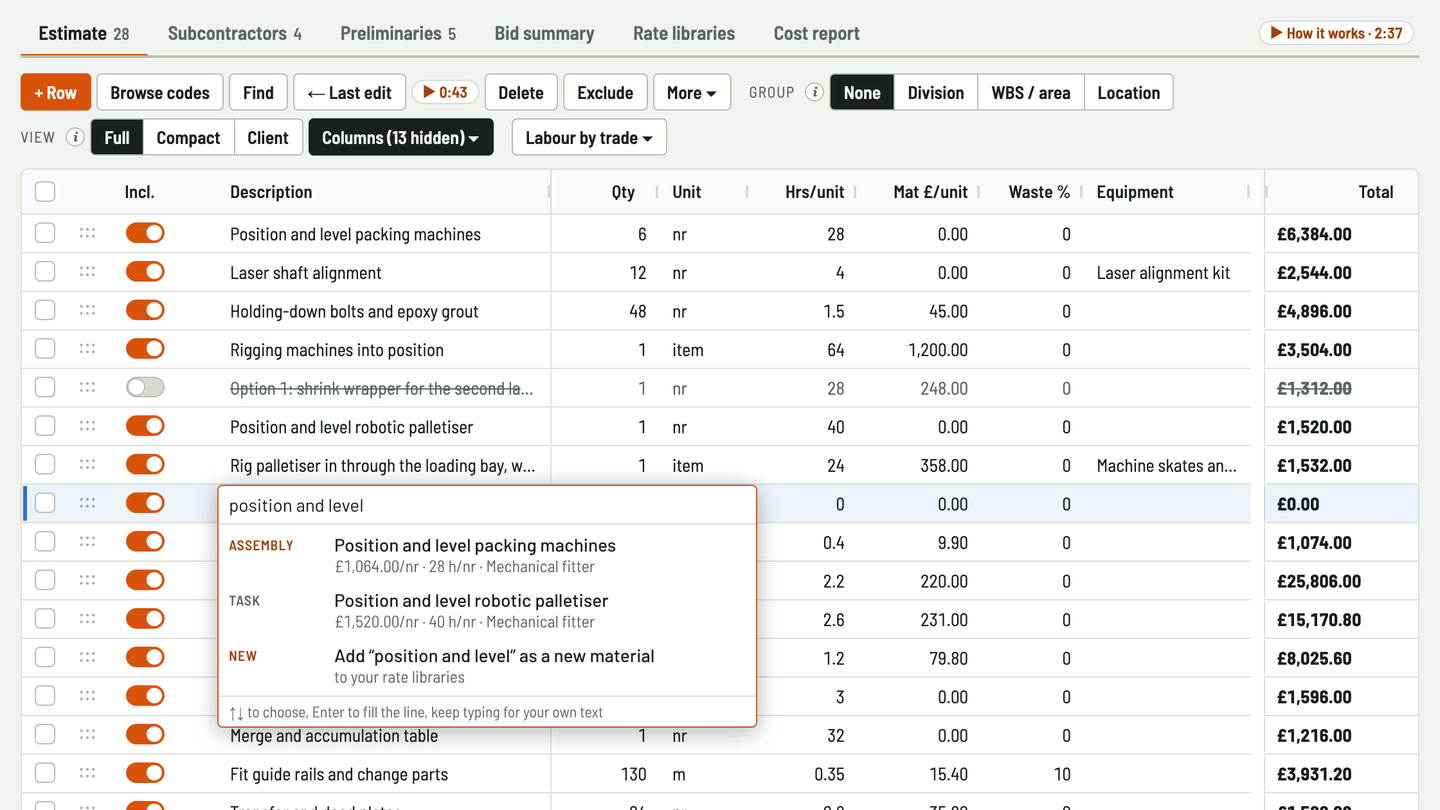

    Start typing "position and level" in Description and the line picker finds your tasks and assemblies with their prices. Pick an assembly and it fills the whole line.

  • Bidfident screenshot: fitters and riggers at their own rates

    Fitters and riggers at their own rates

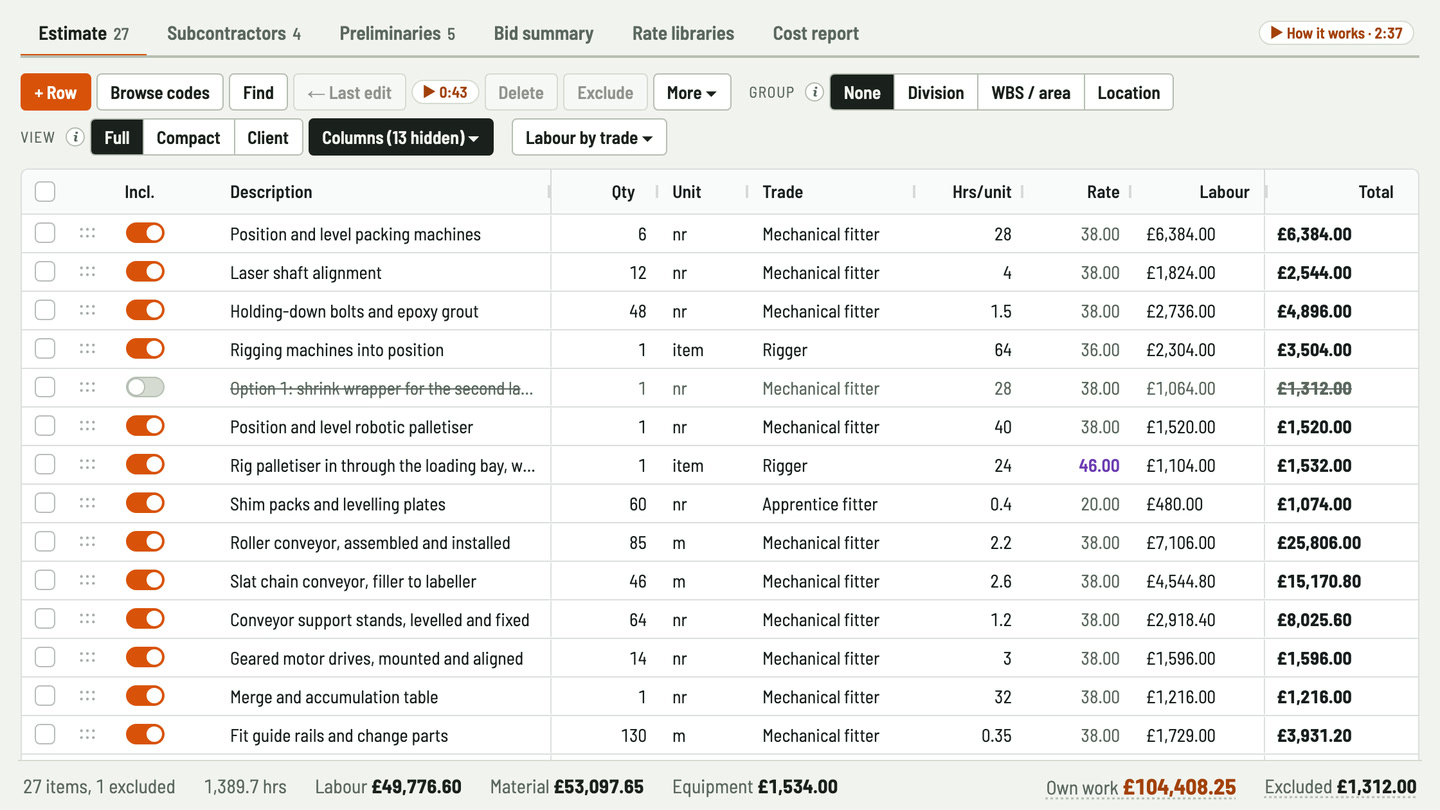

    Each line takes its trade's rate from the library, so the rigging is priced at the rigger's rate and the alignment at the mechanical fitter's.

  • Bidfident screenshot: tools and plant by the hour

    Tools and plant by the hour

    Put the laser alignment kit on the line as plant by the hour. Leave its hours blank and it runs for the crew's hours, or give it hours of its own.

  • Bidfident screenshot: conveyor by the metre, machines by number

    Conveyor by the metre, machines by number

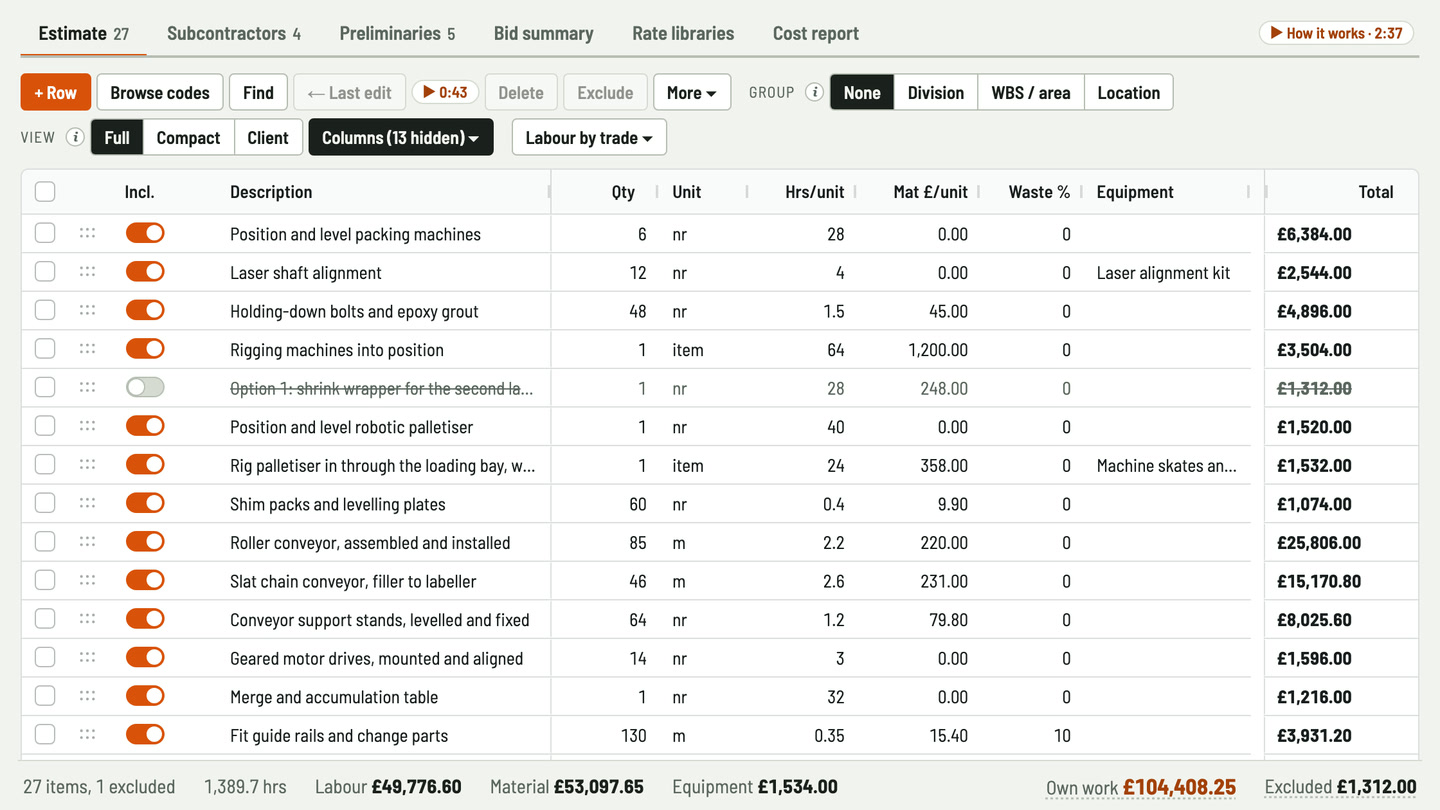

    Units are free text, so conveyor goes in by the metre, machines and bolts by number (nr), and rigging as an item. The sheet works like Excel: copy and paste, fill down, and undo for everything.

  • Bidfident screenshot: electrical as a subcontract

    Electrical as a subcontract

    Enter each electrical quote for the connections and control wiring on the Subcontractors tab. The lowest is flagged and carried, and an allowance holds the place if none have come in.

  • Bidfident screenshot: supervisor and forklift by the week

    Supervisor and forklift by the week

    Weekly preliminaries like the mechanical supervisor and forklift hire follow the job duration. Add a week to the installation and they update.

Worked example: installing a new packing line

A made-up job, priced in Bidfident: 26 lines of your own work, 4 subcontract packages and 5 preliminaries items over a 3-week programme. The 5 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in the UK, then on the Projects screen, under Example project, pick "Shutdowns and turnarounds" and "Mechanical installation" and press Add example project.

Your own work
ItemAmount
Position and level packing machines, 6 nr
  • Labour: 6 nr × 28 hrs = 168 hrs at £38.00/hr (mechanical fitter) = £6,384.00
£6,384.00
Laser shaft alignment, 12 nr
  • Labour: 12 nr × 4 hrs = 48 hrs at £38.00/hr (mechanical fitter) = £1,824.00
  • Plant: laser alignment kit, 48 hrs, with the crew, at £15.00/hr = £720.00
£2,544.00
Holding-down bolts and epoxy grout, 48 nr
  • Labour: 48 nr × 1.5 hrs = 72 hrs at £38.00/hr (mechanical fitter) = £2,736.00
  • Materials: 48 nr × £45.00 = £2,160.00
£4,896.00
Rigging machines into position, 1 item
  • Labour: 1 item × 64 hrs = 64 hrs at £36.00/hr (rigger) = £2,304.00
  • Materials: 1 item × £1,200.00 = £1,200.00
£3,504.00
Roller conveyor, assembled and installed, 85 m
  • Labour: 85 m × 2.2 hrs = 187 hrs at £38.00/hr (mechanical fitter) = £7,106.00
  • Materials: 85 m × £220.00 = £18,700.00
£25,806.00

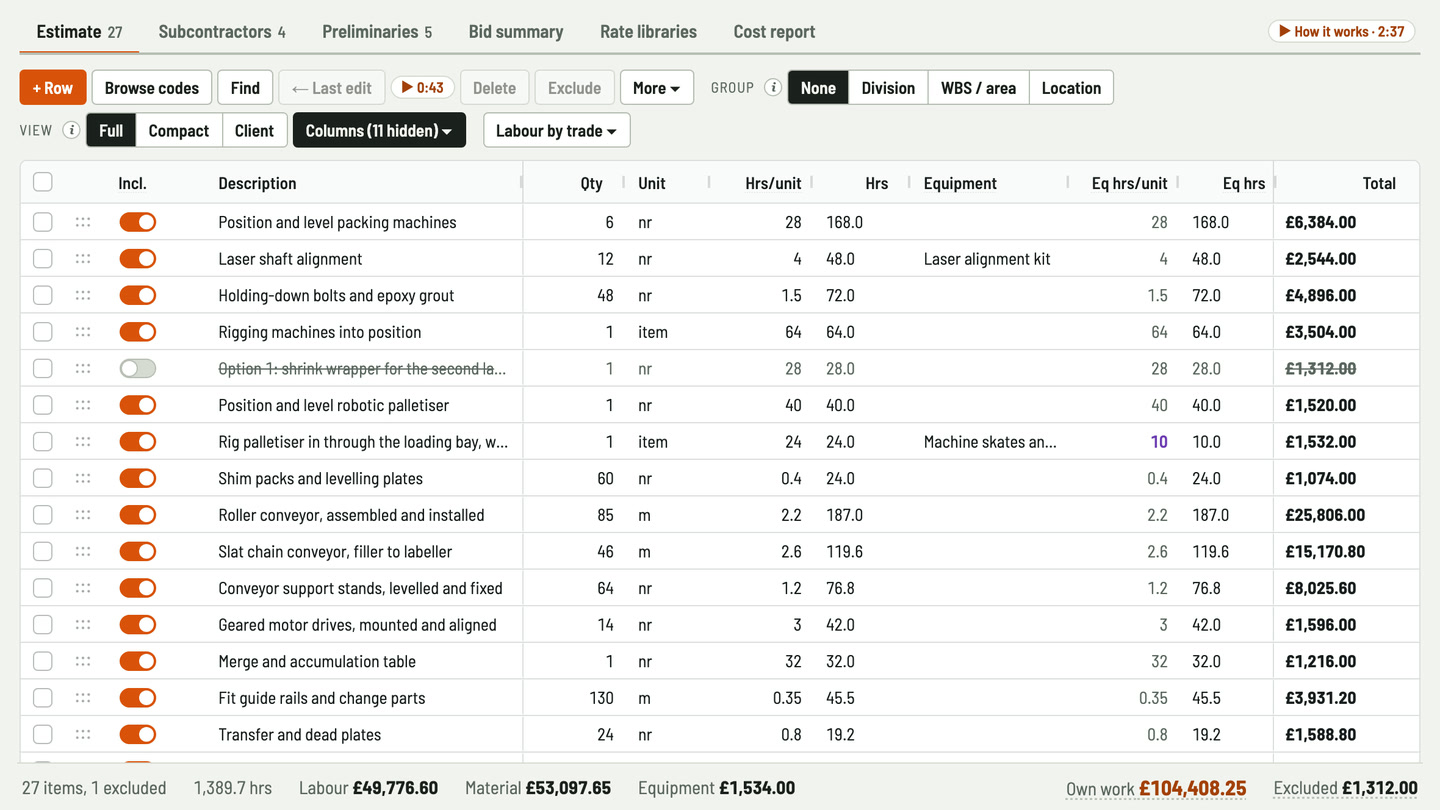

21 more lines of your own work
  • Labour £29,422.60 + materials £31,037.65 + plant £814.00
  • 1 more line is priced but left out of the total
£61,274.25
Subcontractors
ItemAmount

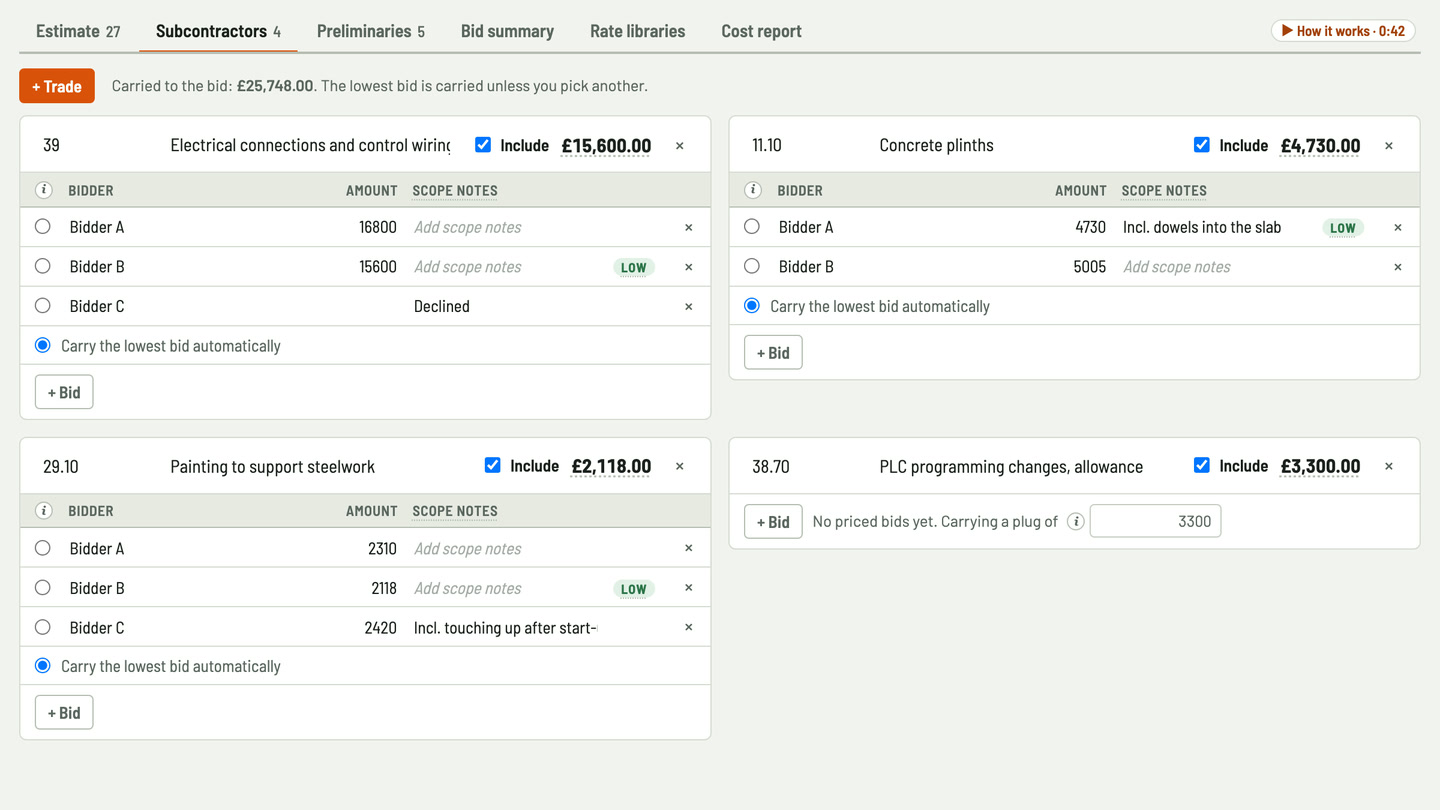

Electrical connections and control wiring
  • Quotes: Bidder A £16,800.00, Bidder B £15,600.00
  • Carrying the lowest: Bidder B
£15,600.00
Concrete plinths
  • Quotes: Bidder A £4,730.00, Bidder B £5,005.00
  • Carrying the lowest: Bidder A
£4,730.00
Painting to support steelwork
  • Quotes: Bidder A £2,310.00, Bidder B £2,118.00, Bidder C £2,420.00
  • Carrying the lowest: Bidder B
£2,118.00
PLC programming changes, allowance
  • No quotes yet: carrying an allowance
£3,300.00

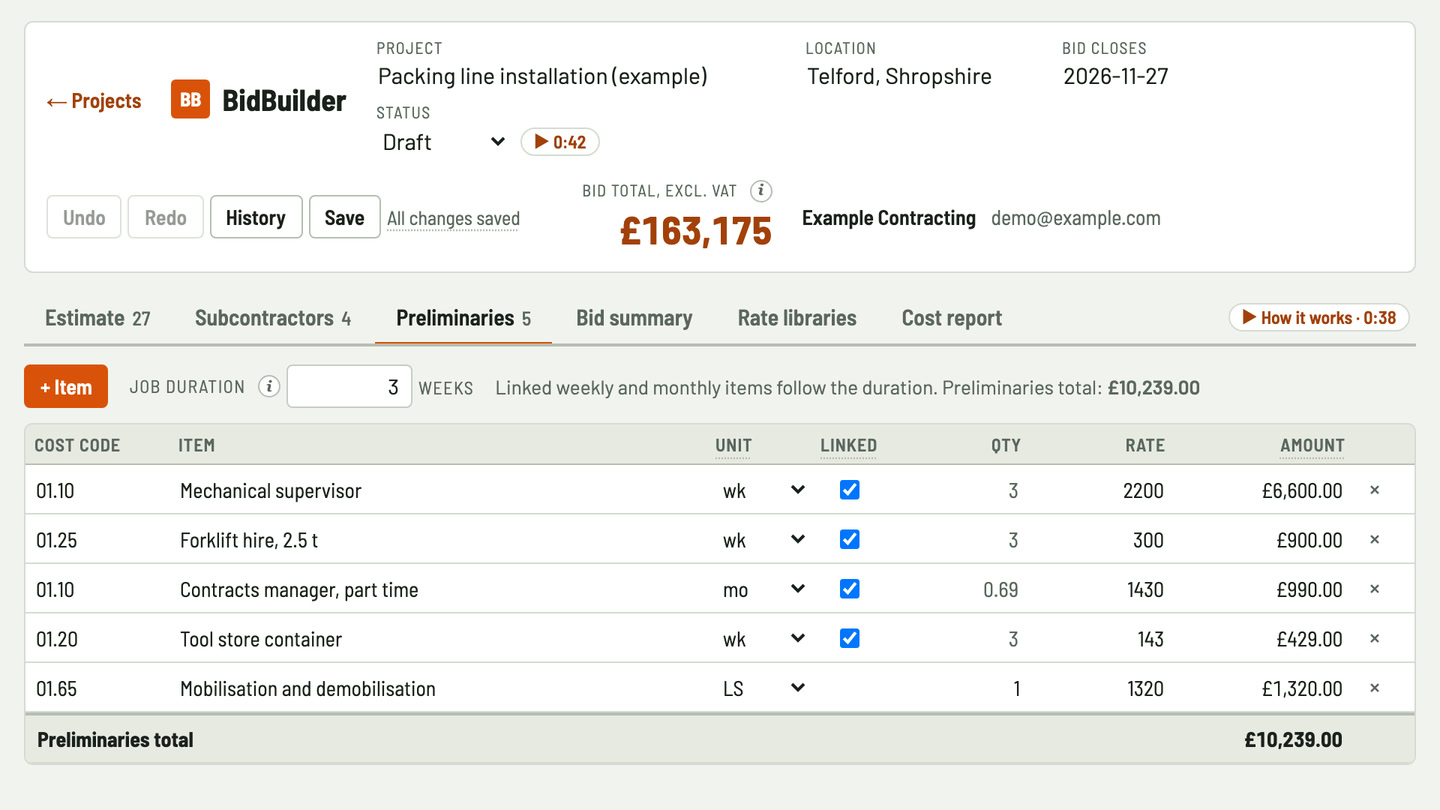

Preliminaries
ItemAmount
Mechanical supervisor
  • 3 wk × £2,200.00, following the programme
£6,600.00
Forklift hire, 2.5 t
  • 3 wk × £300.00, following the programme
£900.00
Contracts manager, part time
  • 3 weeks × £1,430.00 a month × 12 ÷ 52, following the programme
£990.00
Tool store container
  • 3 wk × £143.00, following the programme
£429.00
Mobilisation and demobilisation
  • 1 LS × £1,320.00
£1,320.00
Tender summary
ItemAmount
Own work
  • Labour £49,776.60 + materials £53,097.65 + plant £1,534.00
£104,408.25
Excluded lines, not counted£1,312.00
Subcontractors£25,748.00
Preliminaries
  • 3 weeks
£10,239.00
Direct cost
  • Own work + subcontractors + preliminaries
£140,395.25
Contingency
  • 3% of direct cost
£4,211.86
Overheads and profit
  • 12% of direct cost plus contingency
£17,352.85
Subtotal before the bond£161,959.96
Bond
  • 0% of the subtotal
£0.00
Insurance
  • 0.75% of the subtotal
£1,214.70
Tender total
  • The price you tender, before VAT
£163,174.66
VAT, for reference
  • 20%, shown separately and not part of the tender total
£32,634.93

See it in Bidfident

Search the rate library Type "position and level" and the rate library finds your tasks and assemblies, with their prices. 32 sec
New trades on the spot Type rigger into the Trade cell and it's added to the library with its rate, without leaving the sheet. 31 sec
Labour by trade Mechanical fitters and riggers each priced at their own trade's rate from your library. 33 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can I save how I price a machine install?

Yes. Save it in the rate library as a task with its hours per unit, or as an assembly that fills a whole line at once. Every estimate uses the same library.

Can I mix metres, numbers and items?

Yes. Units are free text, so m, nr, item and hr all work. Bidfident doesn't convert between units, so price each line in the unit its rate is in.

Can I carry the electrical before I have a quote?

Yes. Carry an allowance for the package. When quotes come in, enter them side by side and the lowest is carried unless you choose another.

Can I add riggers or a crane driver while I'm pricing?

Yes. Type the new trade in the Trade cell and give it a rate. It's added to the company's library without leaving the sheet, ready for the next installation.

Can I allow waste on grout and holding-down bolts?

Yes. Each line takes a material price per unit and a waste %, so the epoxy grout can carry 10% waste while the holding-down bolts carry none.

Does it produce a quotation for the installation to send the client?

Not yet. Client view hides hours and rates on screen, but its unit prices are your cost, before markups. You can copy the cost report as CSV, but there's no client-ready quote document.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.

Price your next installation tender in Bidfident

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.
