Estimating software for fiber runs

Pricing a fiber run in Bidfident starts with the footage. Put cable pulled in conduit and aerial fiber lashed to strand on their own lines, each with its hours per foot and a waste percentage on the cable. The bucket truck is charged for its own hours, handholes and slack loops go in by the each, locates as a sub, and traffic control by the week.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • Aerial and underground at one rate

    A lineman on the strand costs more than a technician pulling cable in conduit, but one blended rate in the spreadsheet hides it. In Bidfident each line takes its own trade's rate from your library.

  • Cable waste guessed on a separate row

    Slack, tails and cut-offs get added as a lump at the bottom, or forgotten. In Bidfident each line's material price has its own waste percentage, so the extra cable is priced in the line it belongs to.

  • Traffic control that doesn't follow the job

    The route slips a week and the traffic control row still says five. In Bidfident weekly general conditions like traffic control and supervision follow the job duration, so change the weeks and they follow.

How Bidfident fits your work

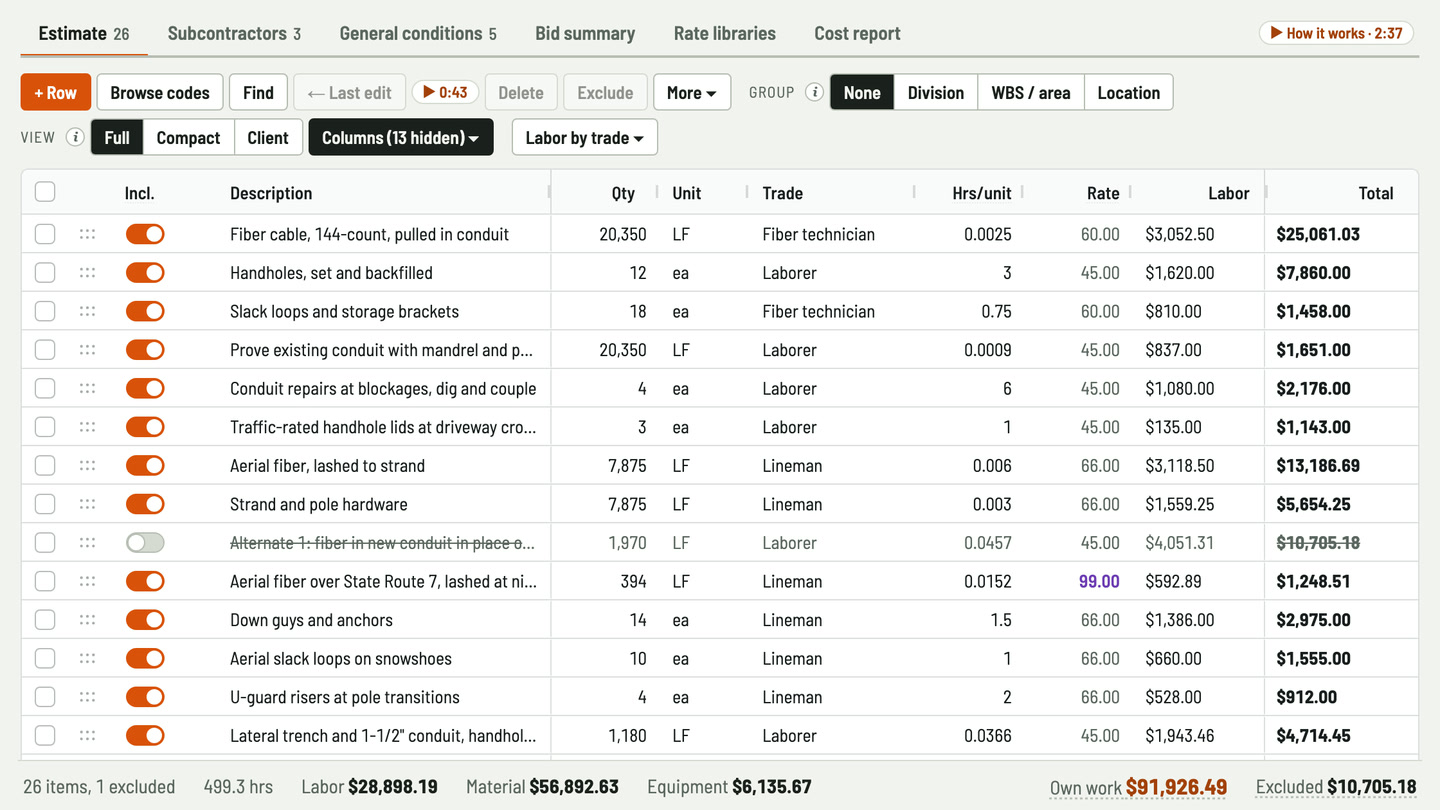

  • Bidfident screenshot: linemen and technicians at their own rates

    Linemen and technicians at their own rates

    Put aerial lashing on the lineman, cable pulls on the fiber technician and handholes on the laborer. Each line takes its trade's rate from your library.

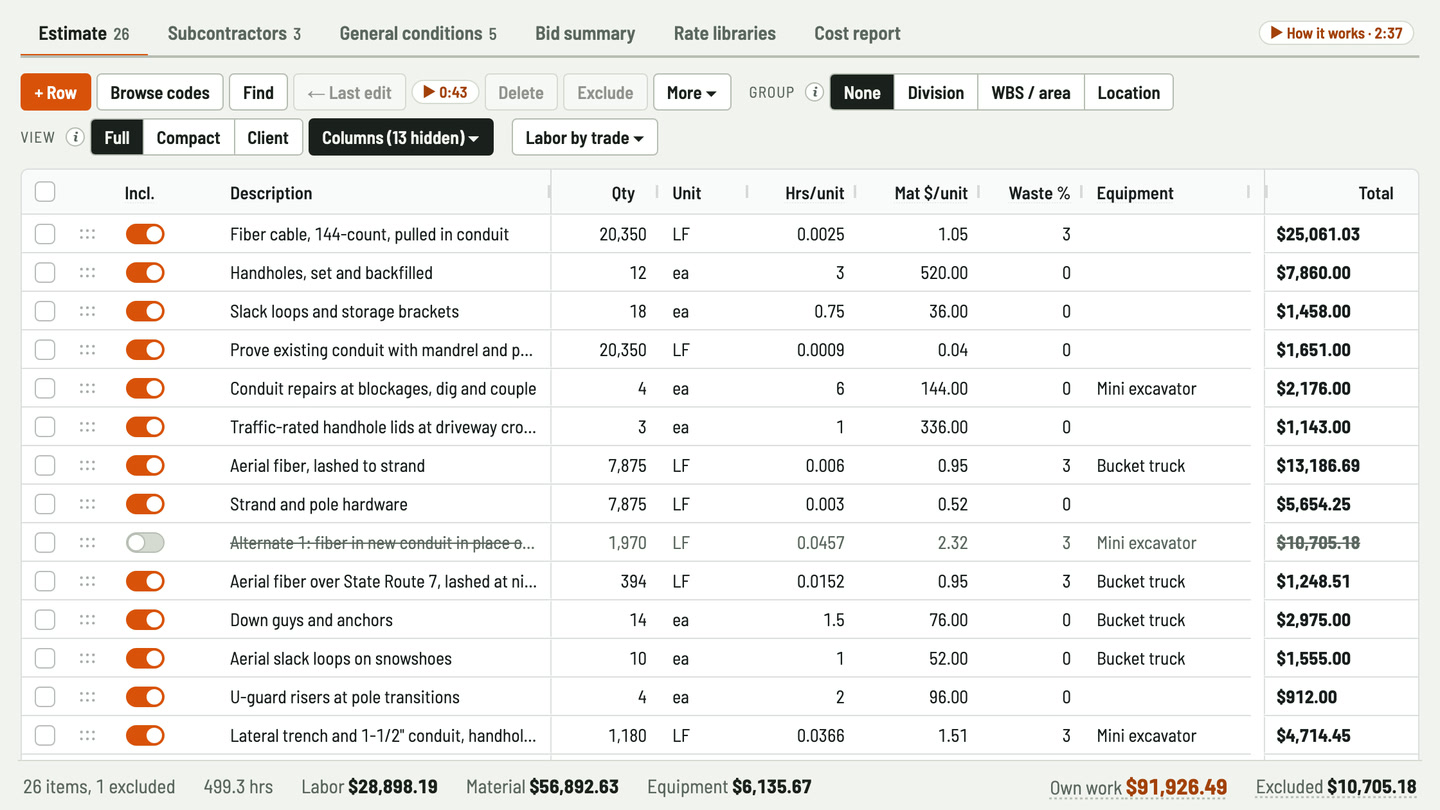

  • Bidfident screenshot: footage of cable with waste built in

    Footage of cable with waste built in

    Each line takes linear feet, hours per foot, a cable price with its waste percentage, and equipment by the hour. Copy a run down the sheet like Excel and the totals keep up.

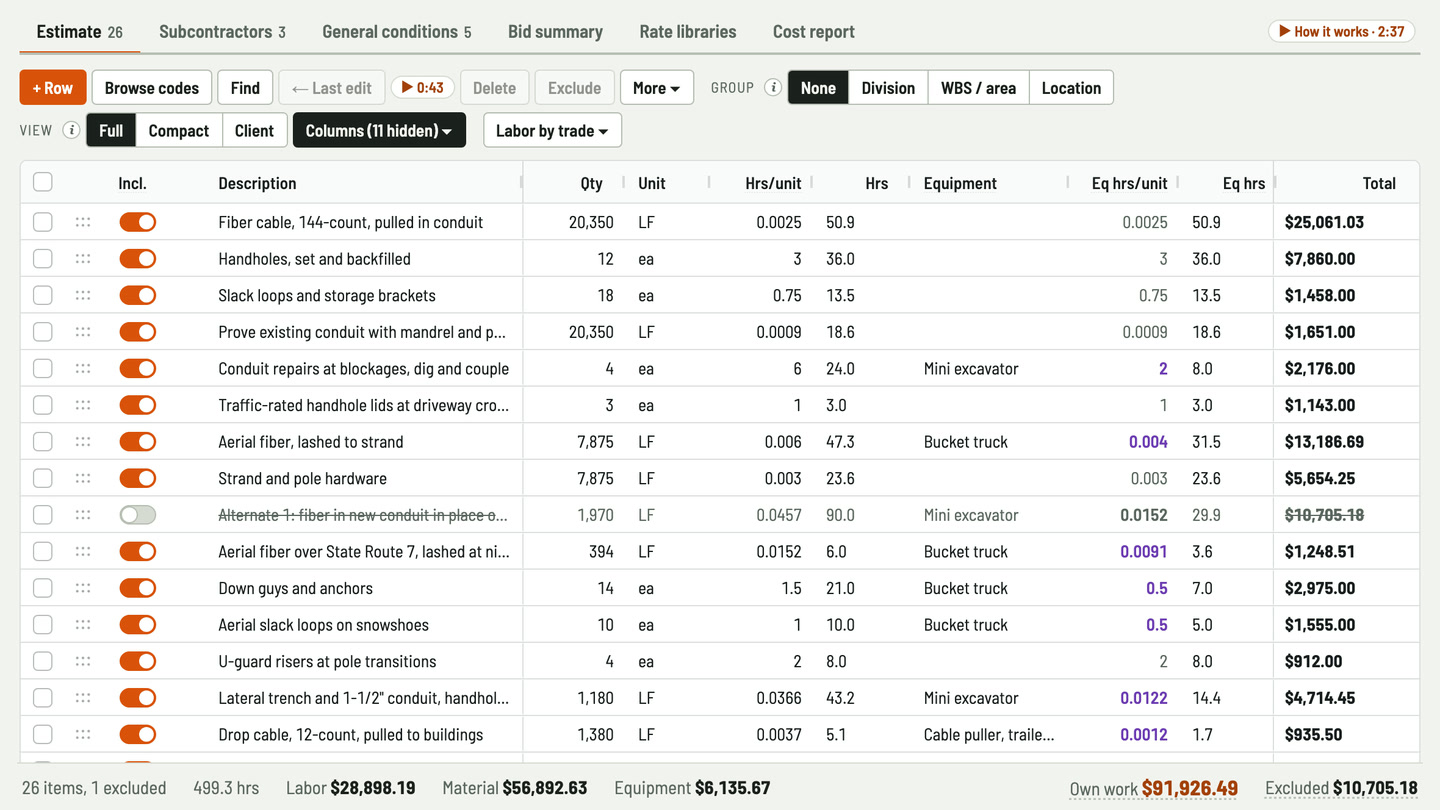

  • Bidfident screenshot: a bucket truck for the hours it runs

    A bucket truck for the hours it runs

    Give the bucket truck its own hours per foot on the aerial line. It's charged for those hours, not every hour the crew spends lashing.

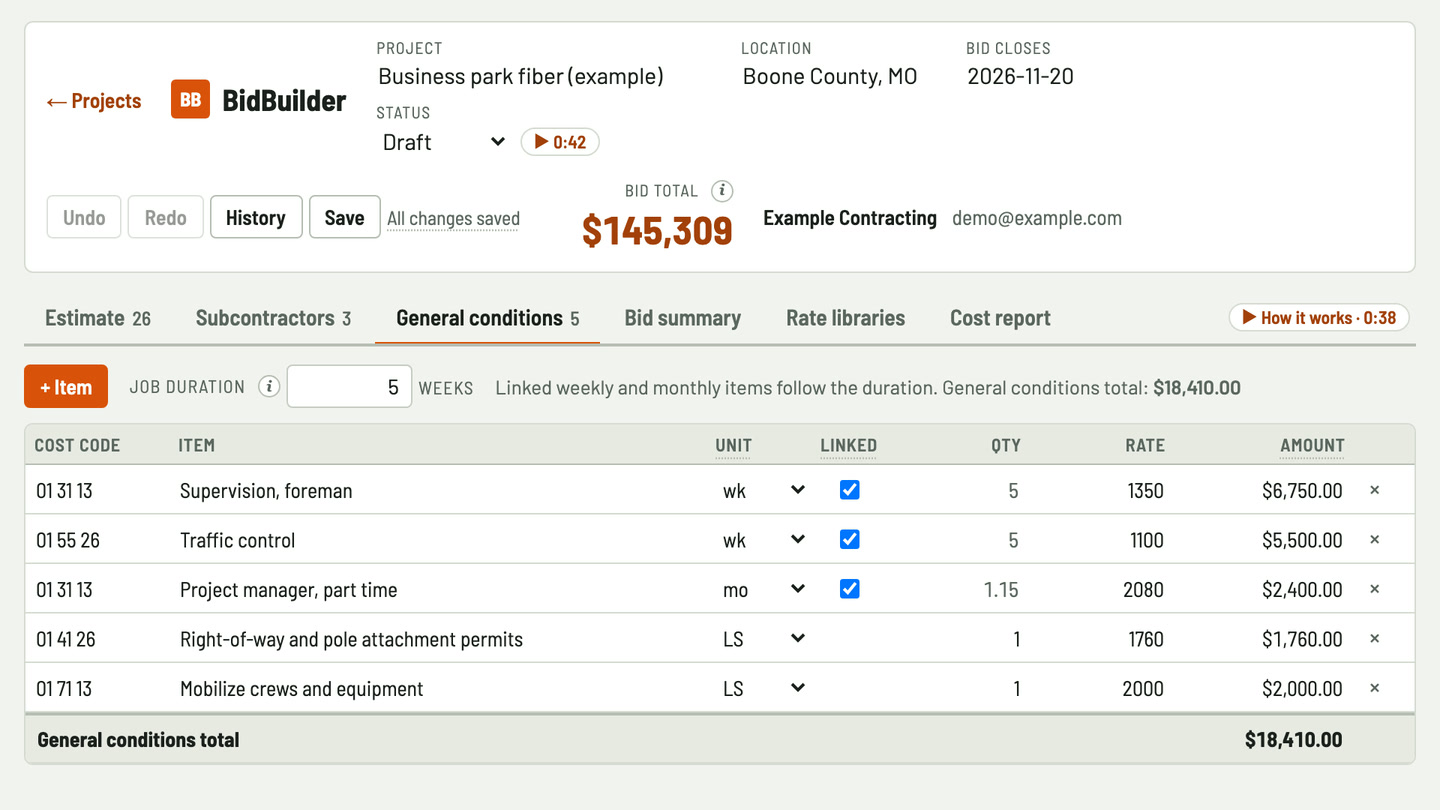

  • Bidfident screenshot: traffic control by the week

    Traffic control by the week

    Traffic control and the foreman go in by the week and follow the job duration. Stretch the job from 5 weeks to 6 and they follow.

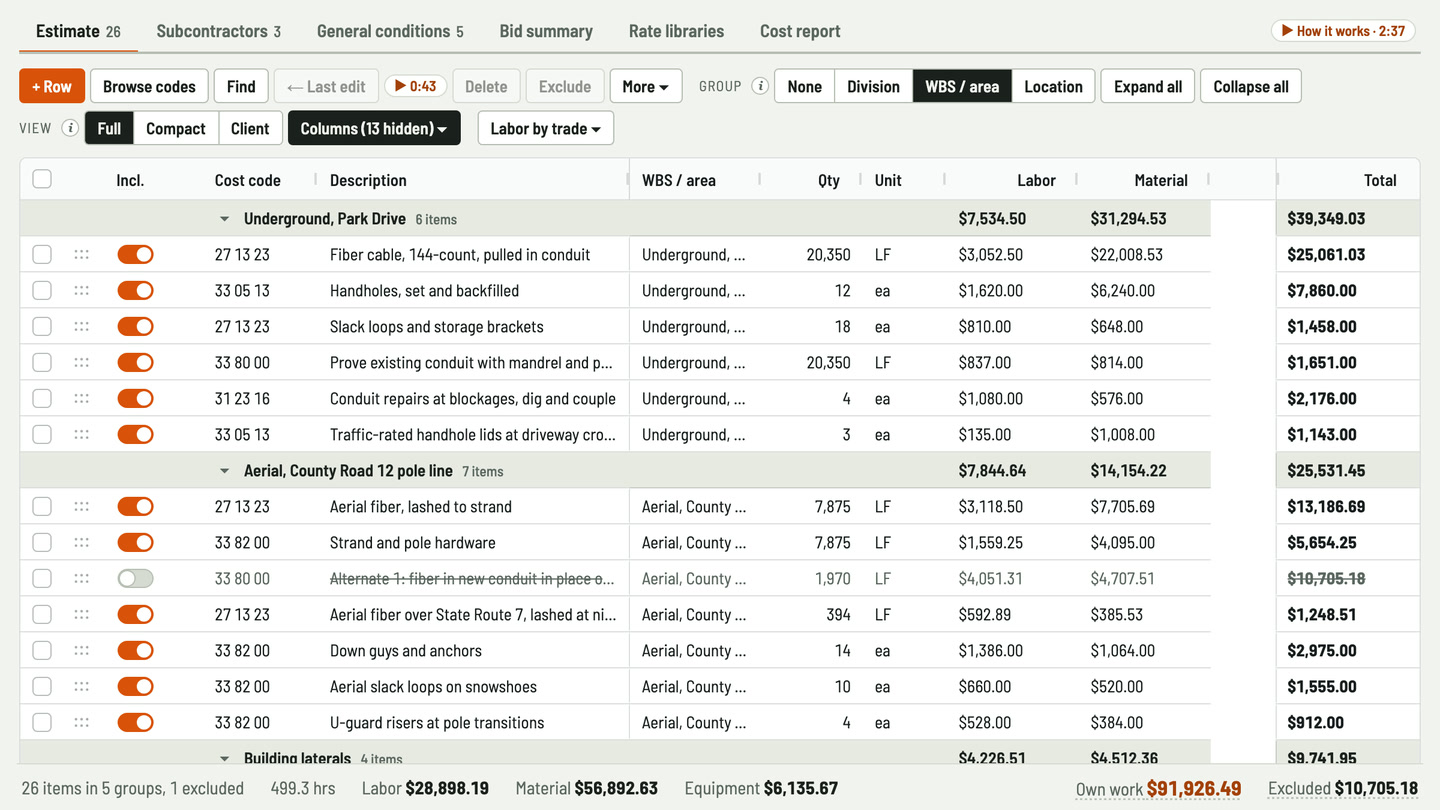

  • Bidfident screenshot: each segment with its own subtotal

    Each segment with its own subtotal

    Tag lines with a segment, a street or a pole line, then group the sheet by it to see what each stretch of the route comes to.

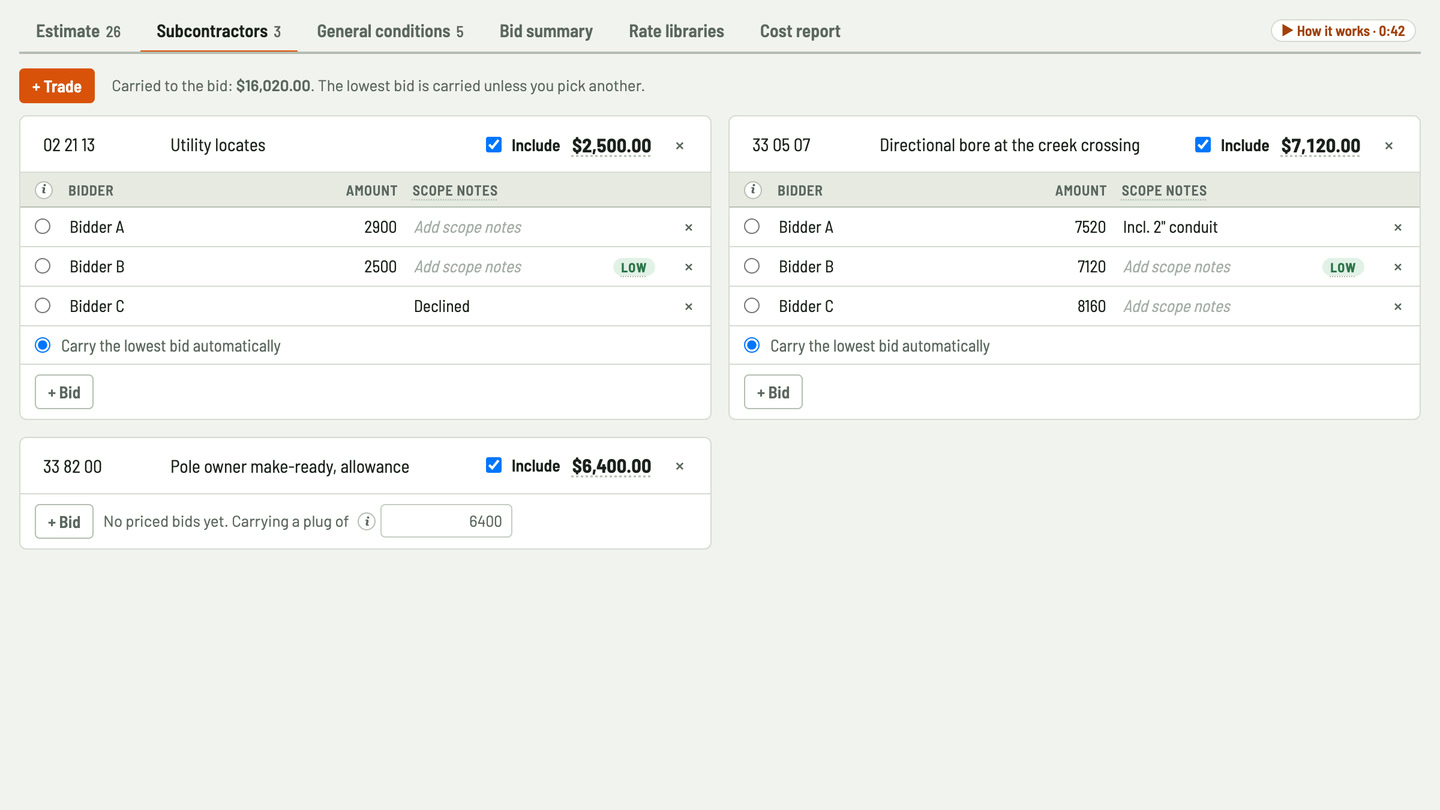

  • Bidfident screenshot: locates bids side by side

    Locates bids side by side

    Enter each locates bid on the Subcontractors tab, see the lowest flagged, and carry it or the one you pick. No bids yet? Carry a plug number so the bid isn't short.

Worked example: fiber to a rural business park

A made-up job, priced in Bidfident: 25 lines of your own work, 3 subs and 5 general conditions items over a 5-week job. The 5 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in the US, then on the Projects screen, under Example project, pick "Telecom and fiber" and "Fiber runs" and press Add example project.

Your own work
ItemAmount
Fiber cable, 144-count, pulled in conduit, 20,350 LF
  • Labor: 20,350 LF × 0.0025 hrs = 50.88 hrs at $60.00/hr (fiber technician) = $3,052.50
  • Material: 20,350 LF × $1.05 + 3% waste = $22,008.53
$25,061.03
Handholes, set and backfilled, 12 ea
  • Labor: 12 ea × 3 hrs = 36 hrs at $45.00/hr (laborer) = $1,620.00
  • Material: 12 ea × $520.00 = $6,240.00
$7,860.00
Slack loops and storage brackets, 18 ea
  • Labor: 18 ea × 0.75 hrs = 13.5 hrs at $60.00/hr (fiber technician) = $810.00
  • Material: 18 ea × $36.00 = $648.00
$1,458.00
Aerial fiber, lashed to strand, 7,875 LF
  • Labor: 7,875 LF × 0.006 hrs = 47.25 hrs at $66.00/hr (lineman) = $3,118.50
  • Material: 7,875 LF × $0.95 + 3% waste = $7,705.69
  • Equipment: bucket truck, 7,875 LF × 0.004 hrs = 31.5 hrs, less than the crew, at $75.00/hr = $2,362.50
$13,186.69
Strand and pole hardware, 7,875 LF
  • Labor: 7,875 LF × 0.003 hrs = 23.63 hrs at $66.00/hr (lineman) = $1,559.25
  • Material: 7,875 LF × $0.52 = $4,095.00
$5,654.25
20 more lines of your own work
  • Labor $18,737.94 + material $16,195.41 + equipment $3,773.17
  • 1 more line is priced but left out of the total
$38,706.52
Subcontractors
ItemAmount
Utility locates
  • Bids: Bidder A $2,900.00, Bidder B $2,500.00
  • Carrying the lowest: Bidder B
$2,500.00
Directional bore at the creek crossing
  • Bids: Bidder A $7,520.00, Bidder B $7,120.00, Bidder C $8,160.00
  • Carrying the lowest: Bidder B
$7,120.00
Pole owner make-ready, allowance
  • No bids yet: carrying a plug number
$6,400.00
General conditions
ItemAmount
Supervision, foreman
  • 5 wk × $1,350.00, following the job duration
$6,750.00
Traffic control
  • 5 wk × $1,100.00, following the job duration
$5,500.00
Project manager, part time
  • 5 weeks × $2,080.00 a month × 12 ÷ 52, following the job duration
$2,400.00
Right-of-way and pole attachment permits
  • 1 LS × $1,760.00
$1,760.00
Mobilize crews and equipment
  • 1 LS × $2,000.00
$2,000.00
Bid summary
ItemAmount
Own work
  • Labor $28,898.19 + material $56,892.63 + equipment $6,135.67
$91,926.49
Excluded lines, not counted$10,705.18
Subcontractors$16,020.00
General conditions
  • 5 weeks
$18,410.00
Direct cost
  • Own work + subcontractors + general conditions
$126,356.49
Contingency
  • 3% of direct cost
$3,790.69
Fee
  • 10% of direct cost plus contingency
$13,014.72
Subtotal before the bond$143,161.90
Bond
  • 1% of the subtotal
$1,431.62
Insurance
  • 0.5% of the subtotal
$715.81
Bid total
  • The price you submit
$145,309.33

See it in Bidfident

Labour by trade Aerial and underground lines each take their own trade's rate from your library. 33 sec
Site costs that follow the schedule Traffic control and the foreman by the week, following however many weeks the route takes. 38 sec
Totals as you go Labor, cable and equipment totals as you go. Tick the aerial lines to total just those. 27 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can I price aerial and underground fiber differently?

Yes. Put each on its own line with its own trade, hours per foot and material price. The aerial line can carry the bucket truck by the hour.

Can I add waste for slack and cut-offs?

Yes. Each line's material price has a waste percentage, so the extra cable is priced into the line.

Can I price cable by the reel?

Yes. Units are free text, so LF, EA or reel all work. Bidfident doesn't convert between units, so keep each line in the unit its price is in.

Does traffic control follow the length of the job?

Yes. Weekly and monthly items follow the job duration in weeks, and part weeks such as 1.5 are allowed.

Can it measure the route from a map?

No. Type your footage in, or copy and paste it from your own spreadsheet.

Can I carry an underground alternate next to the aerial route?

Yes. Enter the underground lines and switch them off. They stay on the sheet struck through, and their cost is shown beside the totals, not counted in the bid.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.
