Bidfident for excavation contractors

Estimating software for excavation

Pricing a dig in Bidfident starts with the cubic metre. Bulk excavation, footing and trench digging, topsoil stripping and compacted backfill each go on their own line, with operator and labourer hours, granular fill with a waste percentage, and the excavator, dozer or roller charged for the hours it runs. Carry trucking and disposal as a subtrade, and the superintendent by the week.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • The excavator charged for the whole day

    A spreadsheet often charges the excavator for every hour the crew is on site, even while it waits on trucks. Over 3,000 cubic metres that adds up fast. In Bidfident each line's equipment has its own hours per unit, so bulk digging and footings each carry the machine time they really need.

  • Haul quotes that never line up

    Three trucking outfits quote off-site disposal by phone, email and text, and the best number gets lost. In Bidfident their bids sit side by side, the lowest is flagged, and it's carried unless you pick another.

  • Backfill that comes up short

    Granular fill priced at the exact volume leaves nothing for spillage and over-dig. In Bidfident each material price carries its own waste percentage, so the extra stone is in the price on that line.

How Bidfident fits your work

  • Bidfident screenshot: excavator hours apart from the crew's

    Excavator hours apart from the crew's

    Give the excavator, dozer or roller its own hours per unit on each line, and it's charged for those hours, not the operator's. Leave it blank and the machine runs for the crew's hours.

  • Bidfident screenshot: dig, strip and backfill by the cubic metre

    Dig, strip and backfill by the cubic metre

    Each line takes a quantity in m³ or m², hours per unit for the crew, a material price with a waste percentage, and equipment by the hour. Copy and paste, fill down, and undo anything, just like Excel.

  • Bidfident screenshot: trucking and disposal bids side by side

    Trucking and disposal bids side by side

    Enter each hauler's price for off-site disposal, see the lowest flagged, and carry it or the one you trust more. No quotes back yet? Carry a plug amount.

  • Bidfident screenshot: operators and labourers at their own rates

    Operators and labourers at their own rates

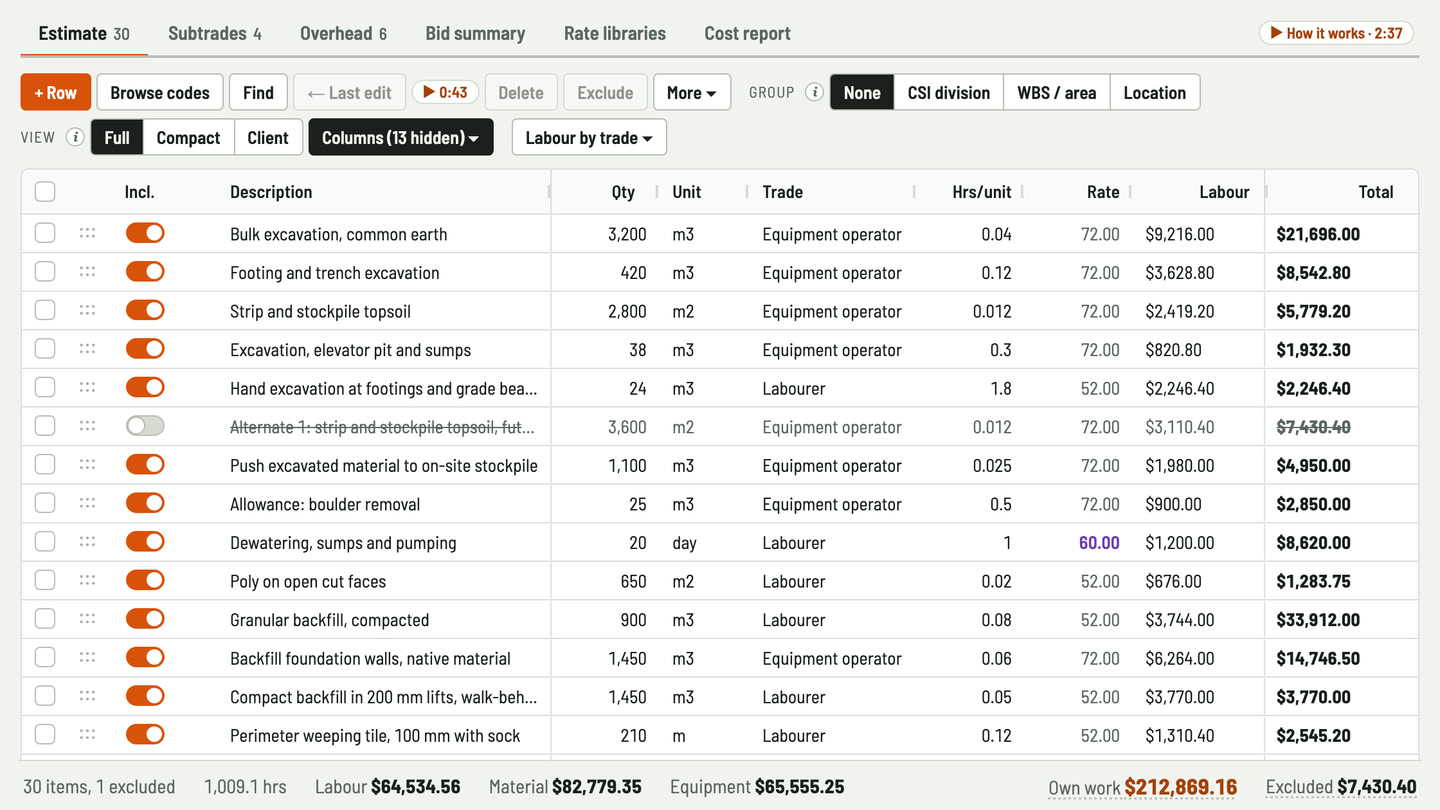

    Set a rate for each trade in the library: equipment operators on the digging lines, labourers on the backfill. A line with no trade uses the fallback rate.

  • Bidfident screenshot: superintendent by the week, layout as a lump sum

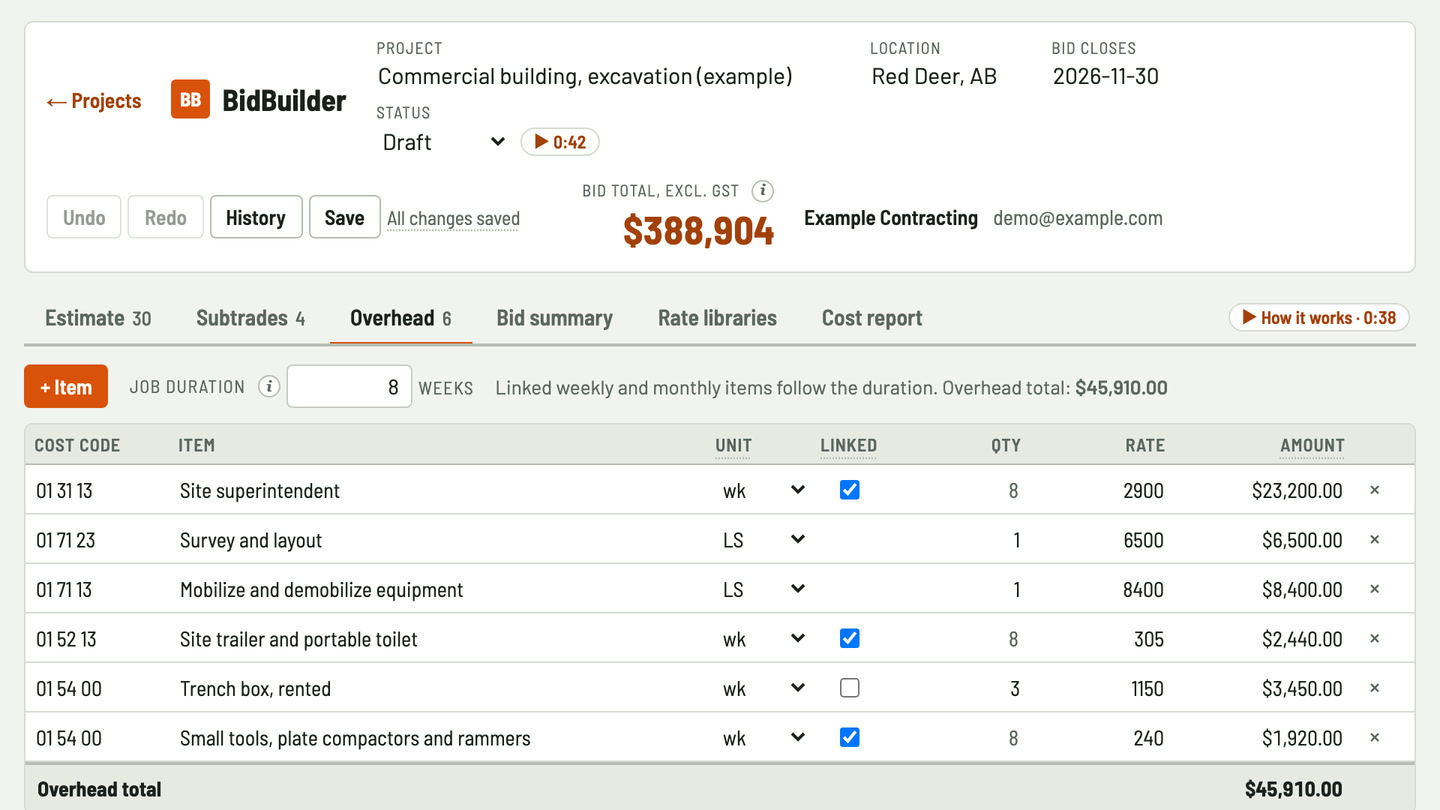

    Superintendent by the week, layout as a lump sum

    Add the superintendent by the week and link it to the job duration. Survey and layout can sit beside it as a lump sum.

  • Bidfident screenshot: earthwork totals by cost code

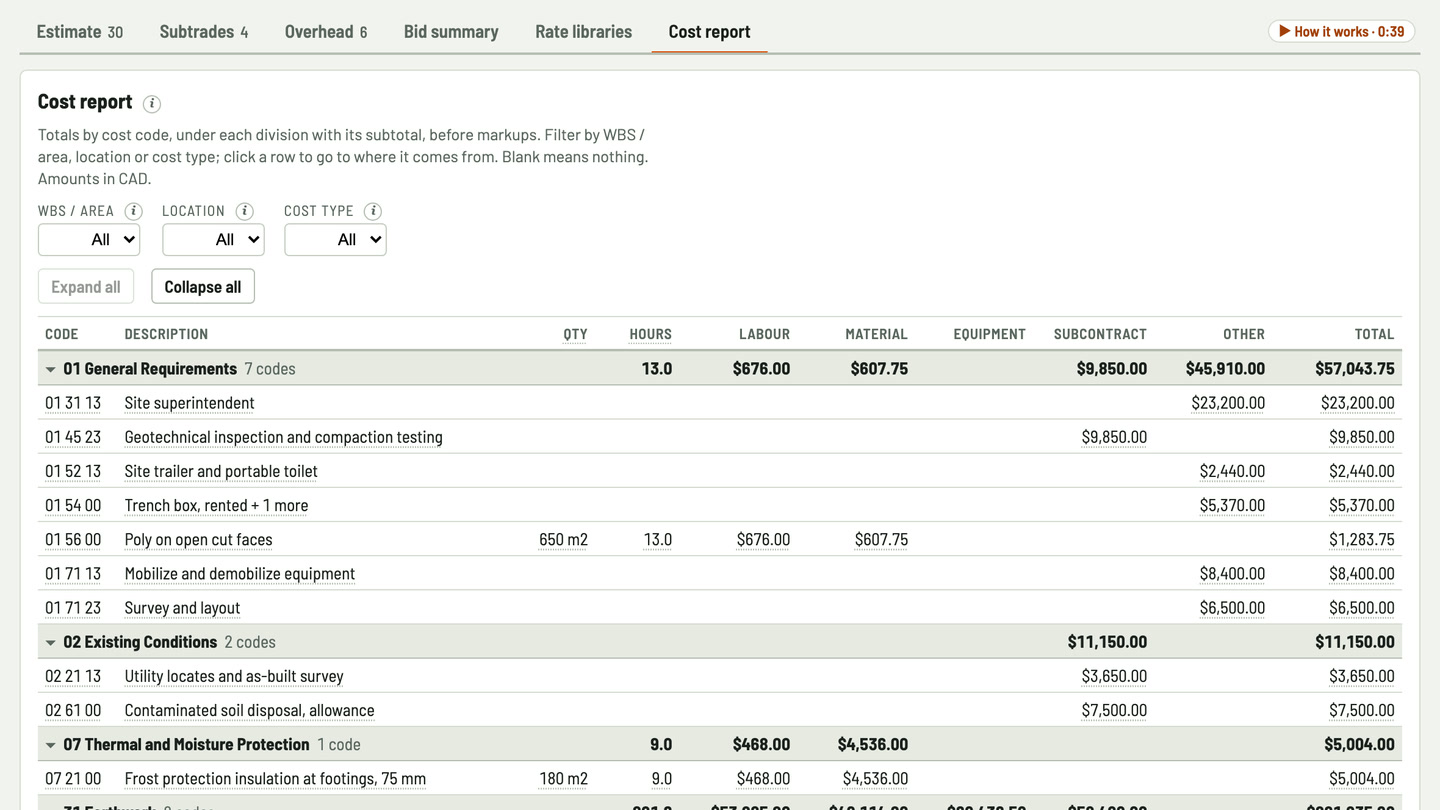

    Earthwork totals by cost code

    The cost report totals every code under its division, with subtotals. Where one code holds cubic and square metres, the quantity shows as mixed rather than adding them together.

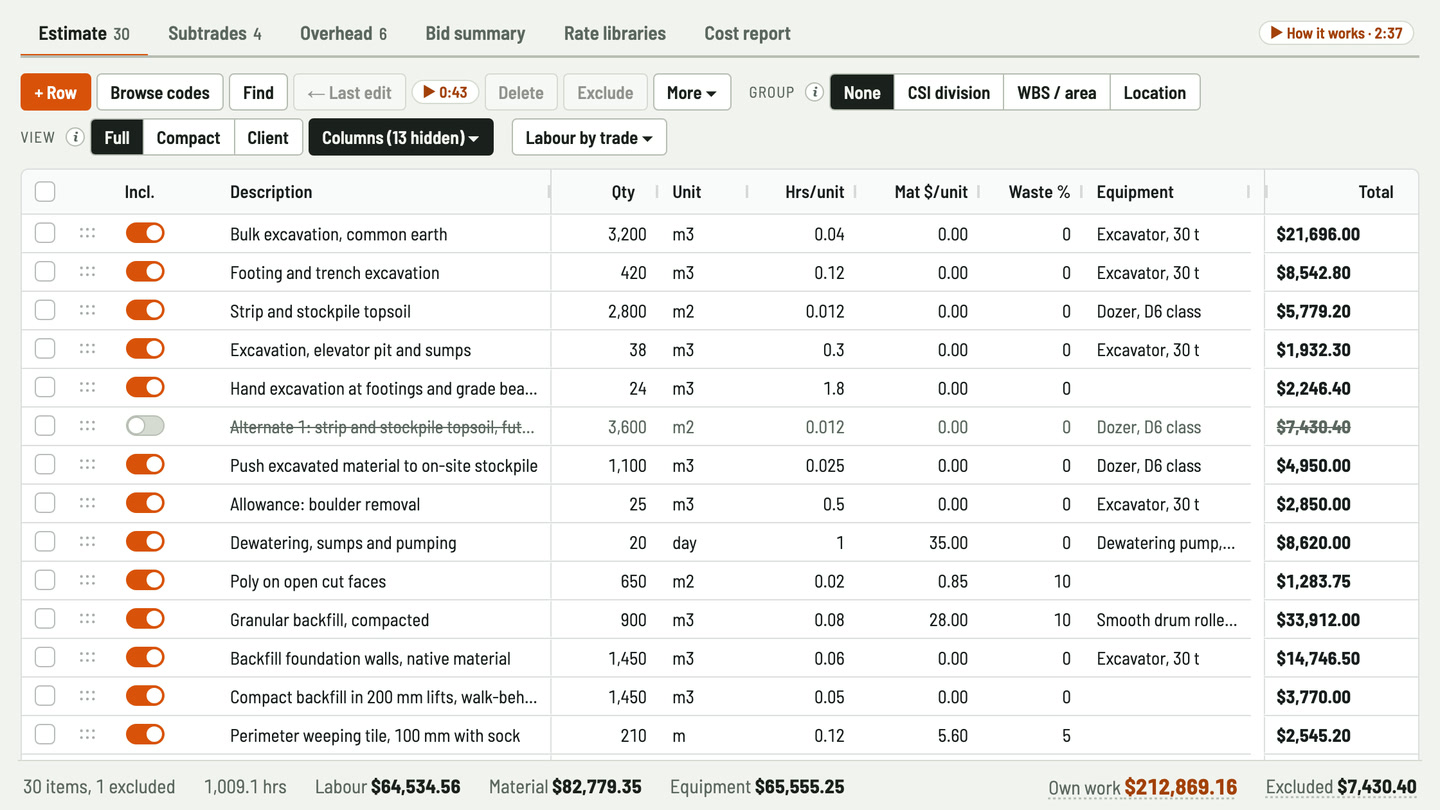

Worked example: excavation for a two-storey commercial building

A made-up job, priced in Bidfident: 29 lines of your own work, 4 subtrades and 6 overhead items over a 8-week job. The 4 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in Canada, then on the Projects screen, under Example project, pick "Civil and site work" and "Excavation" and press Add example project.

Your own work
ItemAmount
Bulk excavation, common earth, 3,200 m3
  • Labour: 3,200 m3 × 0.04 hrs = 128 hrs at $72.00/hr (equipment operator) = $9,216.00
  • Equipment: excavator, 30 t, 3,200 m3 × 0.02 hrs = 64 hrs, less than the crew, at $195.00/hr = $12,480.00
$21,696.00
Footing and trench excavation, 420 m3
  • Labour: 420 m3 × 0.12 hrs = 50.4 hrs at $72.00/hr (equipment operator) = $3,628.80
  • Equipment: excavator, 30 t, 420 m3 × 0.06 hrs = 25.2 hrs, less than the crew, at $195.00/hr = $4,914.00
$8,542.80
Strip and stockpile topsoil, 2,800 m2
  • Labour: 2,800 m2 × 0.012 hrs = 33.6 hrs at $72.00/hr (equipment operator) = $2,419.20
  • Equipment: dozer, d6 class, 2,800 m2 × 0.008 hrs = 22.4 hrs, less than the crew, at $150.00/hr = $3,360.00
$5,779.20
Granular backfill, compacted, 900 m3
  • Labour: 900 m3 × 0.08 hrs = 72 hrs at $52.00/hr (labourer) = $3,744.00
  • Material: 900 m3 × $28.00 + 10% waste = $27,720.00
  • Equipment: smooth drum roller, 10 t, 900 m3 × 0.04 hrs = 36 hrs, less than the crew, at $68.00/hr = $2,448.00
$33,912.00

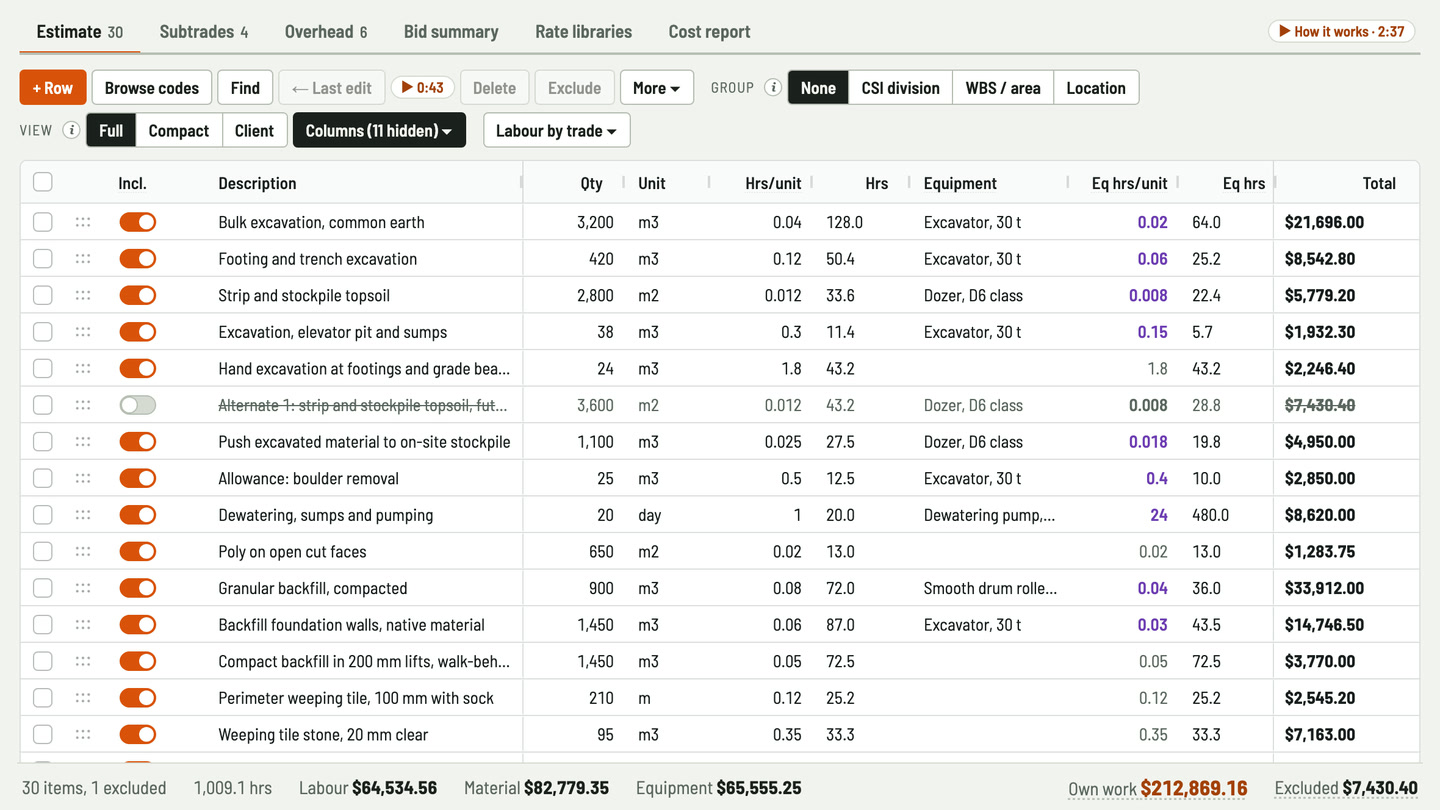

25 more lines of your own work
  • Labour $45,526.56 + material $55,059.35 + equipment $42,353.25
  • 1 more line is priced but left out of the total
$142,939.16
Subtrades

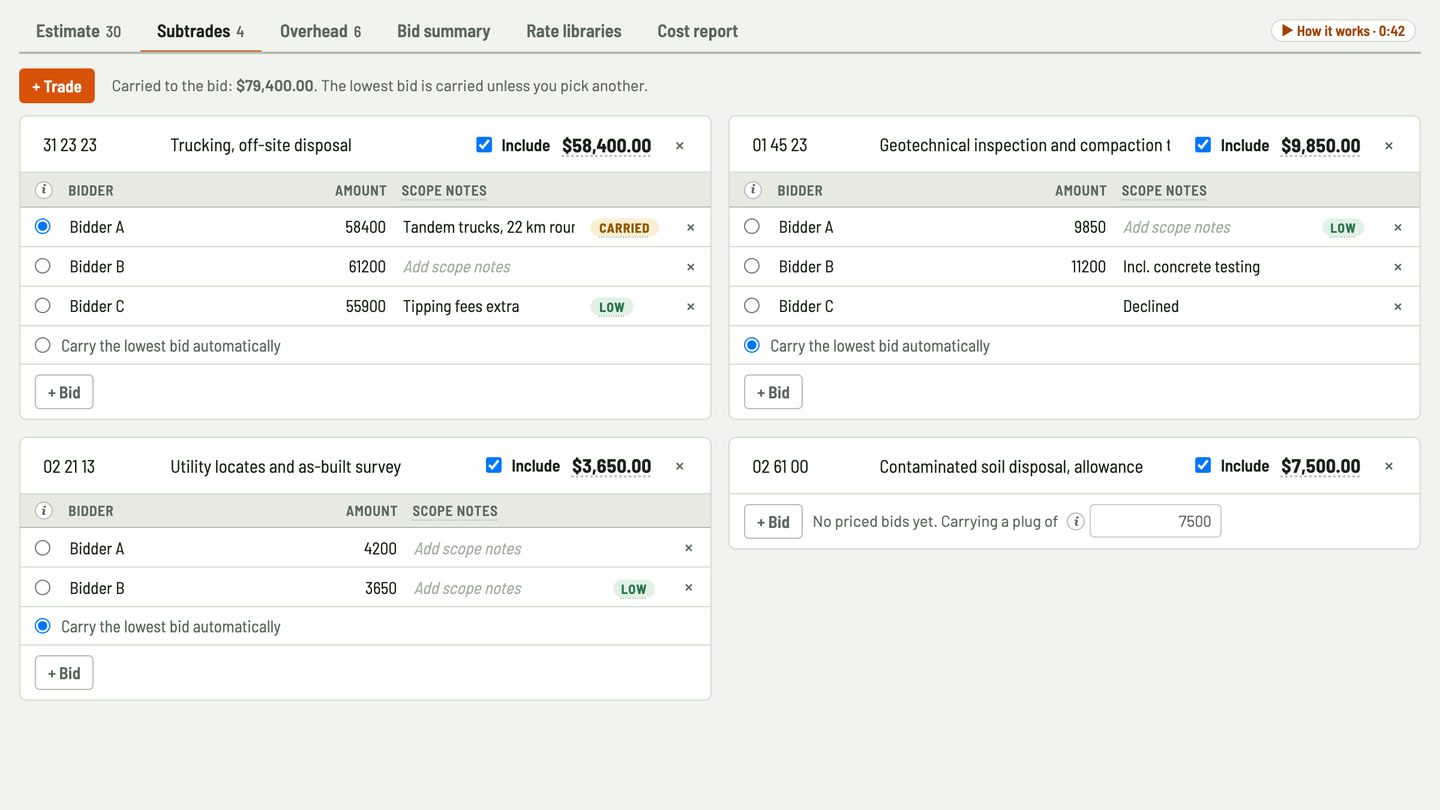

ItemAmount
Trucking, off-site disposal
  • Bids: Bidder A $58,400.00, Bidder B $61,200.00, Bidder C $55,900.00
  • Carrying the picked bid: Bidder A
$58,400.00
Geotechnical inspection and compaction testing
  • Bids: Bidder A $9,850.00, Bidder B $11,200.00
  • Carrying the lowest: Bidder A
$9,850.00
Utility locates and as-built survey
  • Bids: Bidder A $4,200.00, Bidder B $3,650.00
  • Carrying the lowest: Bidder B
$3,650.00
Contaminated soil disposal, allowance
  • No bids yet: carrying the plug amount
$7,500.00
Overhead
ItemAmount
Site superintendent
  • 8 wk × $2,900.00, following the job duration
$23,200.00
Survey and layout
  • 1 LS × $6,500.00
$6,500.00
Mobilize and demobilize equipment
  • 1 LS × $8,400.00
$8,400.00
Site trailer and portable toilet
  • 8 wk × $305.00, following the job duration
$2,440.00
Trench box, rented
  • 3 wk × $1,150.00
$3,450.00
Small tools, plate compactors and rammers
  • 8 wk × $240.00, following the job duration
$1,920.00
Bid summary
ItemAmount
Own work
  • Labour $64,534.56 + material $82,779.35 + equipment $65,555.25
$212,869.16
Excluded lines, not counted$7,430.40
Subtrades$79,400.00
Overhead
  • 8 weeks
$45,910.00
Direct cost
  • Own work + subtrades + overhead
$338,179.16
Contingency
  • 3% of direct cost
$10,145.37
Fee
  • 10% of direct cost plus contingency
$34,832.45
Subtotal before bonding$383,156.98
Bonding
  • 1% of the subtotal
$3,831.57
Insurance
  • 0.5% of the subtotal
$1,915.78
Bid total
  • The price you submit, before GST
$388,904.33
GST, for reference
  • 5%, shown separately and not part of the bid total
$19,445.22

See it in Bidfident

Equipment that runs less than the crew Bulk excavation with the excavator on its own hours per cubic metre, apart from the operator's. 30 sec
Bids side by side Three hauling quotes for off-site disposal, the lowest flagged and carried unless you pick another. 42 sec
Totals by cost code Excavation, backfill and topsoil totals under each cost code, with a subtotal for each division. 39 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can I charge the excavator for fewer hours than the operator?

Yes. Type the excavator's own hours per unit on the line. Leave it blank and it runs for the operator's hours.

Can I add a waste percentage to backfill?

Yes. Every line's material price has its own waste percentage, so 10% on granular fill is added on that line only.

Can I price in cubic yards instead of cubic metres?

Yes, units are free text, so cy and m³ both work. Bidfident doesn't convert between them, so price each line in the unit its rate is in.

What if the trucking quotes aren't in yet?

Carry a plug amount for trucking until the bids arrive, then enter them side by side and carry the one you want.

Does it work out cut volumes from a site plan?

No. Bidfident doesn't read drawings, plans or survey files. Type your volumes in, or paste them into the sheet.

Can I price rock apart from common earth?

Yes. Put rock on its own line with its own hours per cubic metre and its own equipment, like a hydraulic hammer by the hour. Each line is charged for its own machine time.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.

Price your next excavation bid in Bidfident

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.
