Pricing a dig in Bidfident starts with the cubic yard. Mass excavation, footing and trench digging, topsoil stripping and compacted granular backfill each go on their own line, with operator and laborer hours, fill material with a waste percentage, and the excavator, dozer or roller charged for the hours it runs. Carry trucking and haul-off as a sub bid, and the super by the week.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • The excavator charged for the whole day

    A spreadsheet often charges the excavator for every hour the crew is on site, even while it waits on trucks. Over 4,000 cubic yards that adds up fast. In Bidfident each line's equipment has its own hours per unit, so mass excavation and footings each carry the machine time they really need.

  • Haul-off numbers that never line up

    Three trucking outfits quote haul-off by phone, email and text, and the best number gets lost. In Bidfident their bids sit side by side on the Subcontractors tab, the lowest is flagged, and it's carried unless you pick another.

  • Backfill that comes up short

    Granular fill priced at the exact volume leaves nothing for spillage and over-excavation. In Bidfident each material price carries its own waste percentage, so the extra stone is in the price on that line.

How Bidfident fits your work

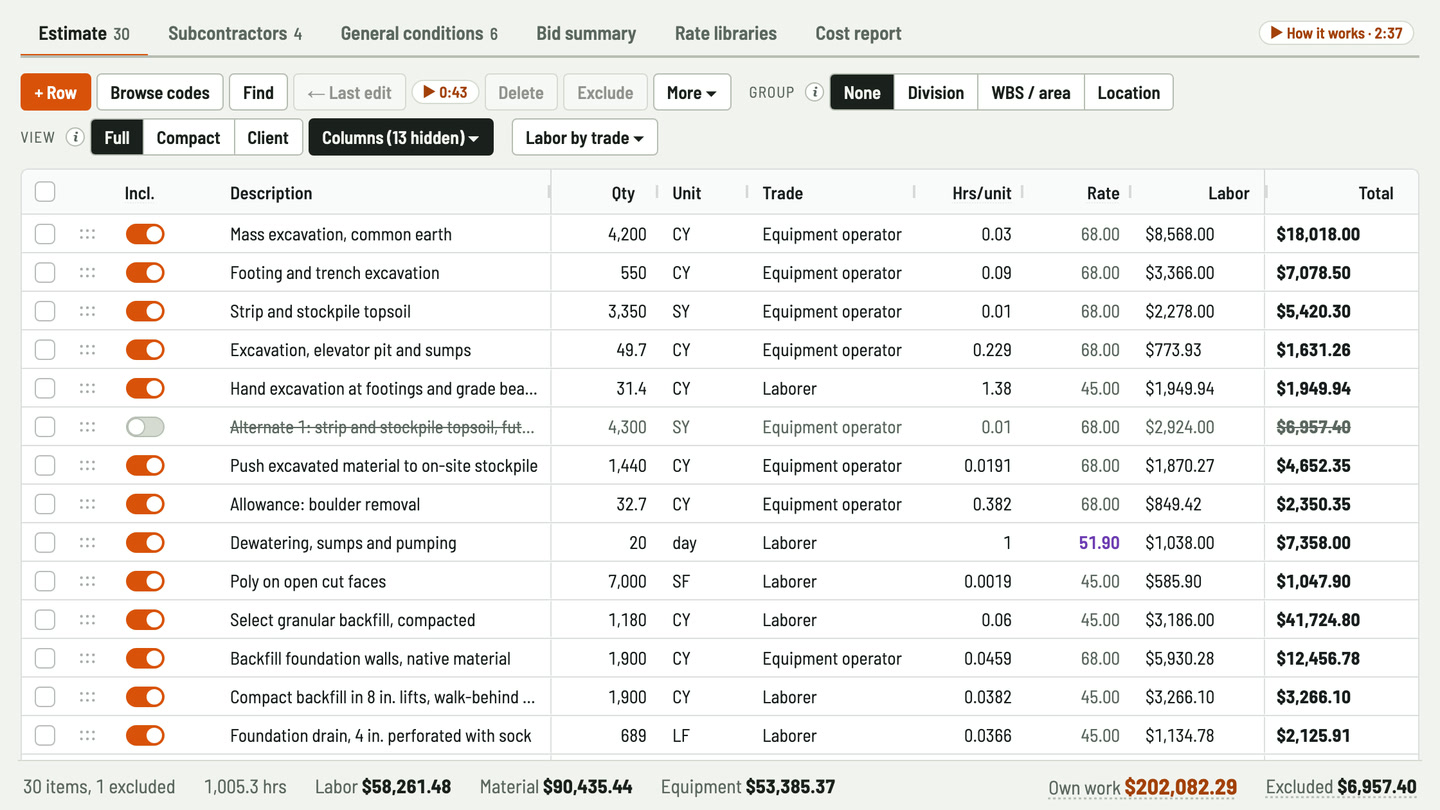

  • Bidfident screenshot: excavator hours apart from the crew's

    Excavator hours apart from the crew's

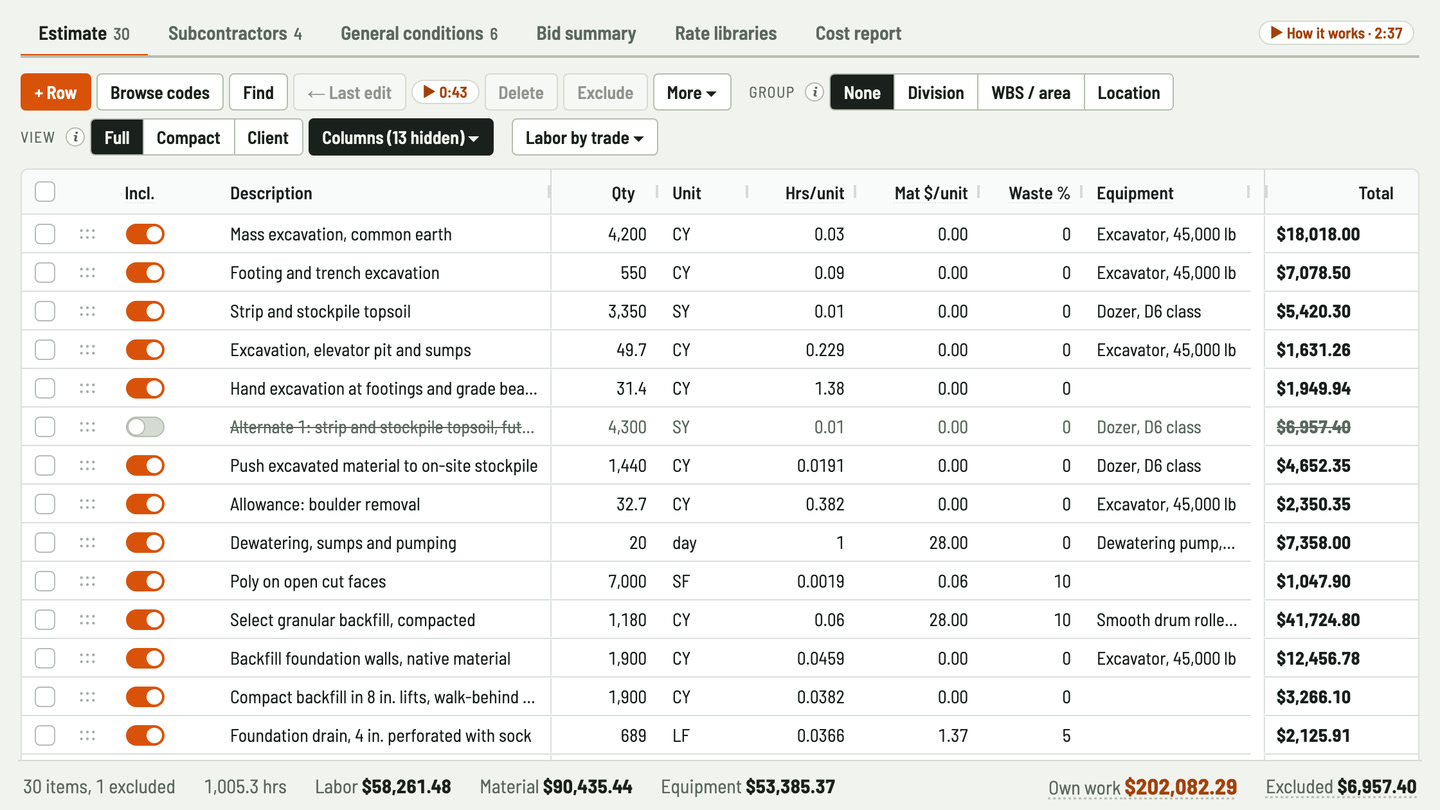

    Give the excavator, dozer or roller its own hours per unit on each line, and it's charged for those hours, not the operator's. Leave it blank and the machine runs for the crew's hours.

  • Bidfident screenshot: dig, strip and backfill by the cubic yard

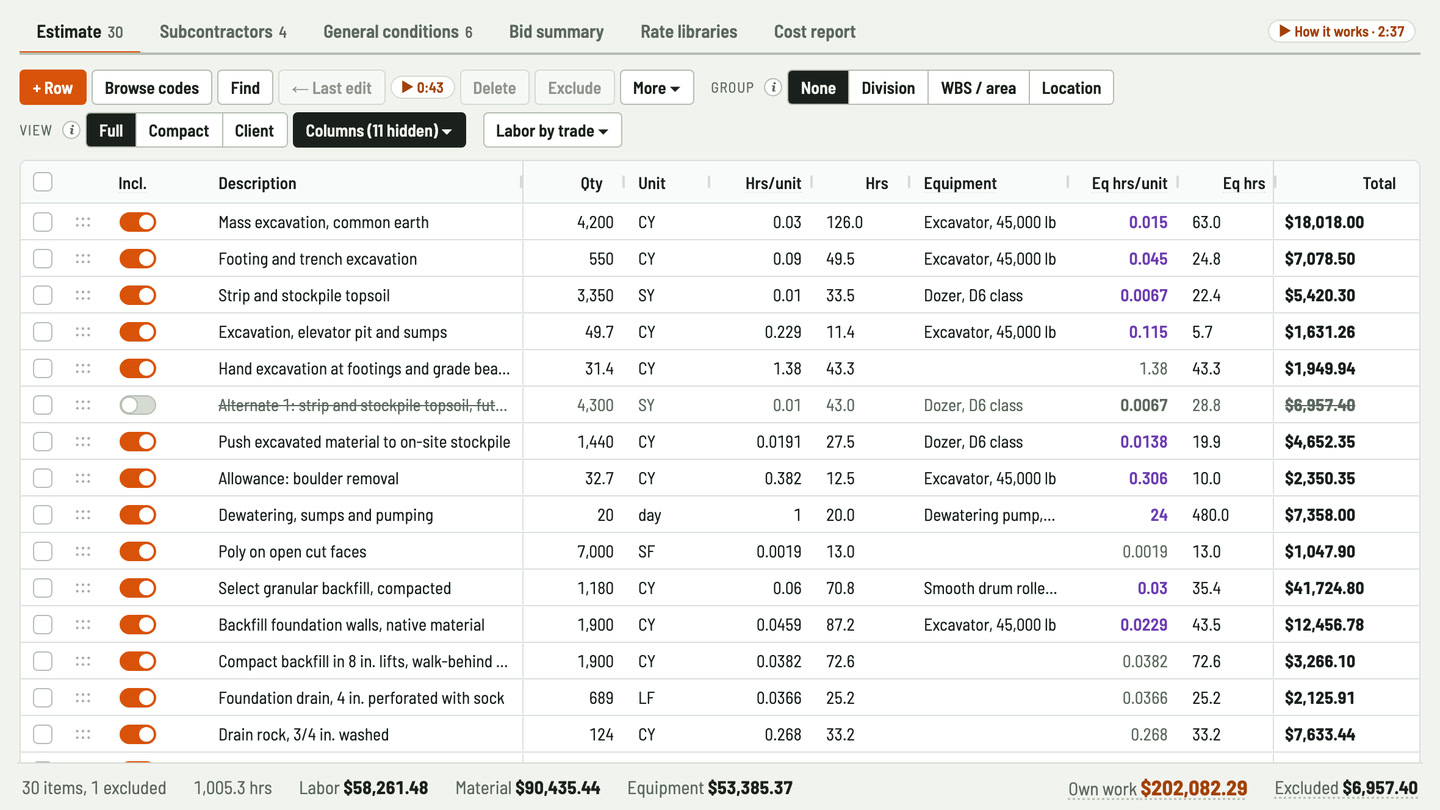

    Dig, strip and backfill by the cubic yard

    Each line takes a quantity in CY or SY, crew hours per unit, a material price with a waste percentage, and equipment by the hour. Copy and paste, fill down, and undo anything, just like Excel.

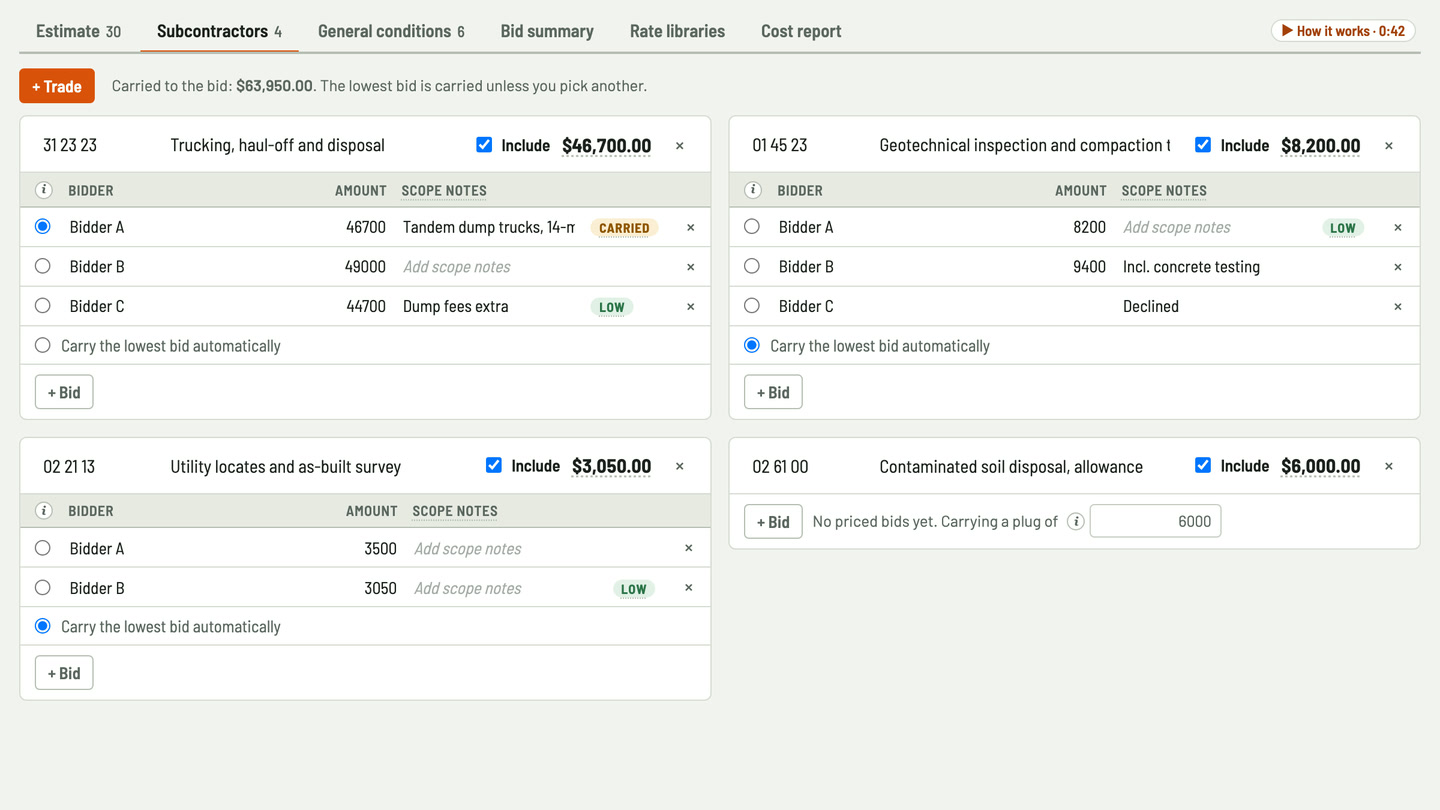

  • Bidfident screenshot: trucking and haul-off bids side by side

    Trucking and haul-off bids side by side

    Enter each trucker's number for haul-off, see the lowest flagged, and carry it or the one you trust more. No numbers back yet? Carry a plug number.

  • Bidfident screenshot: operators and laborers at their own rates

    Operators and laborers at their own rates

    Set a rate for each trade in the library: equipment operators on the digging lines, laborers on the backfill. A line with no trade uses the fallback rate.

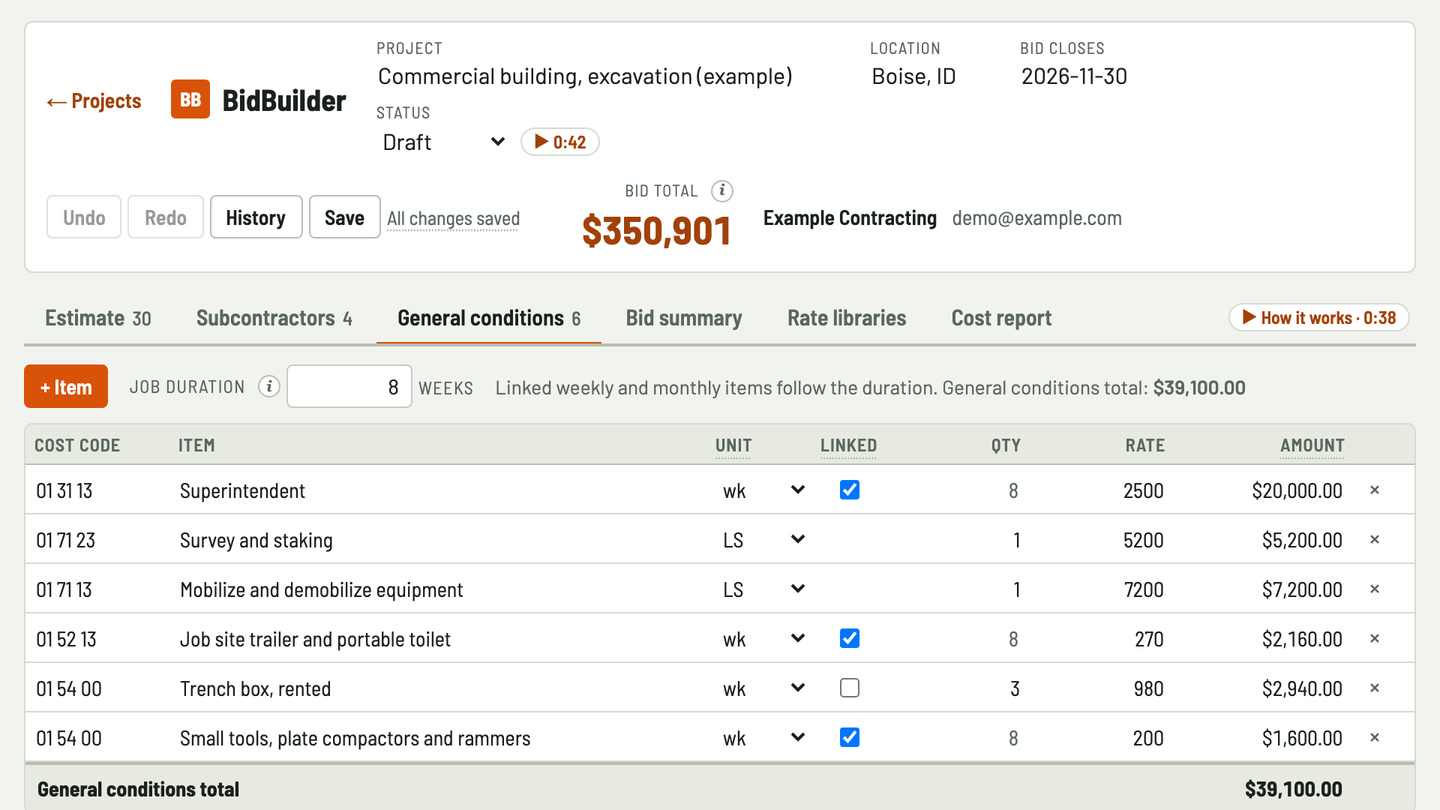

  • Bidfident screenshot: the super by the week, staking as a lump sum

    The super by the week, staking as a lump sum

    Add the superintendent by the week and link it to the job duration. Survey and staking can sit beside it as a lump sum.

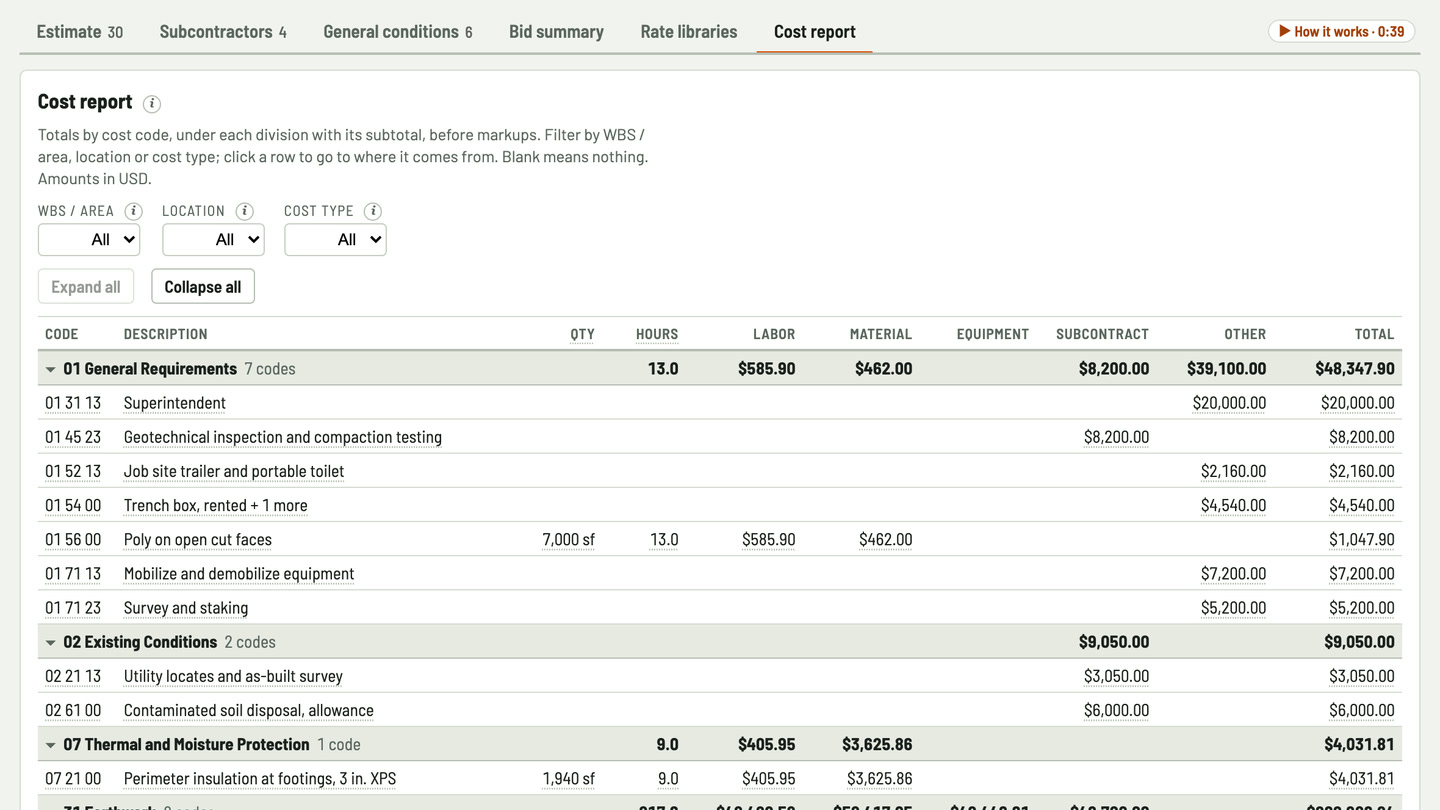

  • Bidfident screenshot: earthwork totals by cost code

    Earthwork totals by cost code

    The cost report totals every code under its division, with subtotals. Where one code holds cubic yards and square yards, the quantity shows as mixed rather than adding them together.

Worked example: excavation for a two-story commercial building

A made-up job, priced in Bidfident: 29 lines of your own work, 4 subs and 6 general conditions items over a 8-week job. The 4 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in the US, then on the Projects screen, under Example project, pick "Sitework and civil" and "Excavation" and press Add example project.

Your own work
ItemAmount
Mass excavation, common earth, 4,200 CY
  • Labor: 4,200 CY × 0.03 hrs = 126 hrs at $68.00/hr (equipment operator) = $8,568.00
  • Equipment: excavator, 45,000 lb, 4,200 CY × 0.015 hrs = 63 hrs, less than the crew, at $150.00/hr = $9,450.00
$18,018.00
Footing and trench excavation, 550 CY
  • Labor: 550 CY × 0.09 hrs = 49.5 hrs at $68.00/hr (equipment operator) = $3,366.00
  • Equipment: excavator, 45,000 lb, 550 CY × 0.045 hrs = 24.75 hrs, less than the crew, at $150.00/hr = $3,712.50
$7,078.50
Strip and stockpile topsoil, 3,350 SY
  • Labor: 3,350 SY × 0.01 hrs = 33.5 hrs at $68.00/hr (equipment operator) = $2,278.00
  • Equipment: dozer, d6 class, 3,350 SY × 0.0067 hrs = 22.45 hrs, less than the crew, at $140.00/hr = $3,142.30
$5,420.30
Select granular backfill, compacted, 1,180 CY
  • Labor: 1,180 CY × 0.06 hrs = 70.8 hrs at $45.00/hr (laborer) = $3,186.00
  • Material: 1,180 CY × $28.00 + 10% waste = $36,344.00
  • Equipment: smooth drum roller, 10 ton, 1,180 CY × 0.03 hrs = 35.4 hrs, less than the crew, at $62.00/hr = $2,194.80
$41,724.80
25 more lines of your own work
  • Labor $40,863.48 + material $54,091.44 + equipment $34,885.77
  • 1 more line is priced but left out of the total
$129,840.69
Subcontractors
ItemAmount
Trucking, haul-off and disposal
  • Bids: Bidder A $46,700.00, Bidder B $49,000.00, Bidder C $44,700.00
  • Carrying the chosen bid: Bidder A
$46,700.00
Geotechnical inspection and compaction testing
  • Bids: Bidder A $8,200.00, Bidder B $9,400.00
  • Carrying the lowest: Bidder A
$8,200.00
Utility locates and as-built survey
  • Bids: Bidder A $3,500.00, Bidder B $3,050.00
  • Carrying the lowest: Bidder B
$3,050.00
Contaminated soil disposal, allowance
  • No bids yet: carrying a plug number
$6,000.00
General conditions
ItemAmount
Superintendent
  • 8 wk × $2,500.00, following the job duration
$20,000.00
Survey and staking
  • 1 LS × $5,200.00
$5,200.00
Mobilize and demobilize equipment
  • 1 LS × $7,200.00
$7,200.00
Job site trailer and portable toilet
  • 8 wk × $270.00, following the job duration
$2,160.00
Trench box, rented
  • 3 wk × $980.00
$2,940.00
Small tools, plate compactors and rammers
  • 8 wk × $200.00, following the job duration
$1,600.00
Bid summary
ItemAmount
Own work
  • Labor $58,261.48 + material $90,435.44 + equipment $53,385.37
$202,082.29
Excluded lines, not counted$6,957.40
Subcontractors$63,950.00
General conditions
  • 8 weeks
$39,100.00
Direct cost
  • Own work + subcontractors + general conditions
$305,132.29
Contingency
  • 3% of direct cost
$9,153.97
Fee
  • 10% of direct cost plus contingency
$31,428.63
Subtotal before the bond$345,714.89
Bond
  • 1% of the subtotal
$3,457.15
Insurance
  • 0.5% of the subtotal
$1,728.57
Bid total
  • The price you submit
$350,900.61

See it in Bidfident

Equipment that runs less than the crew Mass excavation with the excavator on its own hours per cubic yard, apart from the operator's. 30 sec
Bids side by side Three trucking bids for haul-off, the lowest flagged and carried unless you pick another. 42 sec
Totals by cost code Excavation, backfill and topsoil totals under each cost code, with a subtotal for each division. 39 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can I charge the excavator for fewer hours than the operator?

Yes. Type the excavator's own hours per unit on the line. Leave it blank and it runs for the operator's hours.

Can I add a waste percentage to backfill?

Yes. Every line's material price has its own waste percentage, so 10% on granular fill is added on that line only.

Can I price haul-off by the load or the ton?

Yes, units are free text, so loads, ton and CY all work. Bidfident doesn't convert between them, so price each line in the unit its rate is in.

What if the trucking bids aren't in yet?

Carry a plug number for trucking until the bids arrive, then enter them side by side and carry the one you want.

Does it figure cut volumes from a site plan?

No. Bidfident doesn't read plans, drawings or survey files. Type your volumes in, or paste them into the sheet.

Can I price rock apart from common earth?

Yes. Put rock on its own line with its own hours per cubic yard and its own equipment, like a hoe ram by the hour. Each line is charged for its own machine time.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.
