Bidfident for grading contractors

Estimating software for grading and earthwork

Bidfident is built for estimators who price grading by the square metre and the cubic metre. Strip topsoil, cut and fill, fine grade, proof roll and respread on separate lines, give the dozer, motor grader and roller their own hours apart from the operator's, carry survey and grade checks as a subtrade, and keep silt fence and erosion control in the site costs.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • Dozer and grader time lumped in with the crew

    Rough grading and fine grading use different machines for very different hours, but a spreadsheet row often has one blended rate. In Bidfident each line names its own equipment with its own hours per unit, apart from the operator's.

  • Big areas, tiny rates

    On a 14,500 square metre field, a slip in hours per square metre moves the price by thousands. Bidfident keeps the bid total in view and briefly shows how much it moved after each change, so a slip shows at once.

  • The same area on five lines

    Strip, fine grade, proof roll and respread all use the field's area, and when it changes some rows get missed. In Bidfident the sheet fills down like Excel, and every change is one undo step if you go too far.

How Bidfident fits your work

  • Bidfident screenshot: dozer, grader and roller for their own hours

    Dozer, grader and roller for their own hours

    A cut and fill line can carry the dozer at its own hours per cubic metre, and fine grading the motor grader at its own hours per square metre. Each machine is charged for the time it runs.

  • Bidfident screenshot: every pass on its own line

    Every pass on its own line

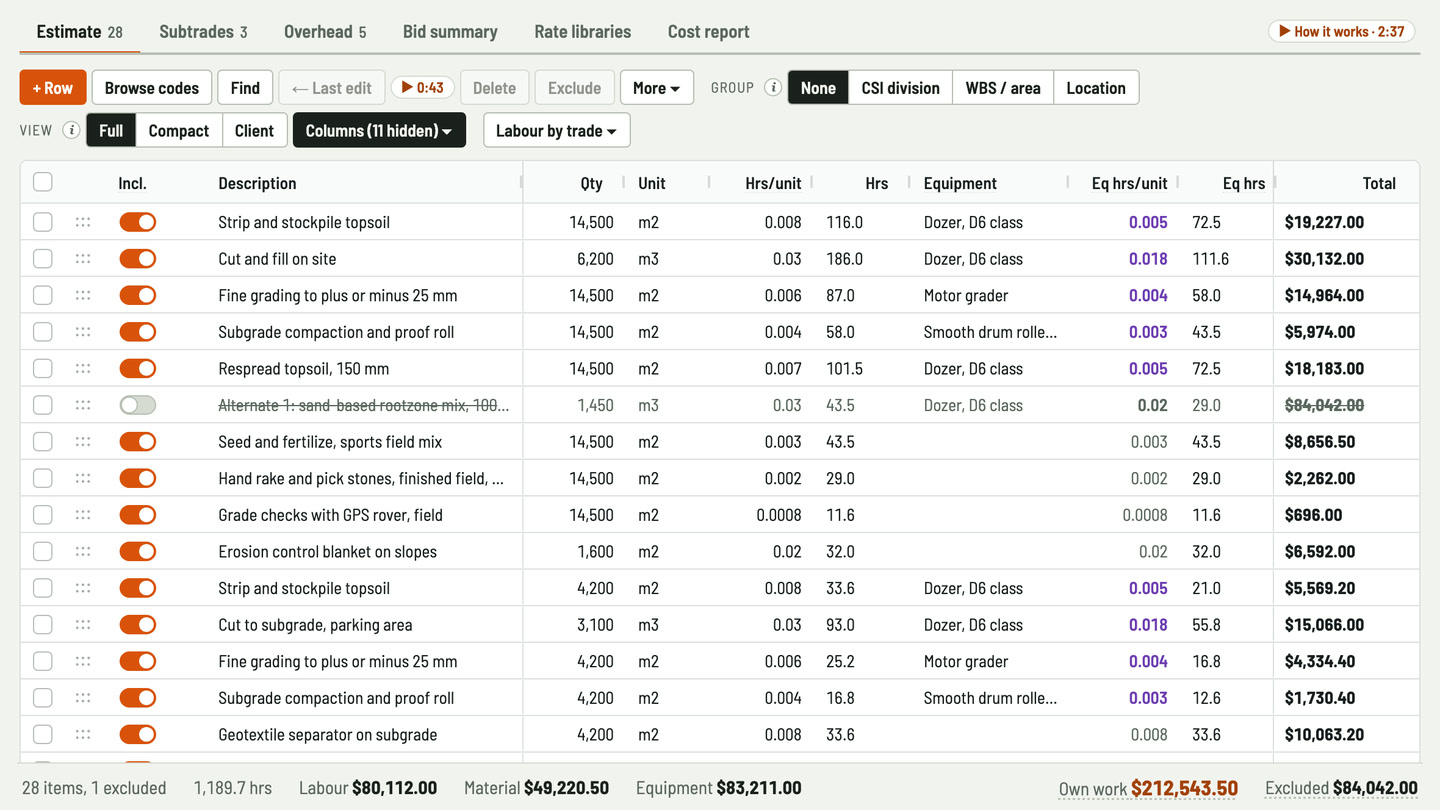

    Strip, cut and fill, fine grade, proof roll and respread each get a line with a quantity, a unit, crew hours per unit and equipment. Totals update as you type.

  • Bidfident screenshot: production rates kept in the library

    Production rates kept in the library

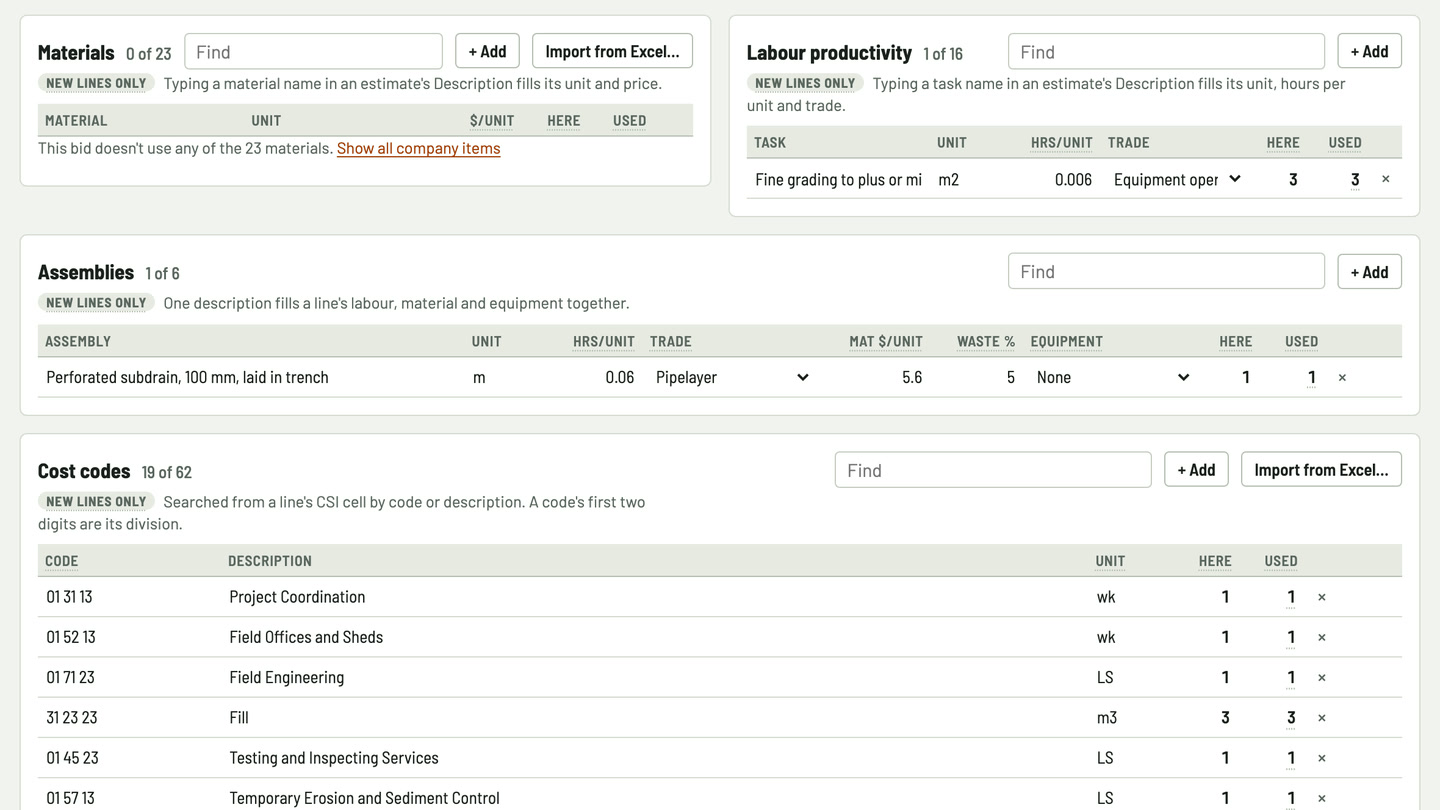

    Save tasks with their hours per unit, like fine grading per square metre, in the company library. Every estimate picks up the same production rates.

  • Bidfident screenshot: survey and grade checks as a subtrade

    Survey and grade checks as a subtrade

    Enter each surveyor's price side by side, see the lowest flagged, and carry it or another you pick.

  • Bidfident screenshot: group by field, parking or access road

    Group by field, parking or access road

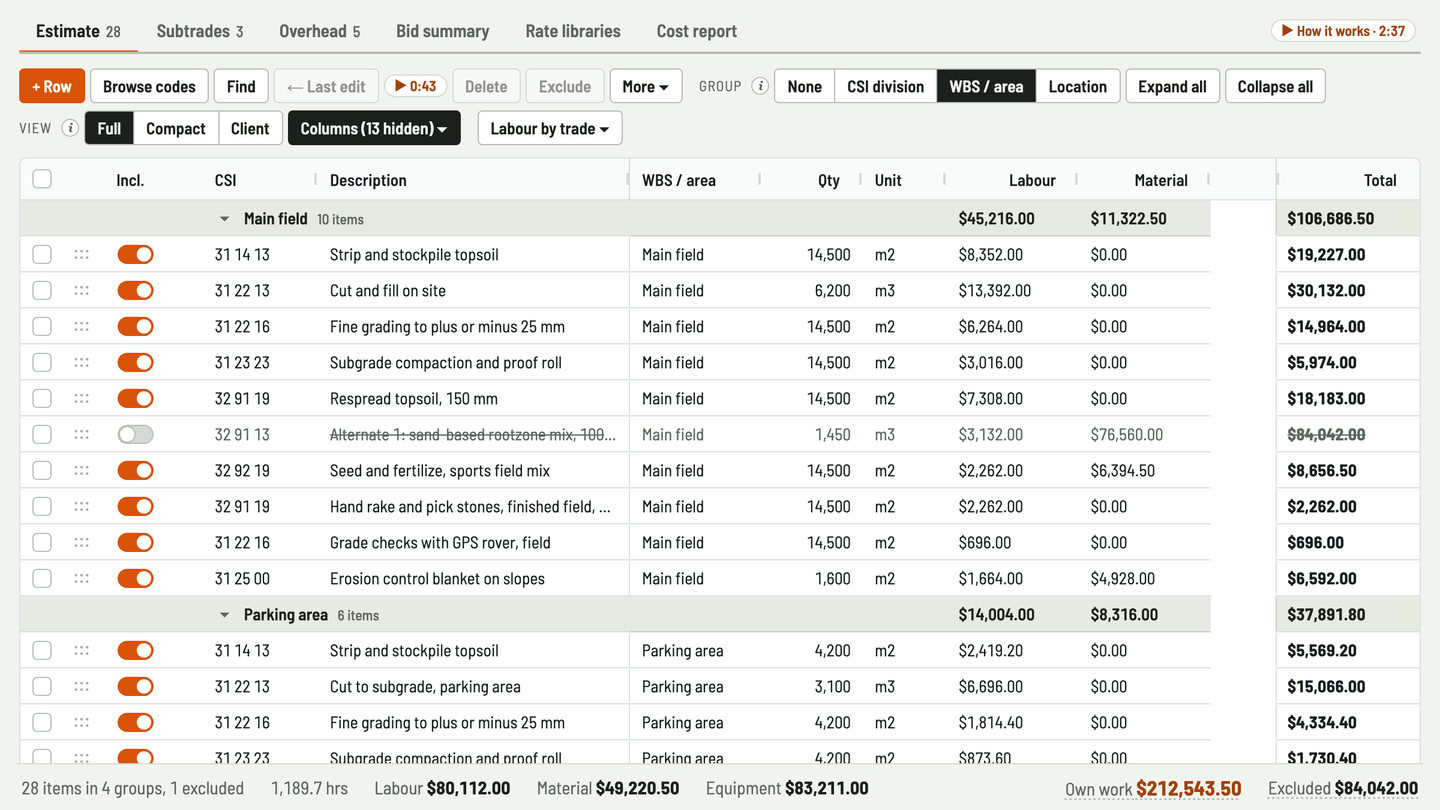

    Tag lines with an area, like the main field, the parking area or the access road, and group the sheet with a subtotal for each.

  • Bidfident screenshot: erosion control and supervision in site costs

    Erosion control and supervision in site costs

    Silt fence as a lump sum, the superintendent by the week. Linked weekly items follow the job duration, even part weeks like 4.5.

Worked example: rough and fine grading for a school sports field

A made-up job, priced in Bidfident: 27 lines of your own work, 3 subtrades and 5 overhead items over a 5-week job. The 5 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in Canada, then on the Projects screen, under Example project, pick "Civil and site work" and "Grading" and press Add example project.

Your own work
ItemAmount

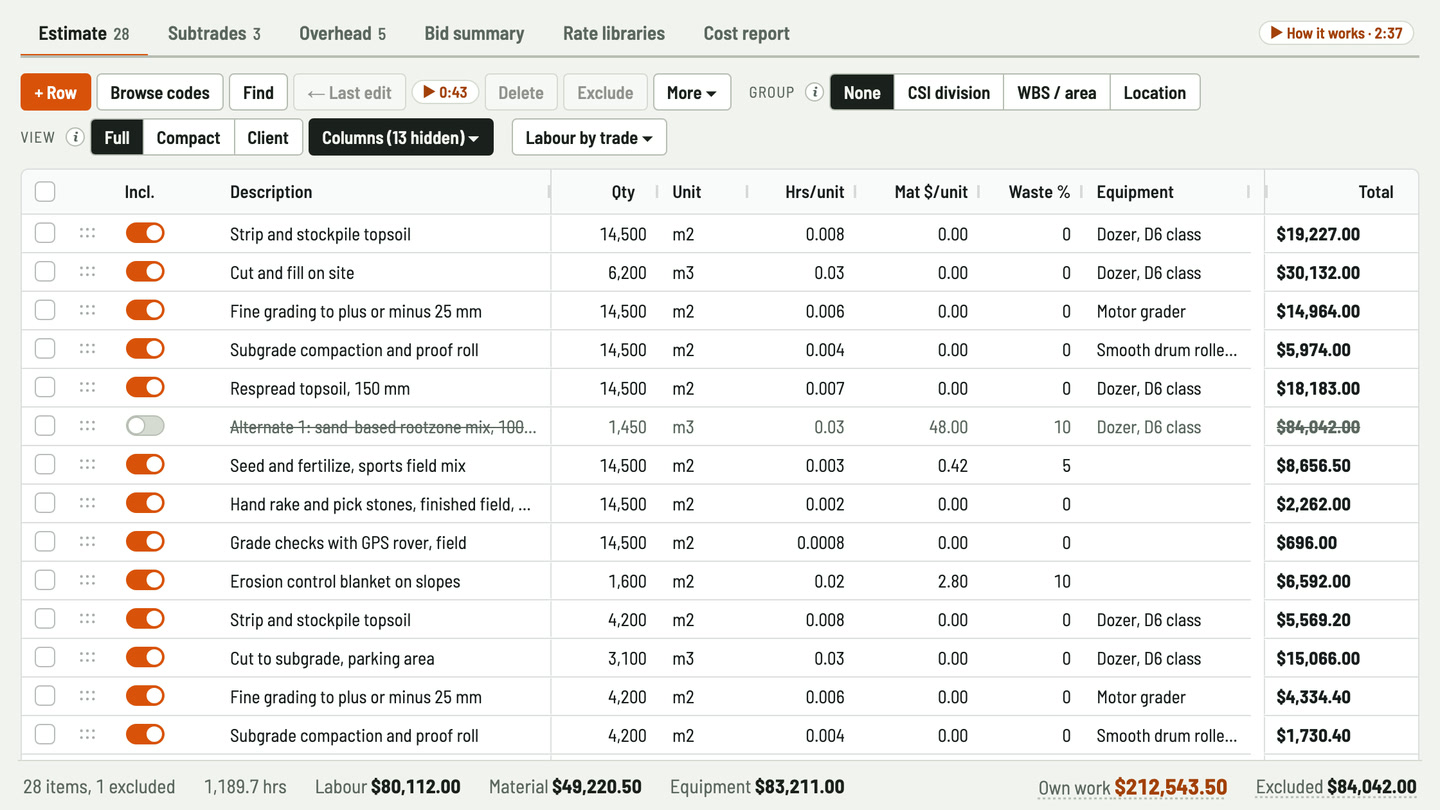

Strip and stockpile topsoil, 14,500 m2
  • Labour: 14,500 m2 × 0.008 hrs = 116 hrs at $72.00/hr (equipment operator) = $8,352.00
  • Equipment: dozer, d6 class, 14,500 m2 × 0.005 hrs = 72.5 hrs, less than the crew, at $150.00/hr = $10,875.00
$19,227.00
Cut and fill on site, 6,200 m3
  • Labour: 6,200 m3 × 0.03 hrs = 186 hrs at $72.00/hr (equipment operator) = $13,392.00
  • Equipment: dozer, d6 class, 6,200 m3 × 0.018 hrs = 111.6 hrs, less than the crew, at $150.00/hr = $16,740.00
$30,132.00
Fine grading to plus or minus 25 mm, 14,500 m2
  • Labour: 14,500 m2 × 0.006 hrs = 87 hrs at $72.00/hr (equipment operator) = $6,264.00
  • Equipment: motor grader, 14,500 m2 × 0.004 hrs = 58 hrs, less than the crew, at $150.00/hr = $8,700.00
$14,964.00
Subgrade compaction and proof roll, 14,500 m2
  • Labour: 14,500 m2 × 0.004 hrs = 58 hrs at $52.00/hr (labourer) = $3,016.00
  • Equipment: smooth drum roller, 10 t, 14,500 m2 × 0.003 hrs = 43.5 hrs, less than the crew, at $68.00/hr = $2,958.00
$5,974.00
Respread topsoil, 150 mm, 14,500 m2
  • Labour: 14,500 m2 × 0.007 hrs = 101.5 hrs at $72.00/hr (equipment operator) = $7,308.00
  • Equipment: dozer, d6 class, 14,500 m2 × 0.005 hrs = 72.5 hrs, less than the crew, at $150.00/hr = $10,875.00
$18,183.00
22 more lines of your own work
  • Labour $41,780.00 + material $49,220.50 + equipment $33,063.00
  • 1 more line is priced but left out of the total
$124,063.50
Subtrades
ItemAmount

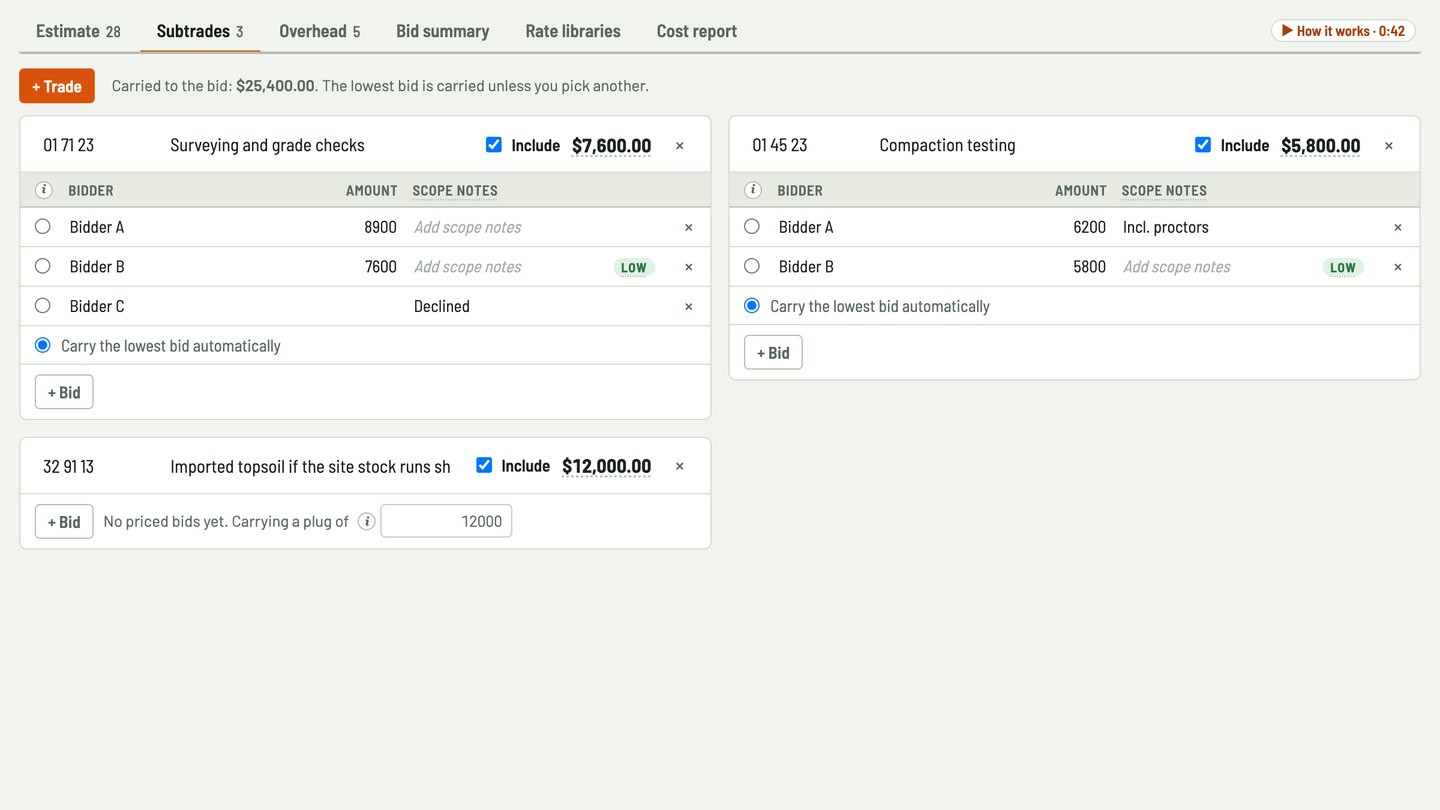

Surveying and grade checks
  • Bids: Bidder A $8,900.00, Bidder B $7,600.00
  • Carrying the lowest: Bidder B
$7,600.00
Compaction testing
  • Bids: Bidder A $6,200.00, Bidder B $5,800.00
  • Carrying the lowest: Bidder B
$5,800.00
Imported topsoil if the site stock runs short, allowance
  • No bids yet: carrying the plug amount
$12,000.00
Overhead
ItemAmount
Site superintendent
  • 5 wk × $2,900.00, following the job duration
$14,500.00
Silt fence and erosion control
  • 1 LS × $4,800.00
$4,800.00
Mobilize and demobilize equipment
  • 1 LS × $7,200.00
$7,200.00
Site trailer and portable toilet
  • 5 wk × $305.00, following the job duration
$1,525.00
Water truck, dust control
  • 10 day × $780.00
$7,800.00
Bid summary
ItemAmount
Own work
  • Labour $80,112.00 + material $49,220.50 + equipment $83,211.00
$212,543.50
Excluded lines, not counted$84,042.00
Subtrades$25,400.00
Overhead
  • 5 weeks
$35,825.00
Direct cost
  • Own work + subtrades + overhead
$273,768.50
Contingency
  • 3% of direct cost
$8,213.06
Fee
  • 10% of direct cost plus contingency
$28,198.16
Subtotal before bonding$310,179.72
Bonding
  • 1% of the subtotal
$3,101.80
Insurance
  • 0.5% of the subtotal
$1,550.90

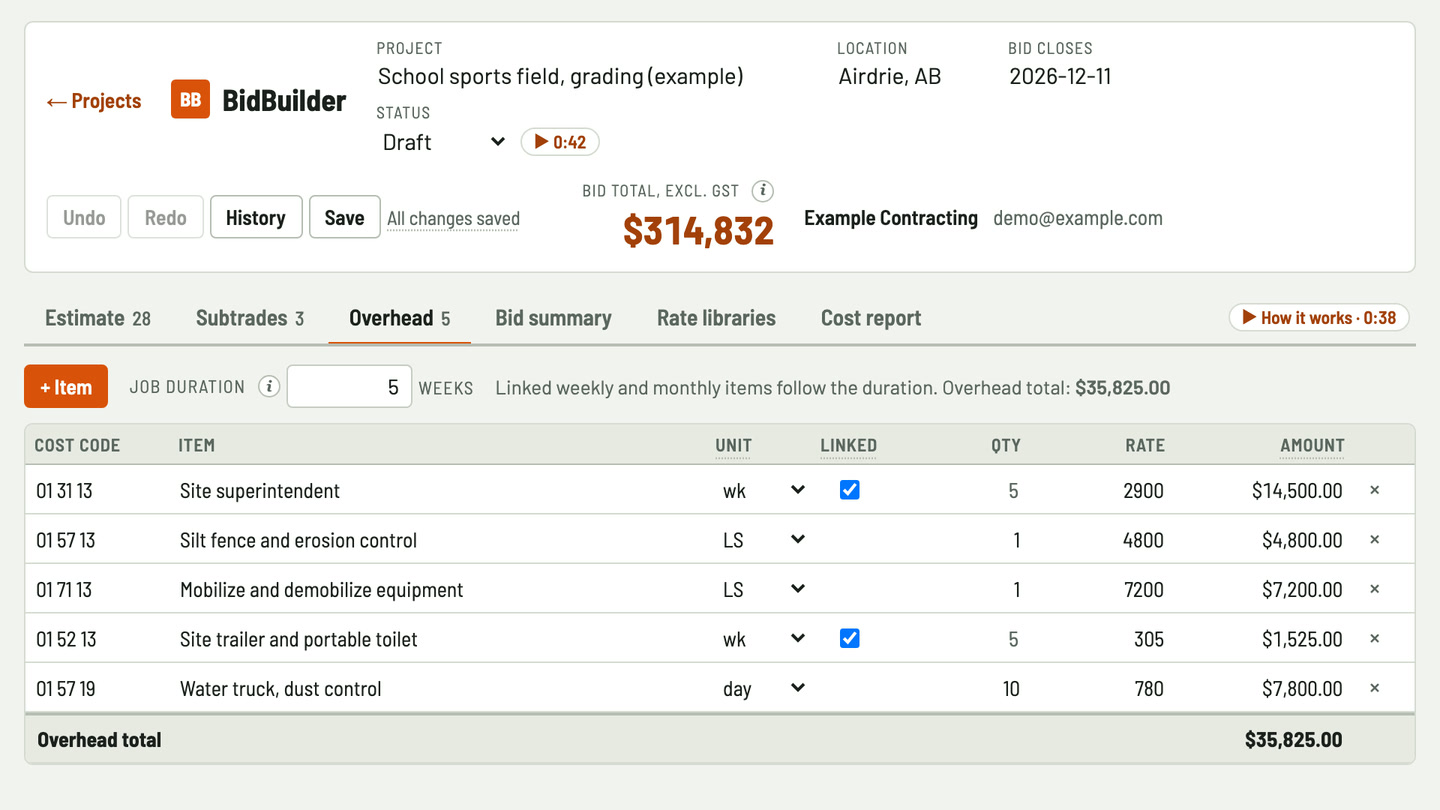

Bid total
  • The price you submit, before GST
$314,832.42
GST, for reference
  • 5%, shown separately and not part of the bid total
$15,741.62

See it in Bidfident

Equipment that runs less than the crew The dozer and grader each get their own hours per unit, so machine time follows the work. 30 sec
The bid, always in view Change a grading rate and the bid total shows how much it moved, right away. 36 sec
One library for every estimate Grading production rates, machines and trades in one library, used by every estimate. 42 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can the dozer and grader run fewer hours than the operator?

Yes. Each line's equipment can have its own hours per unit. Leave it blank and the machine runs for the crew's hours.

Can I keep my production rates per square metre?

Yes. Save them as tasks with hours per unit in the rate library, and pick them from the line picker by typing a description.

Does it work out cut and fill from survey data?

No. Bidfident doesn't read survey files, drawings or maps. Enter the volumes your survey or software gives you.

Can I price in square yards or acres?

Units are free text, so any unit works. Bidfident doesn't convert between units, so price each line in the unit its rate is in.

Can erosion control go in as a lump sum?

Yes. Add it as an overhead item by lump sum, beside weekly items like the superintendent.

What if wet weather adds a week to the grading?

Change the job duration and the superintendent, and every other weekly or monthly item linked to it, updates. Part weeks are allowed.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.
