Licensed asbestos removal is priced in enclosures, metres of pipe lagging and square metres of floor tiles, with air monitoring running every week the enclosure is up. Bidfident lets you price each removal line with operative hours, polythene and consumables with waste, and negative pressure units at their own hours. Hazardous waste carriage goes in as a subcontract, and weekly air monitoring and supervision follow the programme.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • Air monitoring left at the old number of weeks

    The programme slips from 5 weeks to 6, and the air monitoring and supervisor lines still show 5. In Bidfident weekly items linked to the job duration follow it, so the extra week is priced.

  • Plant hours that don't match the work

    Negative pressure units run around the clock while the enclosure is up, far longer than the removal gang works, but a spreadsheet row has room for only one set of hours. In Bidfident each line's plant can have its own hours per unit, apart from the gang's.

  • Hours typed wrong on one line

    One pipe lagging line goes in at 0.06 hours a metre instead of 0.6, and nobody spots it before the tender goes out. Lines to check flags a missing quantity, a line that comes to zero and, for a line picked from your library, hours or a material price more than 25% off the library's, so you look before you send.

How Bidfident fits your work

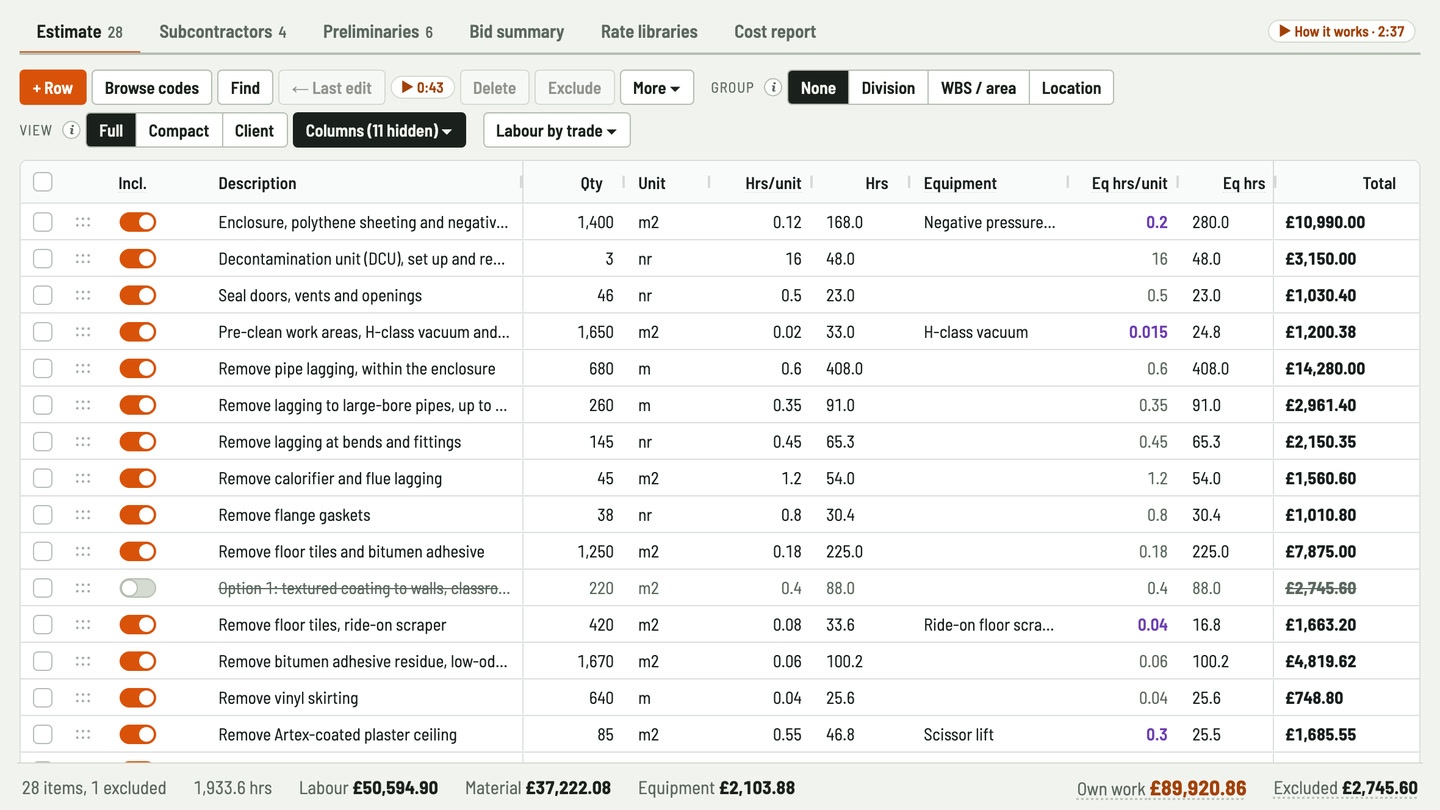

  • Bidfident screenshot: air monitoring by the week

    Air monitoring by the week

    Put the independent analyst's air monitoring and the asbestos supervisor in by the week, linked to the job duration. Add a week to the programme and both follow.

  • Bidfident screenshot: negative pressure units at their own hours

    Negative pressure units at their own hours

    Give the enclosure line's NPU its own hours per square metre. It runs around the clock while the enclosure is up, so it's charged for its own hours, not the gang's.

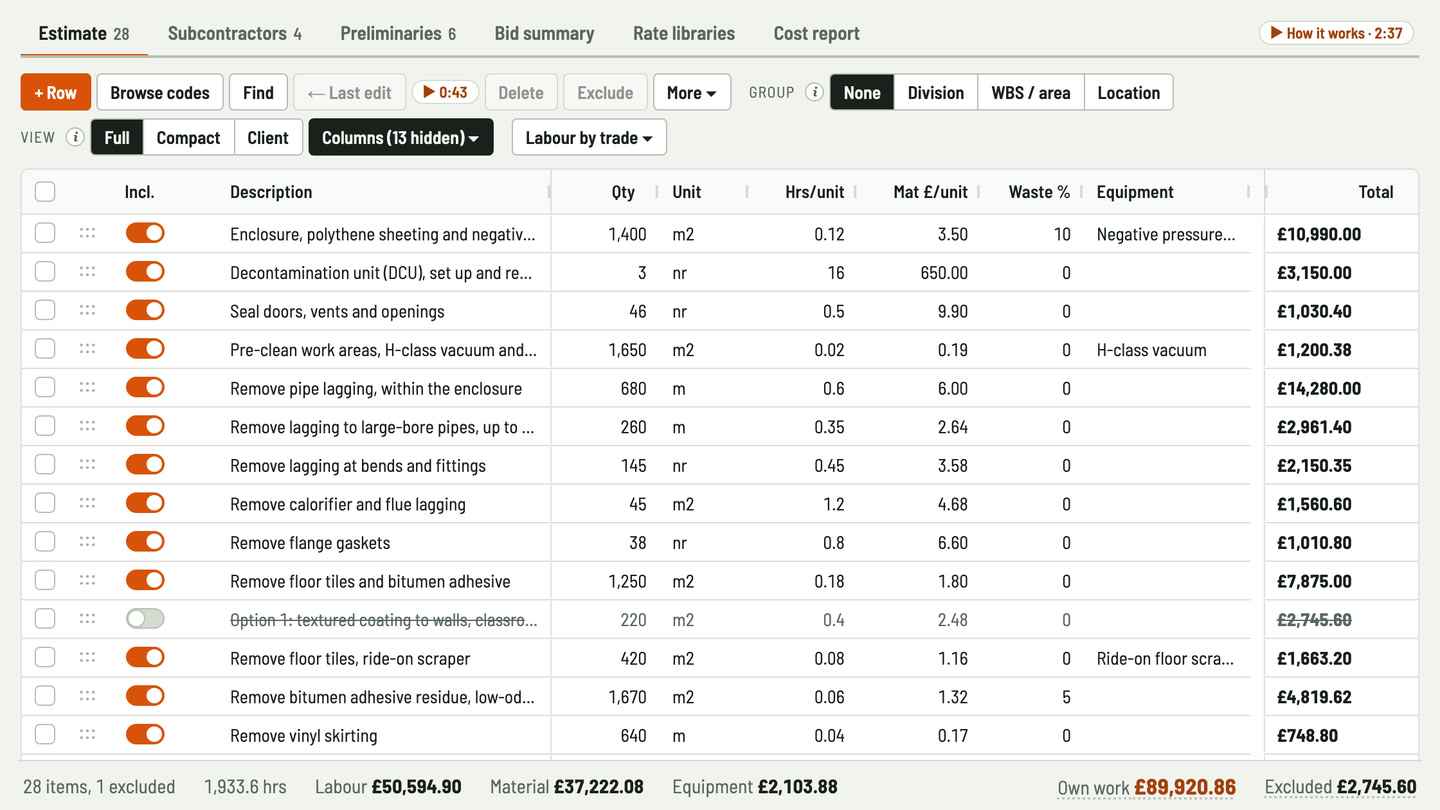

  • Bidfident screenshot: lagging by the metre, tiles by the square metre

    Lagging by the metre, tiles by the square metre

    Units are free text, so pipe lagging goes in by the m, floor tiles and adhesive by the m² and decontamination units by the nr. Each line adds up hours and material as you go.

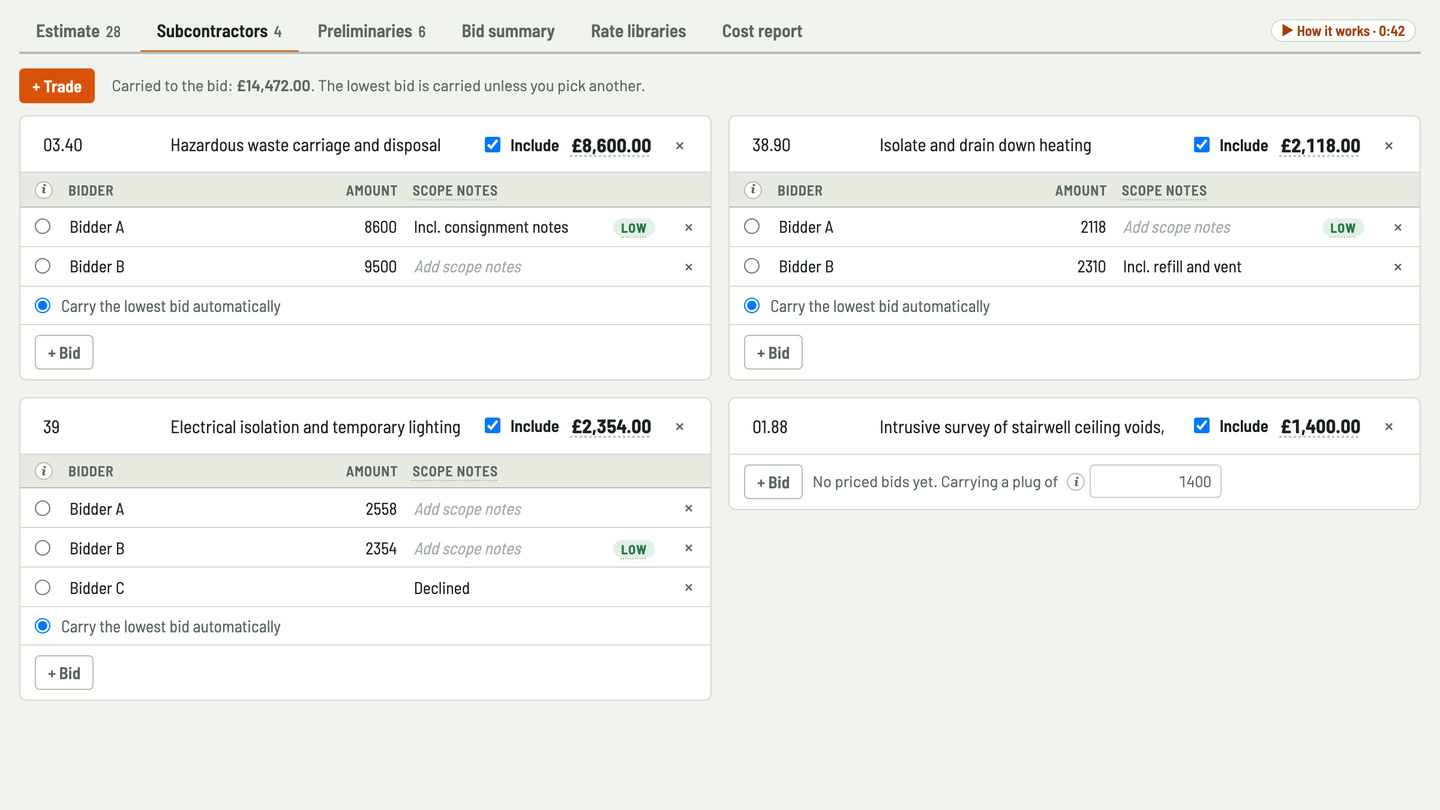

  • Bidfident screenshot: hazardous waste carriage as a subcontract

    Hazardous waste carriage as a subcontract

    Enter each waste carrier's quote for carriage and disposal. The lowest is flagged and carried, or pick another. No quote yet? Carry an allowance.

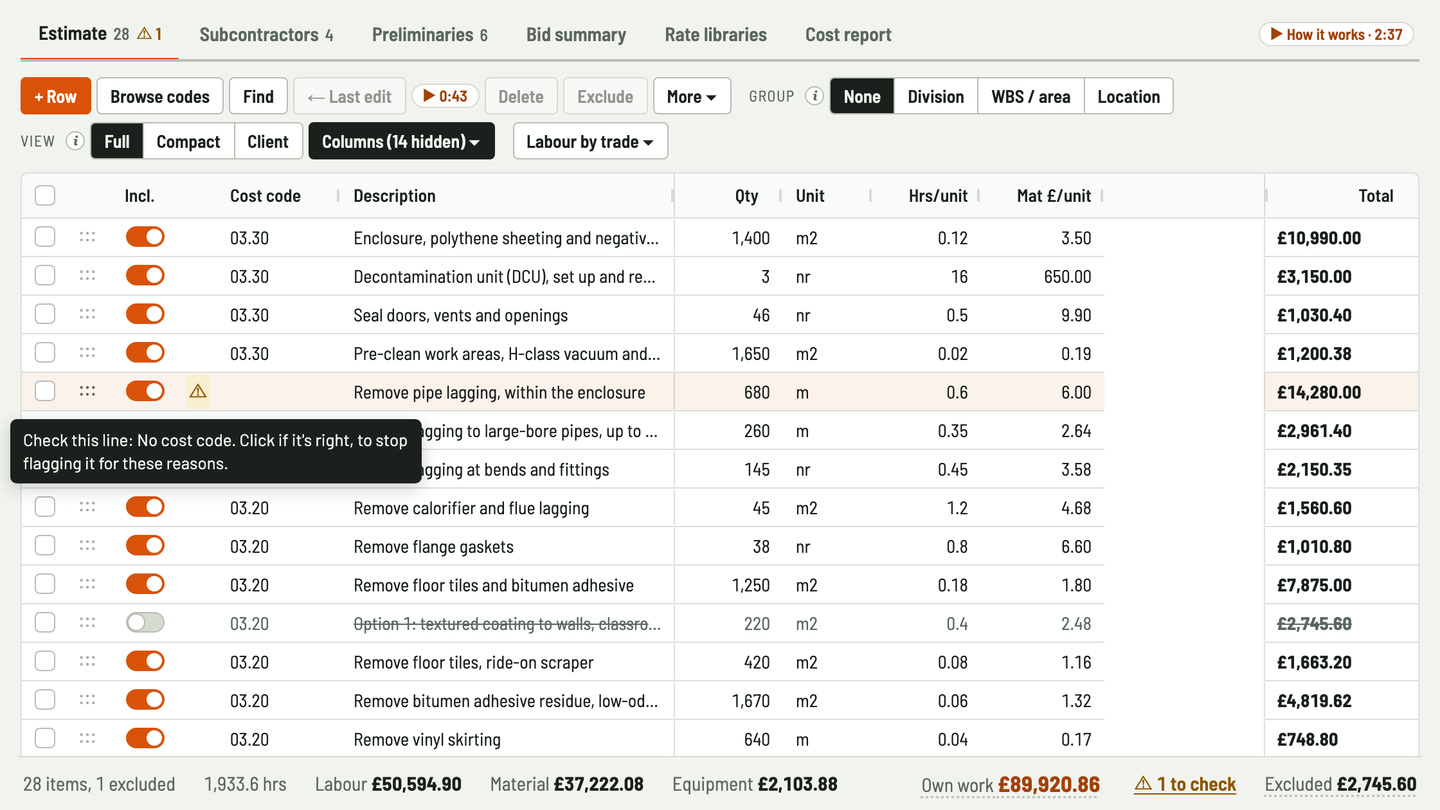

  • Bidfident screenshot: checks before the asbestos tender goes out

    Checks before the asbestos tender goes out

    Lines with no cost code, no quantity, a total of zero, hours with a zero rate, or hours or a material price more than 25% off the library's are flagged, so a mistyped pipe lagging or floor tile rate gets a second look. Mark a line as right and it stays quiet.

  • Bidfident screenshot: contingency for hidden asbestos

    Contingency for hidden asbestos

    Carry a contingency for asbestos found behind walls and above ceilings, then overheads and profit, with the bond and insurance on the subtotal after them. Every amount is exact to the penny.

Worked example: licensed asbestos removal of pipe lagging and floor tiles at a school

A made-up job, priced in Bidfident: 27 lines of your own work, 4 subcontract packages and 6 preliminaries items over a 6-week programme. The 5 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in the UK, then on the Projects screen, under Example project, pick "Demolition and asbestos removal" and "Asbestos removal" and press Add example project.

Your own work
ItemAmount
Enclosure, polythene sheeting and negative pressure, 1,400 m2
  • Labour: 1,400 m2 × 0.12 hrs = 168 hrs at £25.00/hr (asbestos operative) = £4,200.00
  • Materials: 1,400 m2 × £3.50 + 10% waste = £5,390.00
  • Plant: negative pressure unit, 1,400 m2 × 0.2 hrs = 280 hrs, more than the crew, at £5.00/hr = £1,400.00
£10,990.00
Decontamination unit (DCU), set up and removed, 3 nr
  • Labour: 3 nr × 16 hrs = 48 hrs at £25.00/hr (asbestos operative) = £1,200.00
  • Materials: 3 nr × £650.00 = £1,950.00
£3,150.00
Remove pipe lagging, within the enclosure, 680 m
  • Labour: 680 m × 0.6 hrs = 408 hrs at £25.00/hr (asbestos operative) = £10,200.00
  • Materials: 680 m × £6.00 = £4,080.00
£14,280.00
Remove floor tiles and bitumen adhesive, 1,250 m2
  • Labour: 1,250 m2 × 0.18 hrs = 225 hrs at £25.00/hr (asbestos operative) = £5,625.00
  • Materials: 1,250 m2 × £1.80 = £2,250.00
£7,875.00
Fine clean and sealing, 1,850 m2
  • Labour: 1,850 m2 × 0.05 hrs = 92.5 hrs at £25.00/hr (asbestos operative) = £2,312.50
  • Materials: 1,850 m2 × £0.80 = £1,480.00
£3,792.50
22 more lines of your own work
  • Labour £27,057.40 + materials £22,072.08 + plant £703.88
  • 1 more line is priced but left out of the total
£49,833.36
Subcontractors
ItemAmount
Hazardous waste carriage and disposal
  • Quotes: Bidder A £8,600.00, Bidder B £9,500.00
  • Carrying the lowest: Bidder A
£8,600.00
Isolate and drain down heating
  • Quotes: Bidder A £2,118.00, Bidder B £2,310.00
  • Carrying the lowest: Bidder A
£2,118.00
Electrical isolation and temporary lighting
  • Quotes: Bidder A £2,558.00, Bidder B £2,354.00
  • Carrying the lowest: Bidder B
£2,354.00
Intrusive survey of stairwell ceiling voids, allowance
  • No quotes yet: carrying an allowance
£1,400.00
Preliminaries
ItemAmount
Supervision, asbestos supervisor
  • 6 wk × £1,100.00, following the programme
£6,600.00
Air monitoring, independent analyst
  • 6 wk × £1,600.00, following the programme
£9,600.00
Generator for negative pressure units
  • 6 wk × £209.00, following the programme
£1,254.00
Face-fit tests and medicals
  • 8 ea × £90.80
£726.40
ASB5 notification and plan of work
  • 1 LS × £350.00
£350.00
Mobilisation and demobilisation
  • 1 LS × £1,760.00
£1,760.00
Tender summary
ItemAmount
Own work
  • Labour £50,594.90 + materials £37,222.08 + plant £2,103.88
£89,920.86
Excluded lines, not counted£2,745.60
Subcontractors£14,472.00
Preliminaries
  • 6 weeks
£20,290.40
Direct cost
  • Own work + subcontractors + preliminaries

£124,683.26
Contingency
  • 8% of direct cost
£9,974.66
Overheads and profit
  • 12% of direct cost plus contingency
£16,158.95
Subtotal before the bond£150,816.87
Bond
  • 1.5% of the subtotal
£2,262.25
Insurance
  • 1% of the subtotal
£1,508.17
Tender total
  • The price you tender, before VAT
£154,587.29
VAT, for reference
  • 20%, shown separately and not part of the tender total
£30,917.46

See it in Bidfident

Site costs that follow the schedule Air monitoring and supervision by the week follow the programme. Add a week and they update. 38 sec
Bids side by side Hazardous waste carrier quotes side by side, the lowest carried unless you pick another. 42 sec
Lines to check Flags a missing quantity, a zero line or hours that look off before the asbestos tender goes out. 32 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can air monitoring follow the programme?

Yes. Put it in as a weekly preliminaries item linked to the job duration. Change the weeks and it updates, part weeks included.

Can I price pipe lagging by the metre and floor tiles by the square metre?

Yes. Units are free text, so each line can use its own unit. Bidfident doesn't convert between units.

Can I add polythene and consumables with a waste allowance?

Yes. Each line has a material price and a waste percentage, and the material total includes the waste.

Can I price a DCU as a single item?

Yes. Use nr with hours and material per unit, or save it as an assembly in your rate library so it fills a whole line at once.

Can I carry waste carriage before the carriers have quoted?

Yes. Carry an allowance for the hazardous waste subcontract, then enter each carrier's quote as it comes in. The lowest is flagged and carried unless you pick another.

Can negative pressure units run longer than the gang works?

Yes. Give the enclosure line's plant its own hours per unit, more than the gang's when the NPUs run around the clock. Leave it blank and they run for the gang's hours.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.

Price your next asbestos tender in Bidfident

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.
