Bidfident

Bidfident for land remediation contractors

Estimating software for land remediation

Remediation tenders turn on cubic metres of soil. In Bidfident you price contaminated soil excavation and clean imported fill by the m³, give the 360 excavator and the roller their own hours, and add tank removals by the nr and dewatering as an item. Muck away and validation testing go in as subcontracts, and the site manager and environmental monitoring follow the programme by the week.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • Muck away is the biggest number, and the hardest to compare

    Carting away and tipping contaminated soil can be most of the job, and the quotes arrive in different shapes. In Bidfident each quote sits side by side, the lowest is flagged and carried, and you can carry an allowance until the quotes are in.

  • Imported fill without the extra

    Clean imported fill always takes more than the hole, and spreadsheets bury the allowance in a formula nobody checks. In Bidfident each line's material has a waste percentage in plain view, so the extra 10% is there for anyone to see.

  • Monitoring that outlasts the estimate

    The dig runs a week longer than the programme, but the environmental monitoring line still shows the old number of weeks. In Bidfident weekly items linked to the job duration follow it, part weeks included.

How Bidfident fits your work

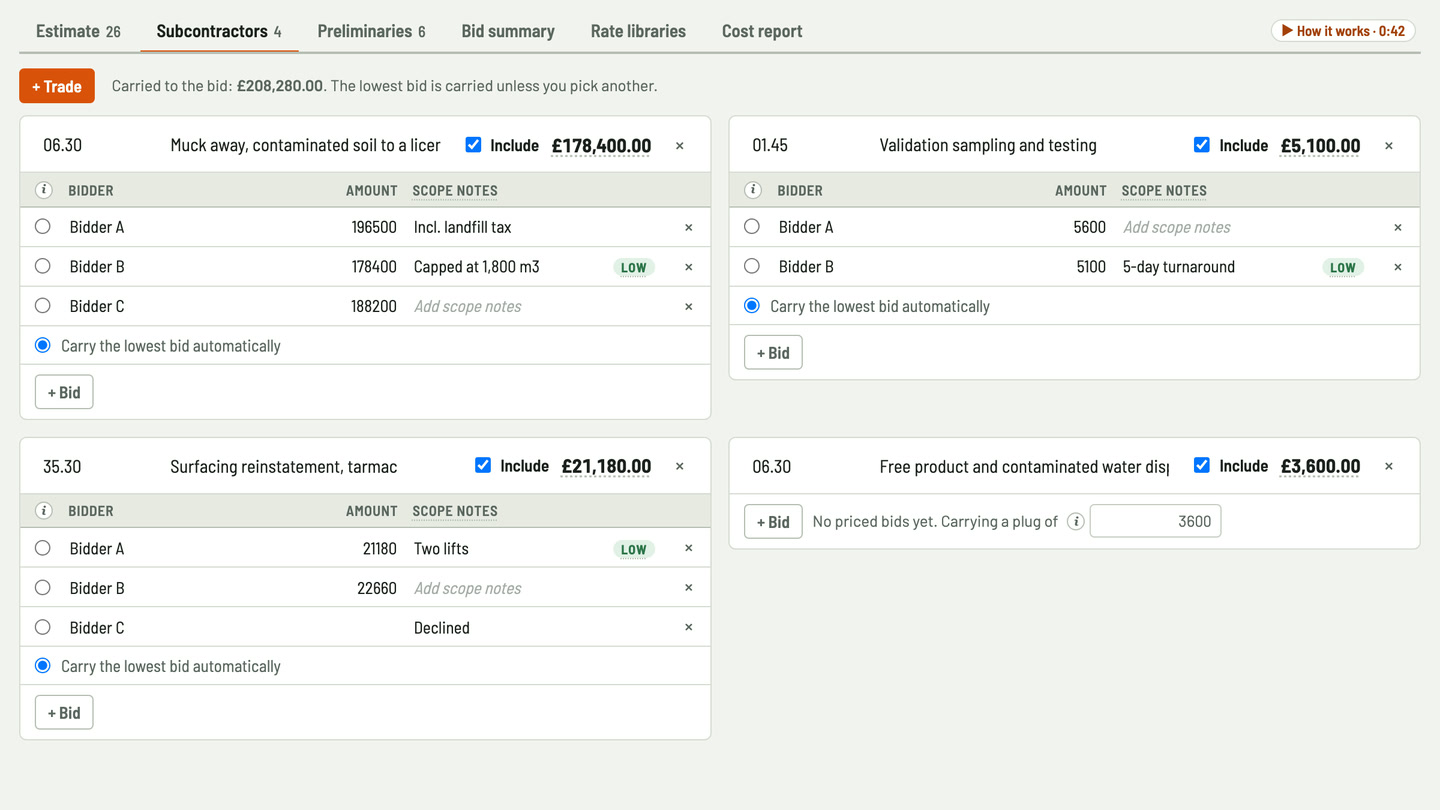

  • Bidfident screenshot: muck away and testing side by side

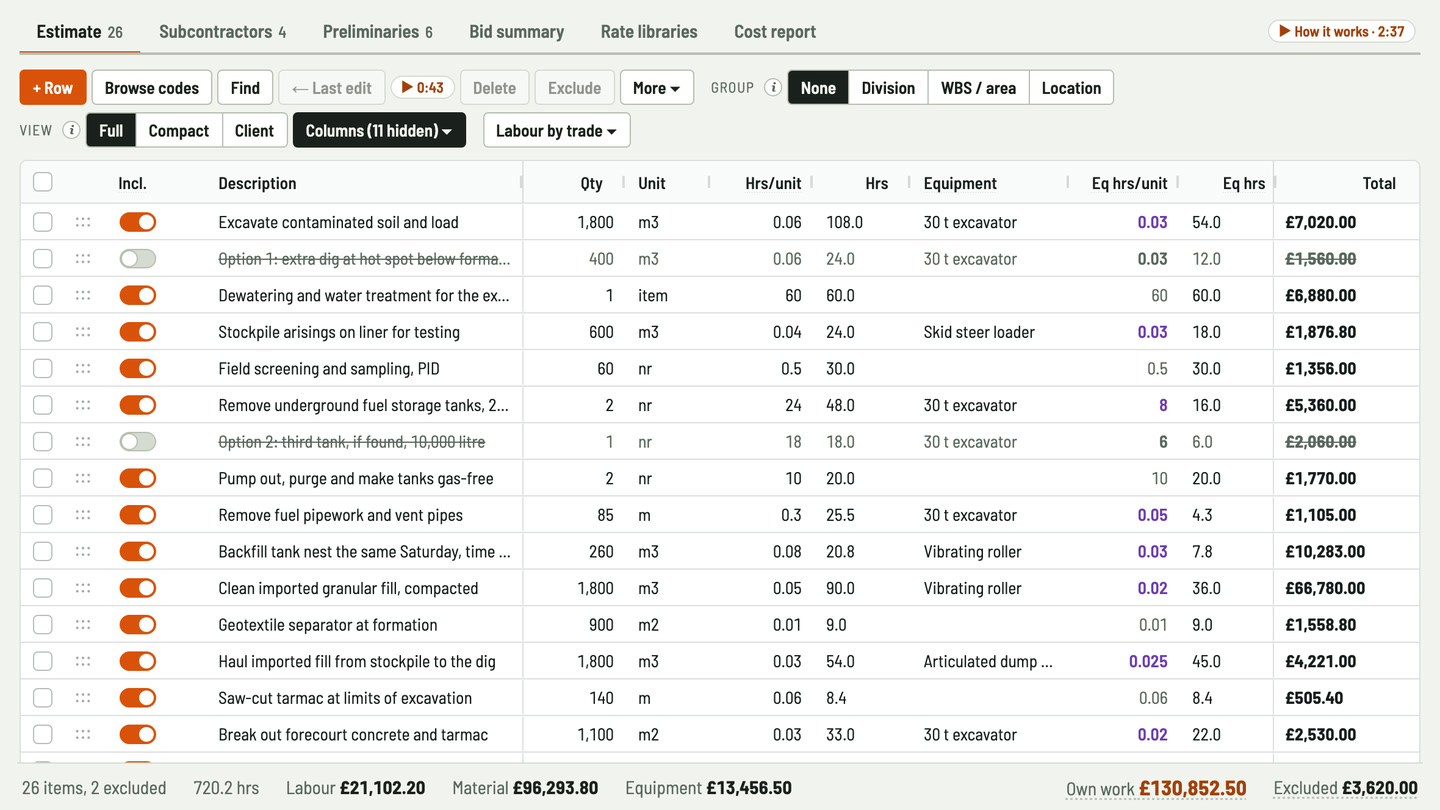

    Muck away and testing side by side

    Enter each quote for contaminated soil muck away and disposal, and for validation testing. The lowest is flagged and carried unless you pick another.

  • Bidfident screenshot: excavator and roller at their own hours

    Excavator and roller at their own hours

    Give the excavator its own hours per m³ dug, and the vibrating roller its own hours per m³ placed. Each is charged for the hours it runs.

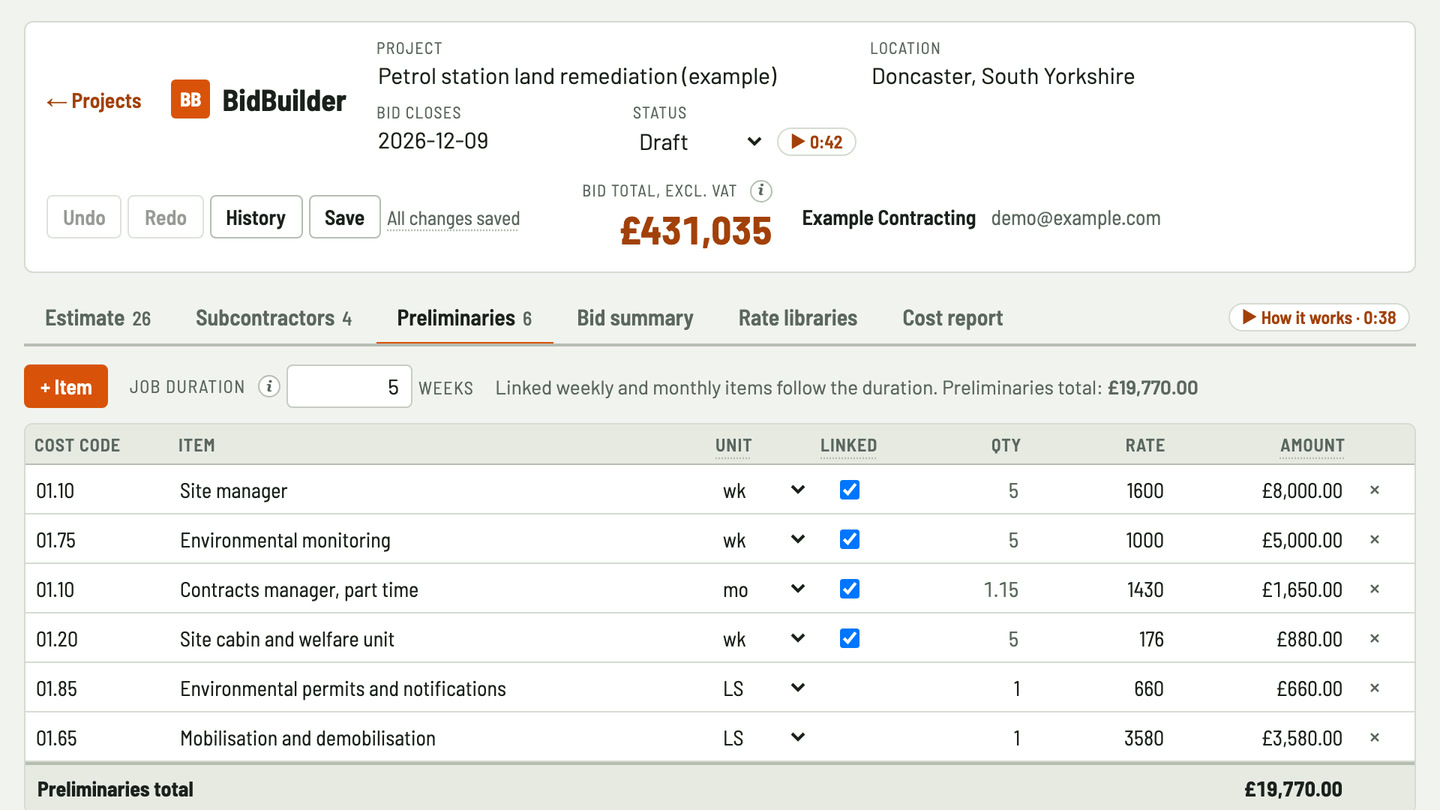

  • Bidfident screenshot: site manager and monitoring by the week

    Site manager and monitoring by the week

    Link the site manager and environmental monitoring to the job duration. Stretch the programme from 5 weeks to 5.5 and both follow.

  • Bidfident screenshot: extra excavation kept as an option

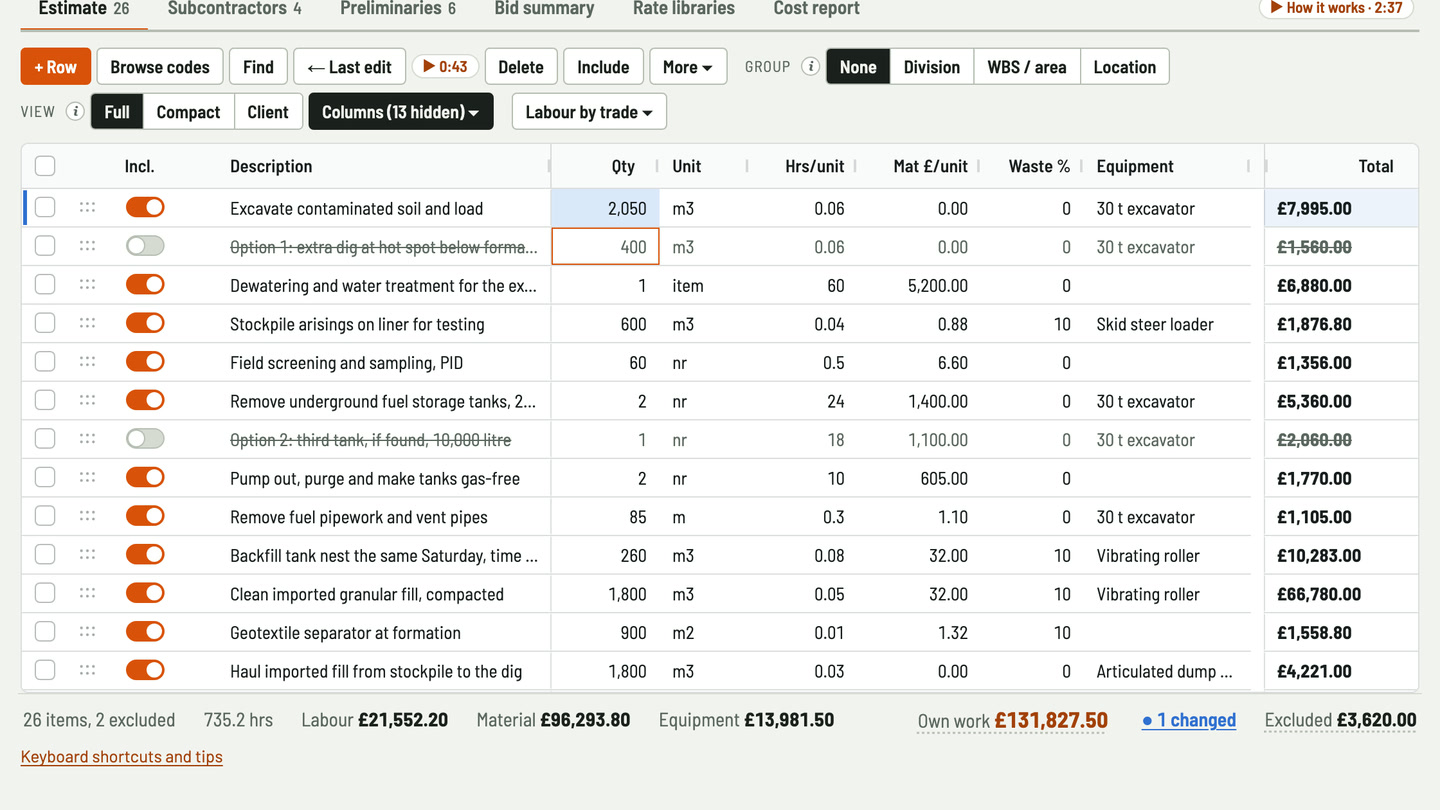

    Extra excavation kept as an option

    Price a possible extra dig or a third tank as an alternate. It stays on the sheet struck through, with its cost before markups shown beside the totals, and isn't counted in the tender.

  • Bidfident screenshot: the tender total in view as volumes change

    The tender total in view as volumes change

    Change the cubic metres of soil and the total at the top shows how much it moved, straight away.

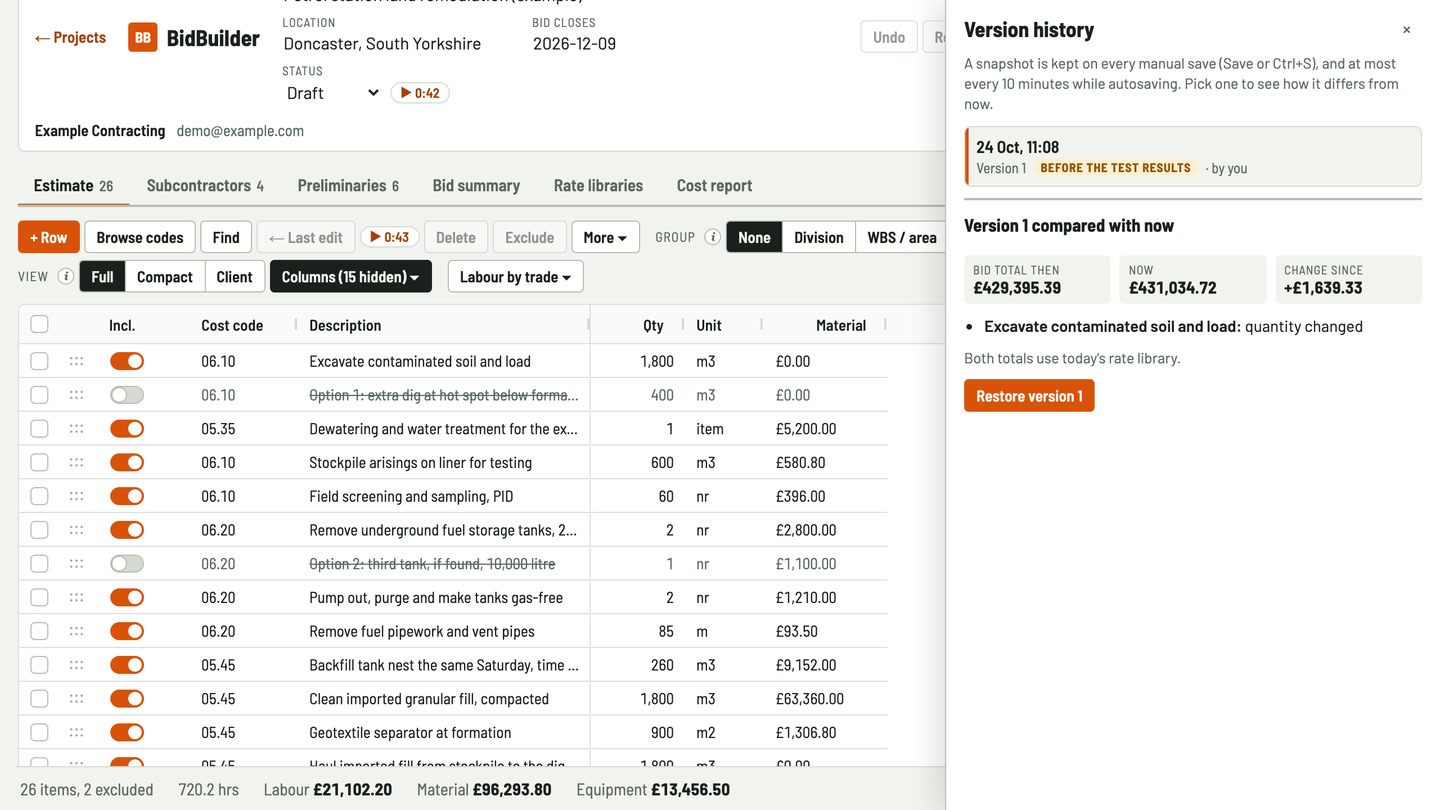

  • Bidfident screenshot: earlier versions of the estimate kept

    Earlier versions of the estimate kept

    Volumes change as testing comes back. Compare any saved version with now, and restore an earlier one with a click.

Worked example: remediation of a former petrol station site

A made-up job, priced in Bidfident: 24 lines of your own work, 4 subcontract packages and 6 preliminaries items over a 5-week programme. The 4 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in the UK, then on the Projects screen, under Example project, pick "Demolition and asbestos removal" and "Land remediation" and press Add example project.

Your own work
ItemAmount
Excavate contaminated soil and load, 1,800 m3
  • Labour: 1,800 m3 × 0.06 hrs = 108 hrs at £30.00/hr (plant operator) = £3,240.00
  • Plant: 30 t excavator, 1,800 m3 × 0.03 hrs = 54 hrs, less than the crew, at £70.00/hr = £3,780.00
£7,020.00
Dewatering and water treatment for the excavation, 1 item
  • Labour: 1 item × 60 hrs = 60 hrs at £28.00/hr (groundworker) = £1,680.00
  • Materials: 1 item × £5,200.00 = £5,200.00
£6,880.00
Remove underground fuel storage tanks, 25,000 litre, 2 nr
  • Labour: 2 nr × 24 hrs = 48 hrs at £30.00/hr (plant operator) = £1,440.00
  • Materials: 2 nr × £1,400.00 = £2,800.00
  • Plant: 30 t excavator, 2 nr × 8 hrs = 16 hrs, less than the crew, at £70.00/hr = £1,120.00
£5,360.00
Clean imported granular fill, compacted, 1,800 m3
  • Labour: 1,800 m3 × 0.05 hrs = 90 hrs at £28.00/hr (groundworker) = £2,520.00
  • Materials: 1,800 m3 × £32.00 + 10% waste = £63,360.00
  • Plant: vibrating roller, 1,800 m3 × 0.02 hrs = 36 hrs, less than the crew, at £25.00/hr = £900.00
£66,780.00

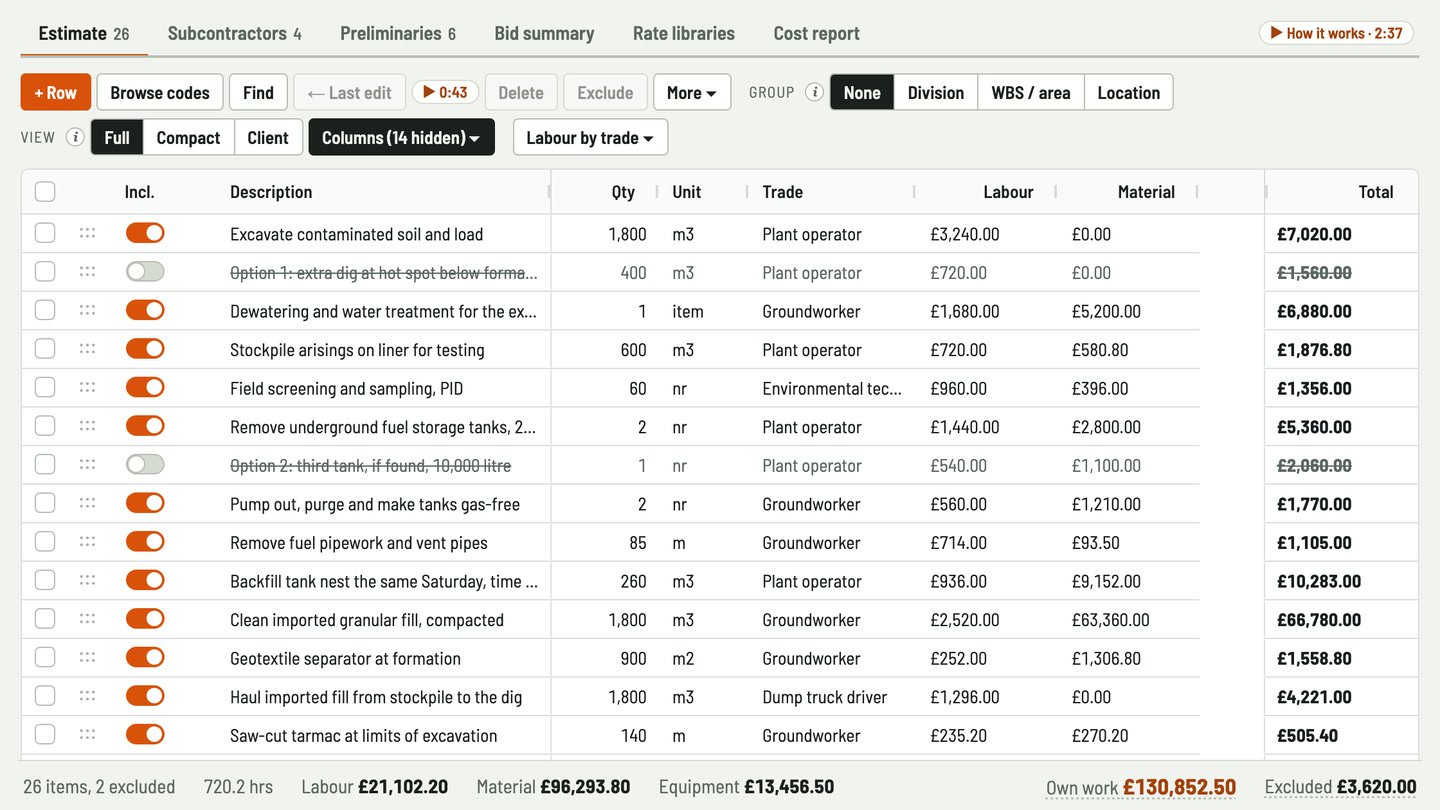

20 more lines of your own work
  • Labour £12,222.20 + materials £24,933.80 + plant £7,656.50
  • 2 more lines are priced but left out of the total
£44,812.50
Subcontractors
ItemAmount
Muck away, contaminated soil to a licensed soil treatment centre
  • Quotes: Bidder A £196,500.00, Bidder B £178,400.00, Bidder C £188,200.00
  • Carrying the lowest: Bidder B
£178,400.00
Validation sampling and testing
  • Quotes: Bidder A £5,600.00, Bidder B £5,100.00
  • Carrying the lowest: Bidder B
£5,100.00
Surfacing reinstatement, tarmac
  • Quotes: Bidder A £21,180.00, Bidder B £22,660.00
  • Carrying the lowest: Bidder A
£21,180.00
Free product and contaminated water disposal, allowance
  • No quotes yet: carrying an allowance
£3,600.00
Preliminaries
ItemAmount
Site manager
  • 5 wk × £1,600.00, following the programme
£8,000.00
Environmental monitoring
  • 5 wk × £1,000.00, following the programme
£5,000.00
Contracts manager, part time
  • 5 weeks × £1,430.00 a month × 12 ÷ 52, following the programme
£1,650.00
Site cabin and welfare unit
  • 5 wk × £176.00, following the programme
£880.00
Environmental permits and notifications
  • 1 LS × £660.00
£660.00
Mobilisation and demobilisation
  • 1 LS × £3,580.00
£3,580.00
Tender summary
ItemAmount
Own work
  • Labour £21,102.20 + materials £96,293.80 + plant £13,456.50
£130,852.50
Excluded lines, not counted£3,620.00
Subcontractors£208,280.00
Preliminaries
  • 5 weeks
£19,770.00
Direct cost
  • Own work + subcontractors + preliminaries
£358,902.50
Contingency
  • 6% of direct cost
£21,534.15
Overheads and profit
  • 10% of direct cost plus contingency
£38,043.67
Subtotal before the bond£418,480.32
Bond
  • 1.5% of the subtotal
£6,277.20
Insurance
  • 1.5% of the subtotal
£6,277.20
Tender total
  • The price you tender, before VAT
£431,034.72
VAT, for reference
  • 20%, shown separately and not part of the tender total
£86,206.94

See it in Bidfident

Bids side by side Muck away quotes side by side. The lowest is carried unless you pick another, and an allowance fills the gap. 42 sec
The bid, always in view Change the cubic metres of soil and see at once how much the tender moved. 36 sec
Version history Compare the estimate with an earlier version as volumes change, and restore it with a click. 35 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can I price soil by the tonne as well as the cubic metre?

You can use either unit on a line, since units are free text. Bidfident doesn't convert between them, so price each line in the unit its rate is in.

Can I carry muck away before the quotes are in?

Yes. Carry an allowance for the subcontract, then enter the quotes as they come in and carry the lowest or the one you pick.

Can each machine have its own hours?

Yes. Each line's plant can have its own hours per unit. Leave it blank and it runs for the gang's hours.

Can I add a waste allowance to imported fill?

Yes. Each line's material has a waste percentage, and the total includes it.

Can dewatering go in as a single item?

Yes. Use item as the unit with a quantity of 1, and put the hours and materials for dewatering and water treatment on that line.

Does it read quantities from site plans or maps?

No. You enter the volumes yourself, from your own measurements or the site investigation report.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.

Price your next remediation tender in Bidfident

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.
