Estimating software for grading and earthwork

Bidfident is built for estimators who price grading by the square yard and the cubic yard. Strip topsoil, cut and fill, fine grade, proof roll and respread on separate lines, give the dozer, motor grader and roller their own hours apart from the operator's, carry survey and grade staking as a sub bid, and keep silt fence and SWPPP erosion control in general conditions.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • Dozer and blade time lumped in with the crew

    Rough grading and fine grading use different machines for very different hours, but a spreadsheet row often has one blended rate. In Bidfident each line names its own equipment with its own hours per unit, apart from the operator's.

  • Big areas, tiny rates

    On a 17,000 square yard field, a slip in hours per square yard moves the number by thousands. Bidfident keeps the bid total in view and briefly shows how much it moved after each change, so a slip shows right away.

  • The same area on five lines

    Strip, fine grade, proof roll and respread all use the field's area, and when it changes some rows get missed. In Bidfident the sheet fills down like Excel, and every change is one undo step if you go too far.

How Bidfident fits your work

  • Bidfident screenshot: dozer, grader and roller for their own hours

    Dozer, grader and roller for their own hours

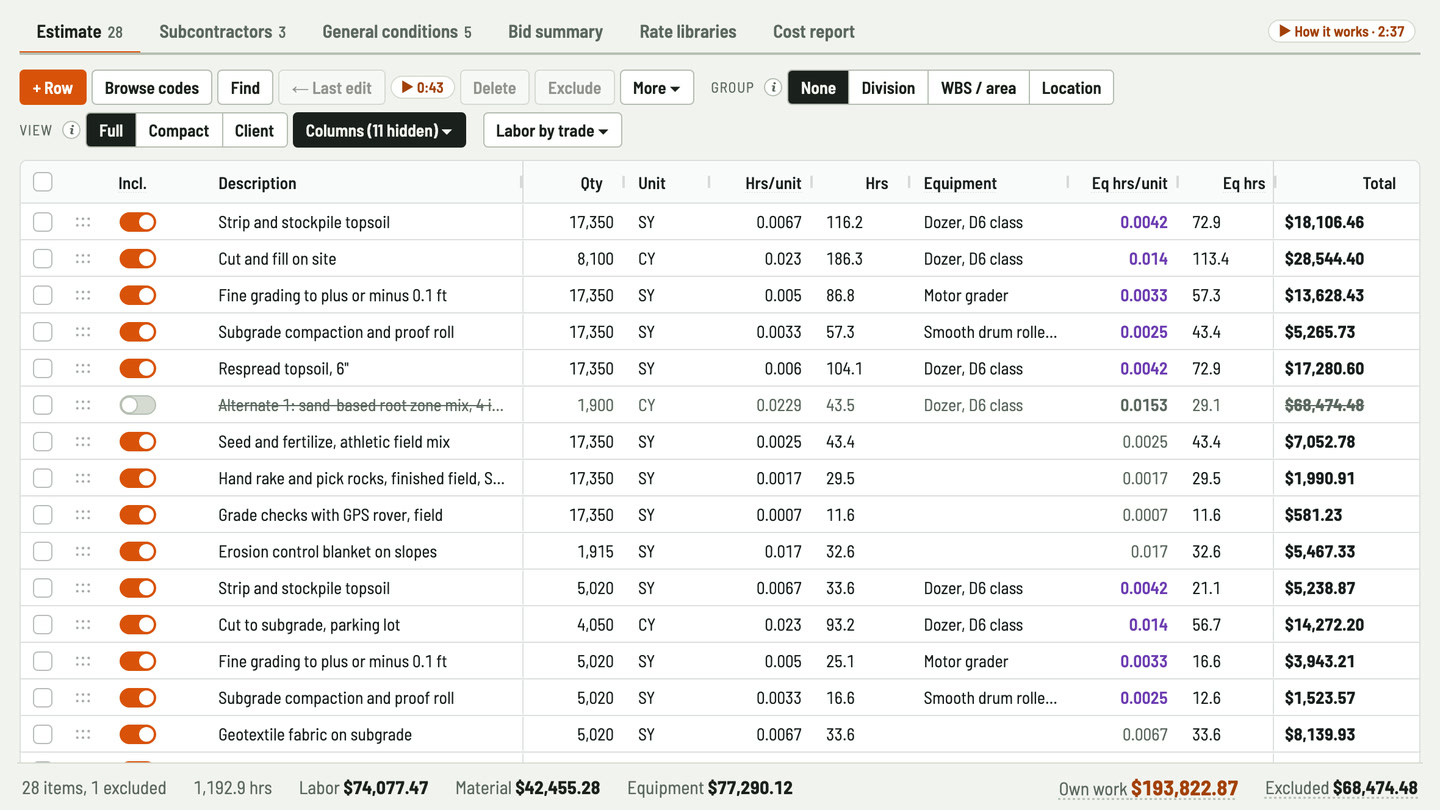

    A cut and fill line can carry the dozer at its own hours per cubic yard, and fine grading the motor grader at its own hours per square yard. Each machine is charged for the time it runs.

  • Bidfident screenshot: every pass on its own line

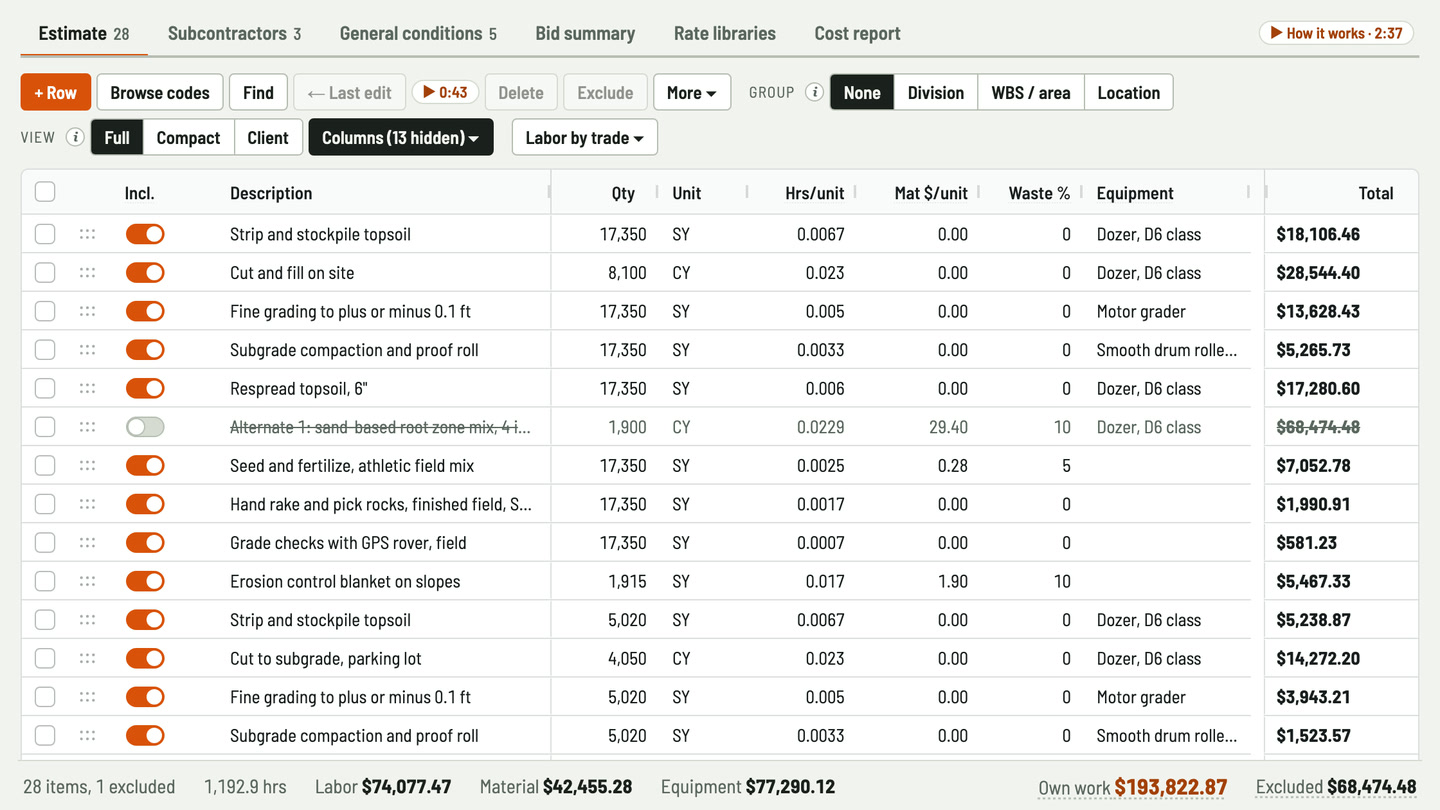

    Every pass on its own line

    Strip, cut and fill, fine grade, proof roll and respread each get a line with a quantity, a unit, crew hours per unit and equipment. Totals update as you type.

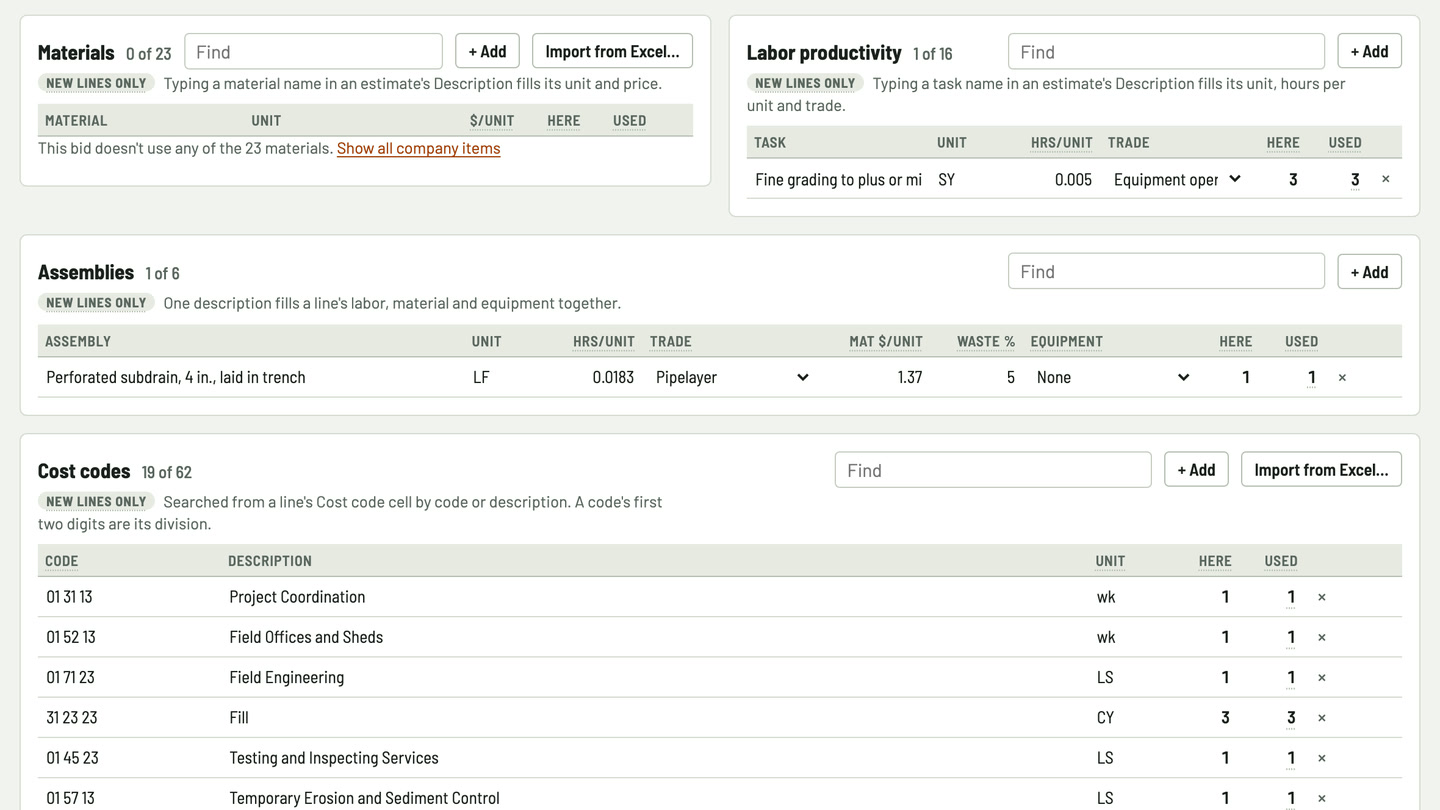

  • Bidfident screenshot: production rates kept in the library

    Production rates kept in the library

    Save tasks with their hours per unit, like fine grading per square yard, in the company library. Every estimate picks up the same production rates.

  • Bidfident screenshot: survey and grade staking as a sub bid

    Survey and grade staking as a sub bid

    Enter each surveyor's number side by side, see the lowest flagged, and carry it or another you pick.

  • Bidfident screenshot: group by field, parking or access road

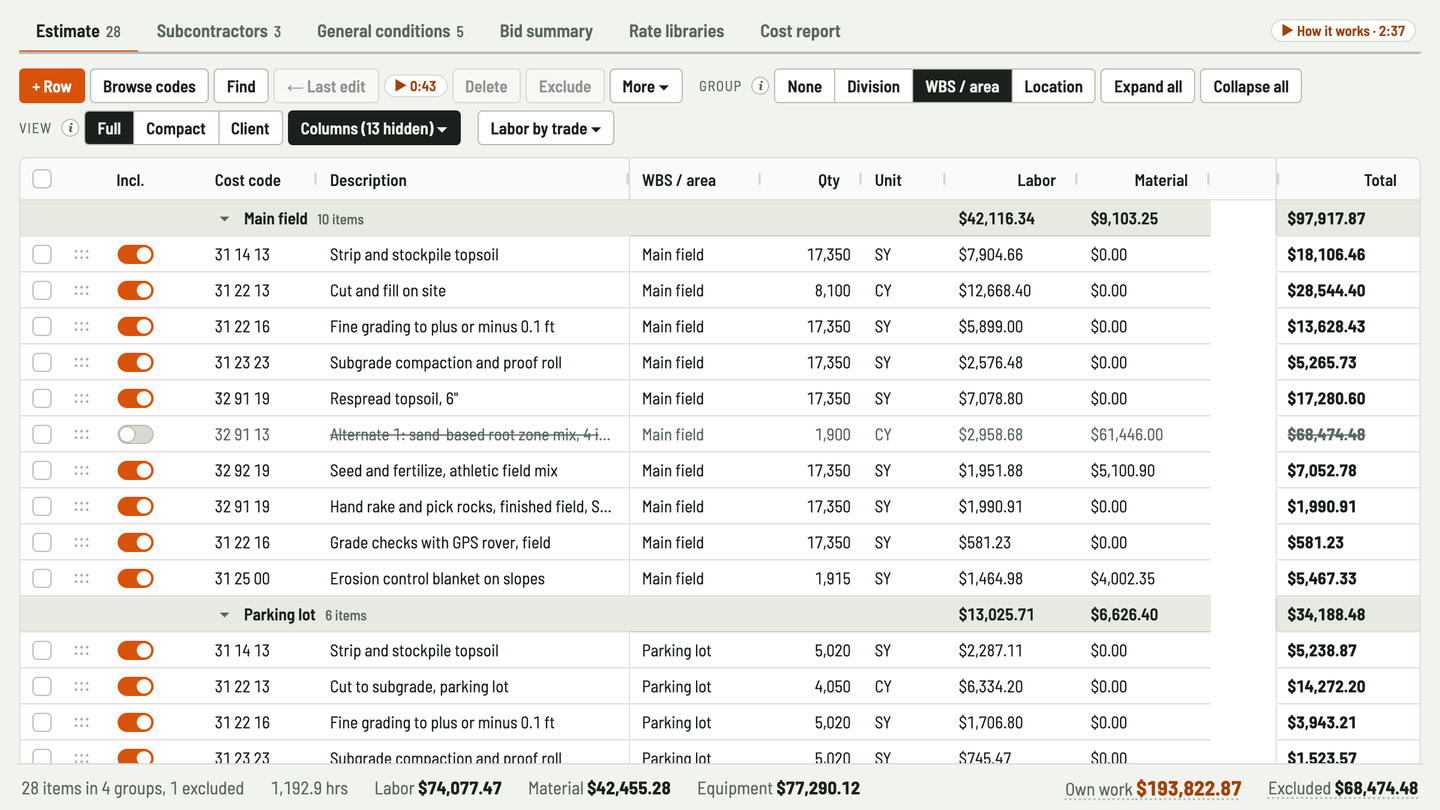

    Group by field, parking or access road

    Tag lines with an area, like the main field, the parking area or the access road, and group the sheet with a subtotal for each.

  • Bidfident screenshot: sWPPP and the super in general conditions

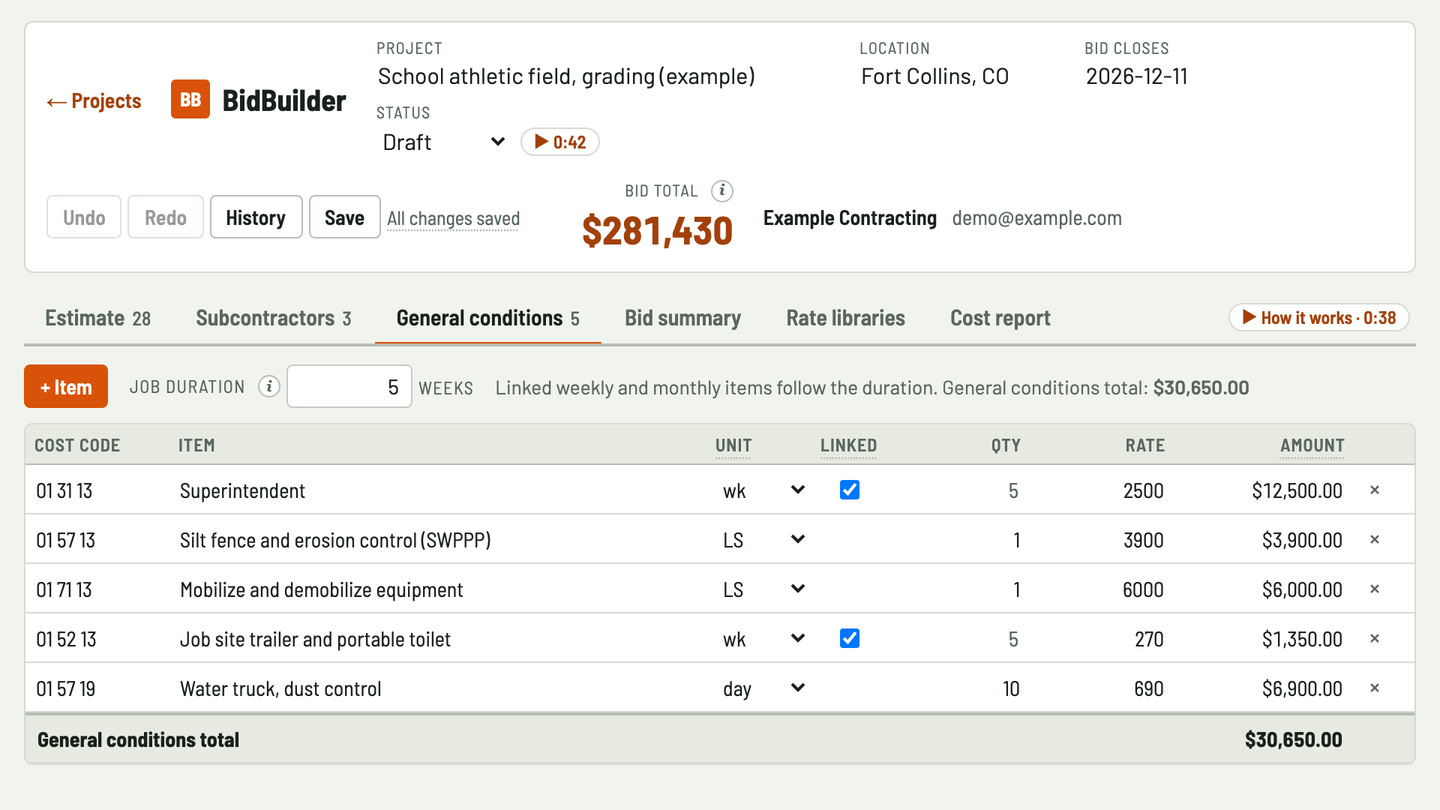

    SWPPP and the super in general conditions

    Silt fence and erosion control as a lump sum, the super by the week. Linked weekly items follow the job duration, even part weeks like 4.5.

Worked example: rough and fine grading for a school athletic field

A made-up job, priced in Bidfident: 27 lines of your own work, 3 subs and 5 general conditions items over a 5-week job. The 5 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in the US, then on the Projects screen, under Example project, pick "Sitework and civil" and "Grading" and press Add example project.

Your own work
ItemAmount
Strip and stockpile topsoil, 17,350 SY
  • Labor: 17,350 SY × 0.0067 hrs = 116.25 hrs at $68.00/hr (equipment operator) = $7,904.66
  • Equipment: dozer, d6 class, 17,350 SY × 0.0042 hrs = 72.87 hrs, less than the crew, at $140.00/hr = $10,201.80
$18,106.46
Cut and fill on site, 8,100 CY
  • Labor: 8,100 CY × 0.023 hrs = 186.3 hrs at $68.00/hr (equipment operator) = $12,668.40
  • Equipment: dozer, d6 class, 8,100 CY × 0.014 hrs = 113.4 hrs, less than the crew, at $140.00/hr = $15,876.00
$28,544.40
Fine grading to plus or minus 0.1 ft, 17,350 SY
  • Labor: 17,350 SY × 0.005 hrs = 86.75 hrs at $68.00/hr (equipment operator) = $5,899.00
  • Equipment: motor grader, 17,350 SY × 0.0033 hrs = 57.26 hrs, less than the crew, at $135.00/hr = $7,729.43
$13,628.43
Subgrade compaction and proof roll, 17,350 SY
  • Labor: 17,350 SY × 0.0033 hrs = 57.26 hrs at $45.00/hr (laborer) = $2,576.48
  • Equipment: smooth drum roller, 10 ton, 17,350 SY × 0.0025 hrs = 43.38 hrs, less than the crew, at $62.00/hr = $2,689.25
$5,265.73
Respread topsoil, 6", 17,350 SY
  • Labor: 17,350 SY × 0.006 hrs = 104.1 hrs at $68.00/hr (equipment operator) = $7,078.80
  • Equipment: dozer, d6 class, 17,350 SY × 0.0042 hrs = 72.87 hrs, less than the crew, at $140.00/hr = $10,201.80
$17,280.60
22 more lines of your own work
  • Labor $37,950.13 + material $42,455.28 + equipment $30,591.84
  • 1 more line is priced but left out of the total
$110,997.25
Subcontractors
ItemAmount

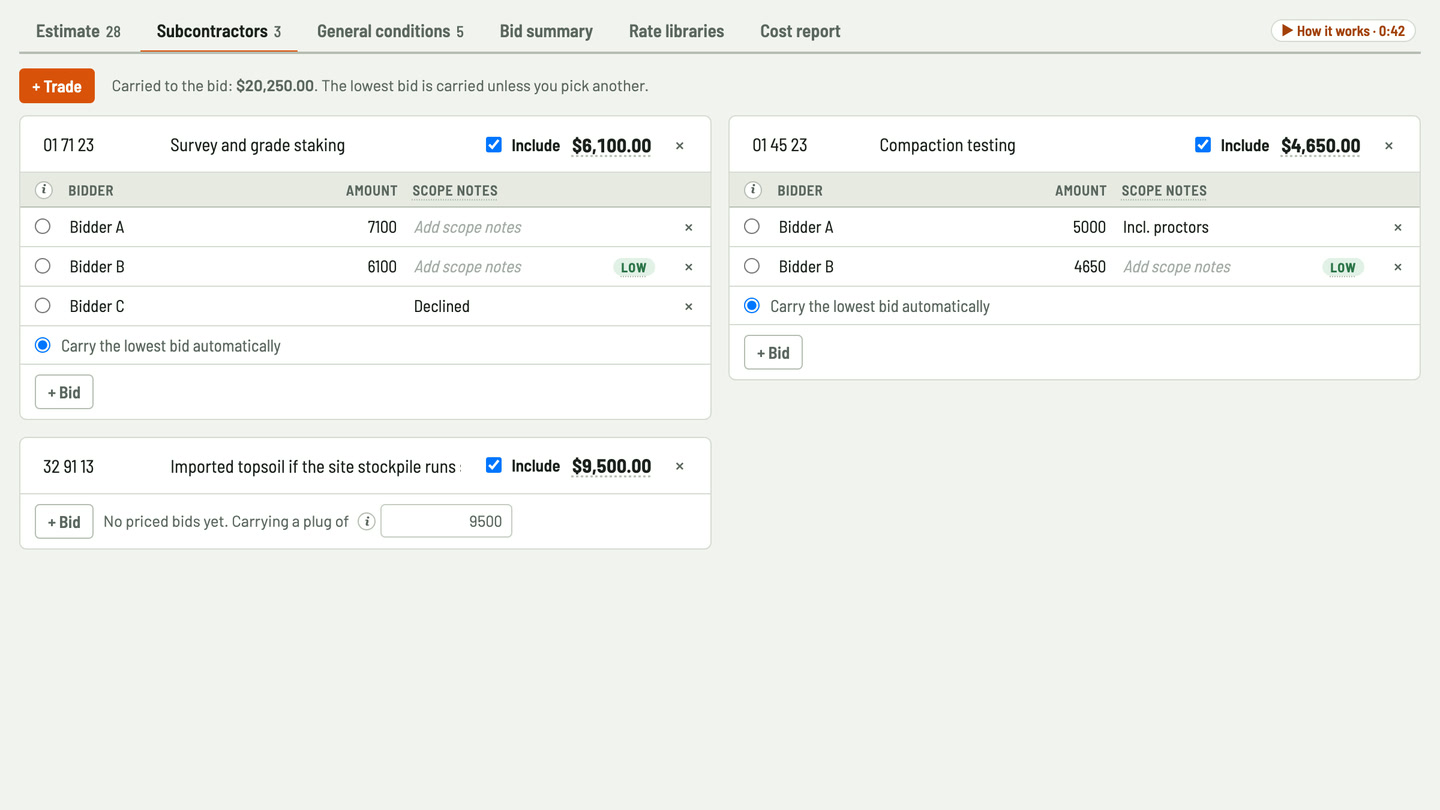

Survey and grade staking
  • Bids: Bidder A $7,100.00, Bidder B $6,100.00
  • Carrying the lowest: Bidder B
$6,100.00
Compaction testing
  • Bids: Bidder A $5,000.00, Bidder B $4,650.00
  • Carrying the lowest: Bidder B
$4,650.00
Imported topsoil if the site stockpile runs short, allowance
  • No bids yet: carrying a plug number
$9,500.00
General conditions
ItemAmount
Superintendent
  • 5 wk × $2,500.00, following the job duration
$12,500.00
Silt fence and erosion control (SWPPP)
  • 1 LS × $3,900.00
$3,900.00
Mobilize and demobilize equipment
  • 1 LS × $6,000.00
$6,000.00
Job site trailer and portable toilet
  • 5 wk × $270.00, following the job duration
$1,350.00
Water truck, dust control
  • 10 day × $690.00
$6,900.00
Bid summary
ItemAmount
Own work
  • Labor $74,077.47 + material $42,455.28 + equipment $77,290.12
$193,822.87
Excluded lines, not counted$68,474.48
Subcontractors$20,250.00
General conditions
  • 5 weeks
$30,650.00
Direct cost
  • Own work + subcontractors + general conditions
$244,722.87
Contingency
  • 3% of direct cost
$7,341.69
Fee
  • 10% of direct cost plus contingency
$25,206.46
Subtotal before the bond$277,271.02
Bond
  • 1% of the subtotal
$2,772.71
Insurance
  • 0.5% of the subtotal
$1,386.36
Bid total
  • The price you submit
$281,430.09

See it in Bidfident

Equipment that runs less than the crew The dozer and grader each get their own hours per unit, so machine time follows the work. 30 sec
The bid, always in view Change a grading production rate and the bid total shows how much it moved, right away. 36 sec
One library for every estimate Grading production rates, equipment and trades in one library, used by every estimate. 42 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can the dozer and grader run fewer hours than the operator?

Yes. Each line's equipment can have its own hours per unit. Leave it blank and the machine runs for the crew's hours.

Can I keep my production rates per square yard?

Yes. Save them as tasks with hours per unit in the rate library, and pick them from the line picker by typing a description.

Does it figure cut and fill from survey data?

No. Bidfident doesn't read survey files, drawings or maps. Enter the volumes your survey or earthwork software gives you.

Can I price in acres?

Units are free text, so any unit works. Bidfident doesn't convert between units, so price each line in the unit its rate is in.

Can erosion control go in as a lump sum?

Yes. Add it as a general conditions item by lump sum on the General conditions tab, beside weekly items like the super.

What if wet weather adds a week to the grading?

Change the job duration and the super, and every other weekly or monthly general conditions item linked to it, updates. Part weeks are allowed.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.
