Bidfident for dry lining subcontractors

Estimating software for dry liners

Dry lining and ceiling contractors price in square metres and metres, and Bidfident lets you do the same. Metal stud partitions, plasterboard on both sides, taping and jointing by a taper at their own rate, suspended ceilings with a scissor lift that runs less than the gang, and bulkheads by the metre. Skips go in by the number exchanged, and supervision follows the programme.

Get started

Enter your email and Bidfident sends you a sign-in link. New companies start with a starter rate library. Who runs Bidfident, and what it keeps about you.

Sound familiar?

  • Jointing priced at the dry liner's rate

    When everything sits on one labour rate, the taping and jointing is priced like the boarding and the tender is off. In Bidfident each line takes its trade's rate, so the taper and the dry liner are each priced at their own.

  • Board waste added in your head

    Ten percent on plasterboard, five on studs, all worked out at the end. In Bidfident each line carries its own waste percentage, so the materials are right line by line.

  • Floors that don't add back to the total

    Three floors on three tabs, and a change on one never reaches the summary. Bidfident groups one estimate by floor or area with subtotals, and it all adds up exactly.

How Bidfident fits your work

  • Bidfident screenshot: dry liners and tapers at their own rates

    Dry liners and tapers at their own rates

    Give the partition and boarding lines the dry liner's trade and the jointing line the taper's, and each takes its rate from the library. Add a new trade in the Trade cell without leaving the sheet.

  • Bidfident screenshot: square metres and metres, line by line

    Square metres and metres, line by line

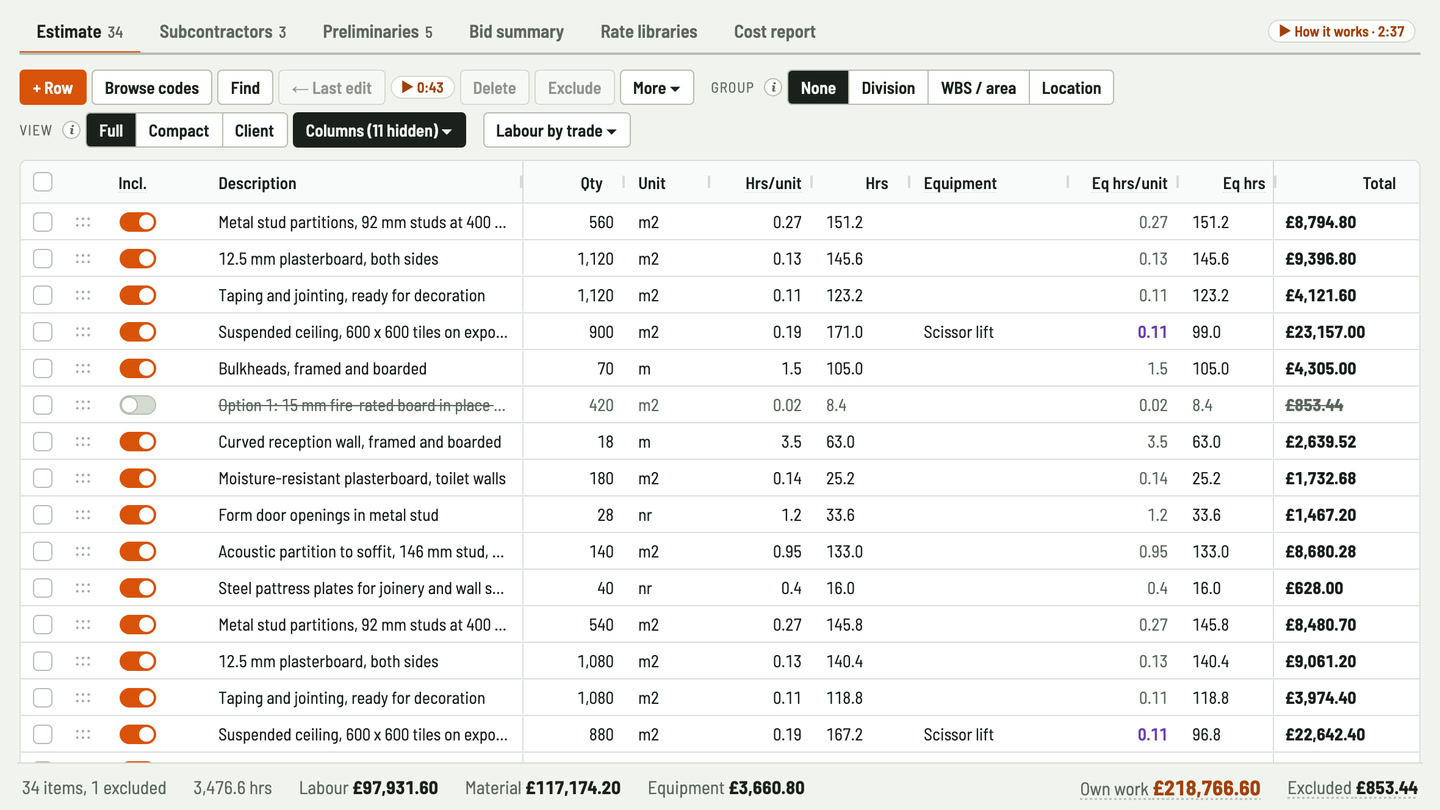

    Partitions, plasterboard and ceiling tiles by the square metre, bulkheads by the metre. Each line takes a quantity, hours per unit, a material price with a waste percentage, and plant by the hour.

  • Bidfident screenshot: floor by floor, with subtotals

    Floor by floor, with subtotals

    Tag each line with a floor or area and group the sheet by it, with a subtotal for each. Collapse the groups to see all three floors at once.

  • Bidfident screenshot: change a whole floor at once

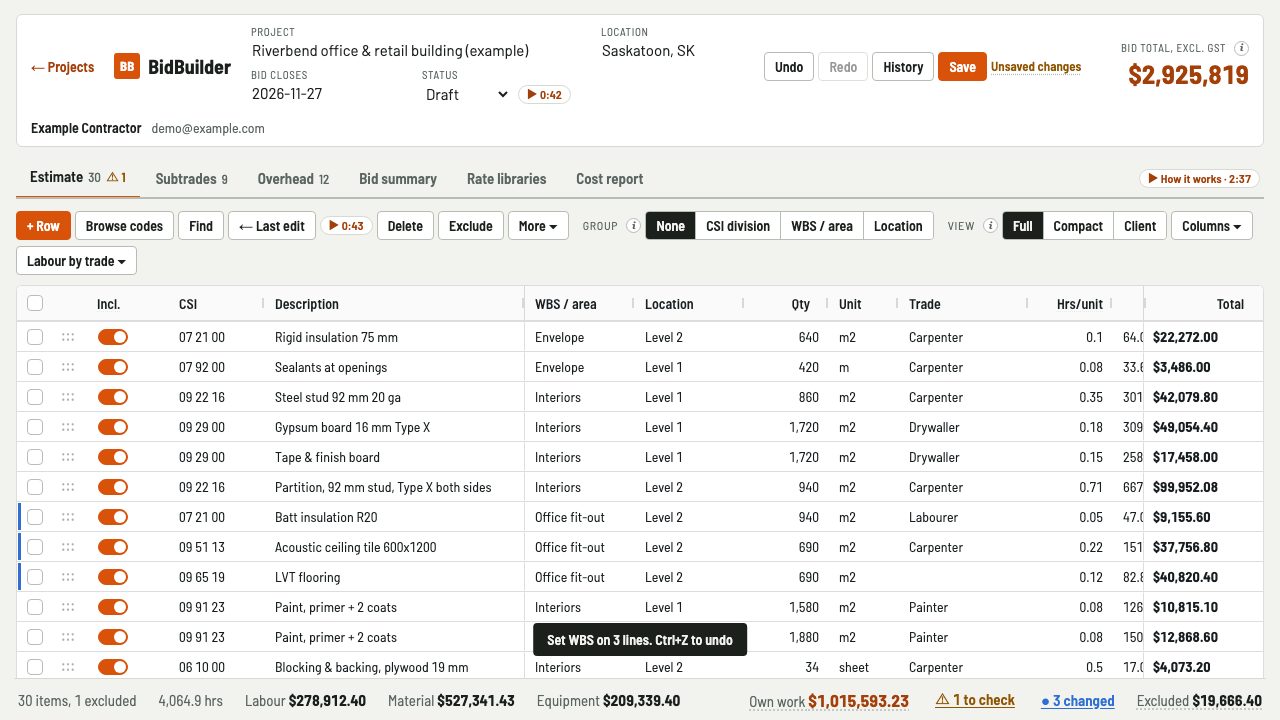

    Change a whole floor at once

    Tick the lines for the first floor, then set their area, trade or plant on all of them in one go. The totals for just the ticked lines show as you pick them.

  • Bidfident screenshot: the lift on the ceiling line only

    The lift on the ceiling line only

    The scissor lift on the suspended ceiling gets its own hours per square metre, so it's charged for the time it's used, not every hour the gang is on the line.

  • Bidfident screenshot: insulation quotes side by side

    Insulation quotes side by side

    Enter each quote for acoustic insulation in the partitions, see the lowest flagged, and carry it or the one you pick. No quote yet? Carry an allowance.

Worked example: dry lining and ceilings for a three-storey office

A made-up job, priced in Bidfident: 33 lines of your own work, 3 subcontract packages and 5 preliminaries items over a 12-week programme. The 5 lines this page talks about are listed one by one, and the rest are added up in one row. It's the same job you can open as an example project in Bidfident, so every figure below matches it.

To open this job in Bidfident: sign in and set up your company in the UK, then on the Projects screen, under Example project, pick "Specialist subcontractors" and "Dry lining" and press Add example project.

Your own work
ItemAmount
Metal stud partitions, 92 mm studs at 400 mm centres, 560 m2

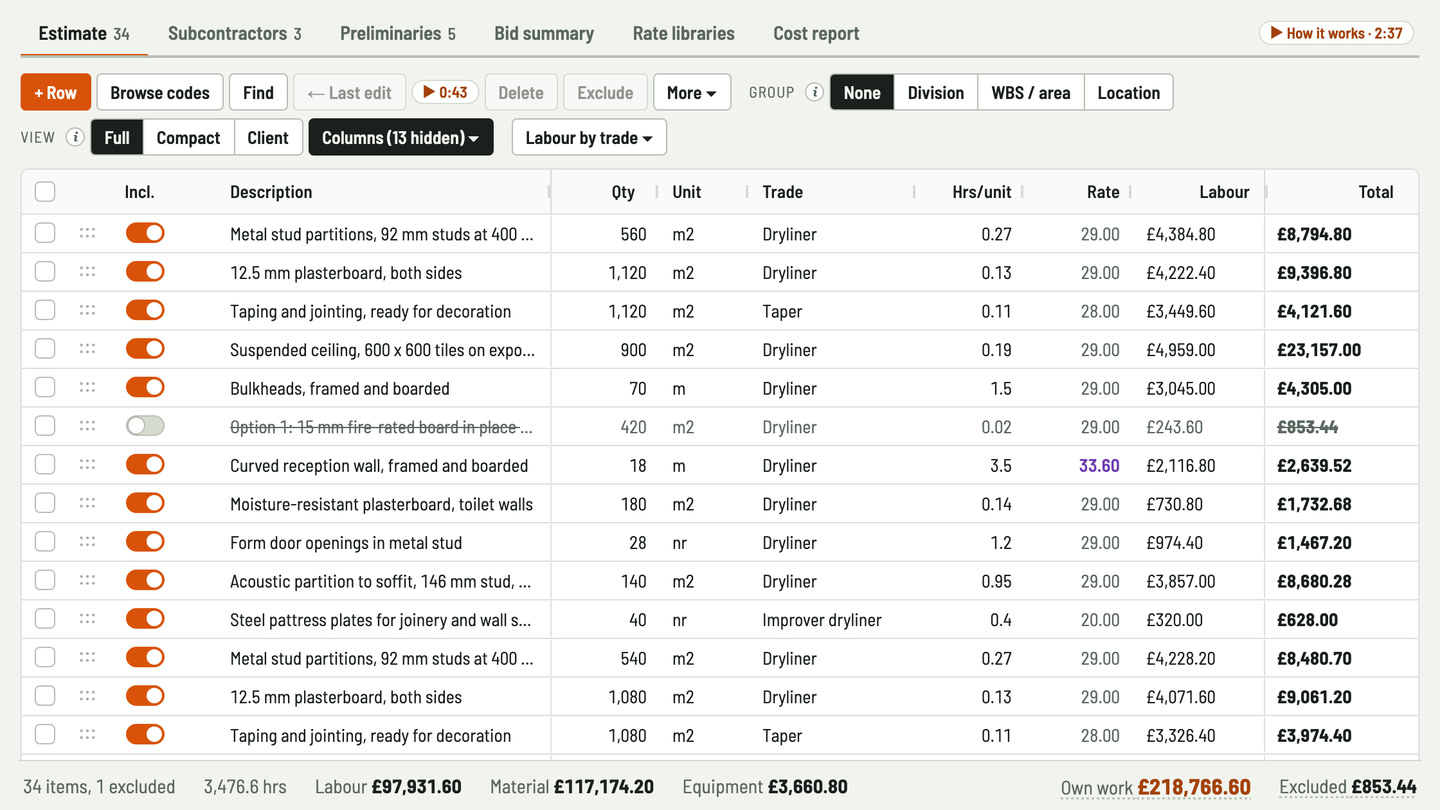

  • Labour: 560 m2 × 0.27 hrs = 151.2 hrs at £29.00/hr (dryliner) = £4,384.80
  • Materials: 560 m2 × £7.50 + 5% waste = £4,410.00
£8,794.80
12.5 mm plasterboard, both sides, 1,120 m2
  • Labour: 1,120 m2 × 0.13 hrs = 145.6 hrs at £29.00/hr (dryliner) = £4,222.40
  • Materials: 1,120 m2 × £4.20 + 10% waste = £5,174.40
£9,396.80
Taping and jointing, ready for decoration, 1,120 m2
  • Labour: 1,120 m2 × 0.11 hrs = 123.2 hrs at £28.00/hr (taper) = £3,449.60
  • Materials: 1,120 m2 × £0.60 = £672.00
£4,121.60
Suspended ceiling, 600 x 600 tiles on exposed grid, 900 m2
  • Labour: 900 m2 × 0.19 hrs = 171 hrs at £29.00/hr (dryliner) = £4,959.00
  • Materials: 900 m2 × £18.00 + 5% waste = £17,010.00
  • Plant: scissor lift, 900 m2 × 0.11 hrs = 99 hrs, less than the crew, at £12.00/hr = £1,188.00
£23,157.00
Bulkheads, framed and boarded, 70 m
  • Labour: 70 m × 1.5 hrs = 105 hrs at £29.00/hr (dryliner) = £3,045.00
  • Materials: 70 m × £18.00 = £1,260.00
£4,305.00
28 more lines of your own work
  • Labour £77,870.80 + materials £88,647.80 + plant £2,472.80
  • 1 more line is priced but left out of the total
£168,991.40
Subcontractors
ItemAmount

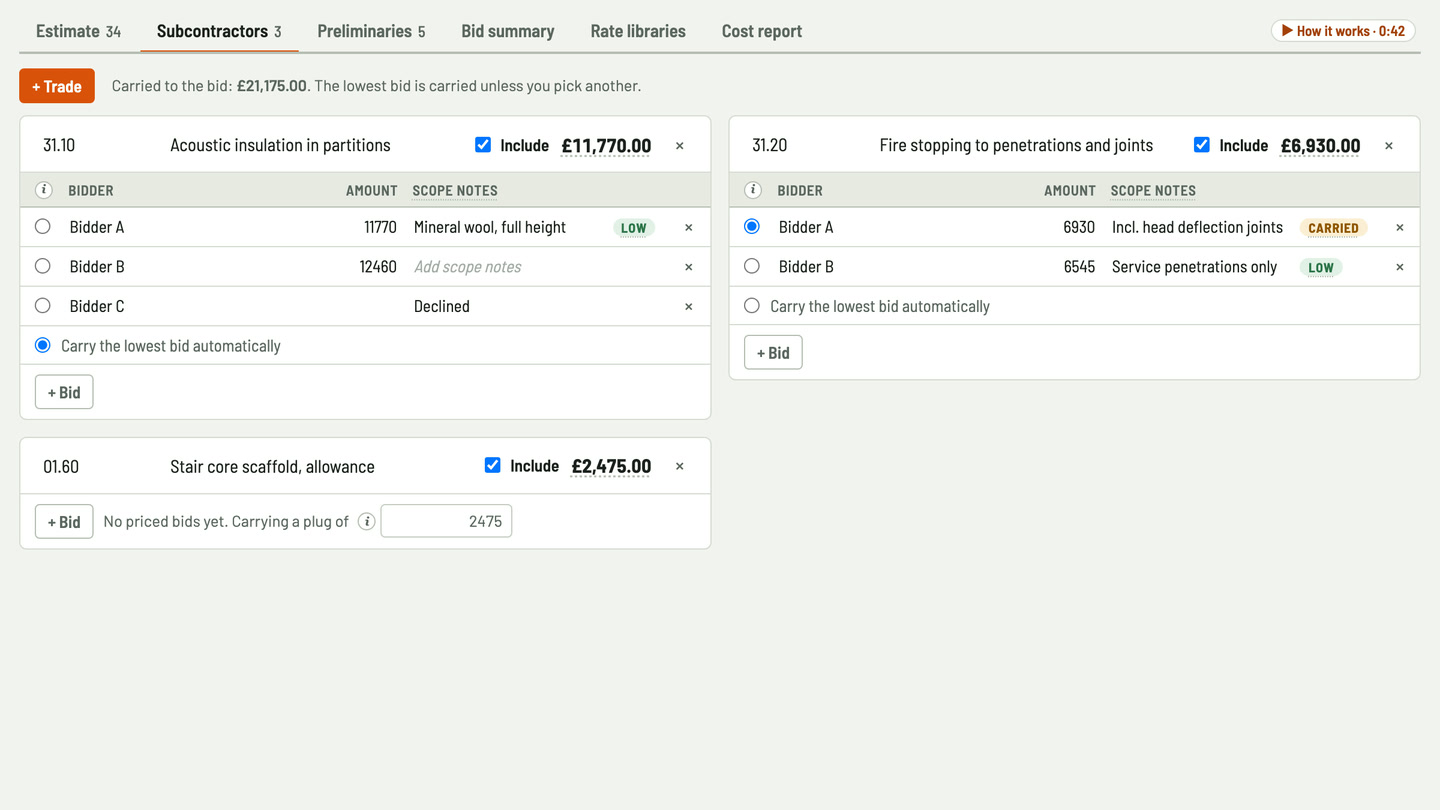

Acoustic insulation in partitions
  • Quotes: Bidder A £11,770.00, Bidder B £12,460.00
  • Carrying the lowest: Bidder A
£11,770.00
Fire stopping to penetrations and joints
  • Quotes: Bidder A £6,930.00, Bidder B £6,545.00
  • Carrying the chosen quote: Bidder A
£6,930.00
Stair core scaffold, allowance
  • No quotes yet: carrying an allowance
£2,475.00
Preliminaries
ItemAmount
Supervision, part-time site supervisor
  • 12 wk × £700.00, following the programme
£8,400.00
Contracts manager, part time
  • 12 weeks × £1,320.00 a month × 12 ÷ 52, following the programme
£3,655.38
Small tools, screw guns and stilts
  • 12 wk × £105.00, following the programme
£1,260.00
Board delivery and crane offload
  • 1 LS × £1,870.00
£1,870.00
Skips, exchanged
  • 6 ea × £330.00
£1,980.00
Tender summary
ItemAmount
Own work
  • Labour £97,931.60 + materials £117,174.20 + plant £3,660.80
£218,766.60
Excluded lines, not counted£853.44
Subcontractors£21,175.00
Preliminaries
  • 12 weeks
£17,165.38
Direct cost
  • Own work + subcontractors + preliminaries
£257,106.98
Contingency
  • 3% of direct cost
£7,713.21
Overheads and profit
  • 10% of direct cost plus contingency
£26,482.02
Subtotal before the bond£291,302.21
Bond
  • 0% of the subtotal
£0.00
Insurance
  • 0.5% of the subtotal
£1,456.51
Tender total
  • The price you tender, before VAT
£292,758.72
VAT, for reference
  • 20%, shown separately and not part of the tender total
£58,551.74

See it in Bidfident

Labour by trade The dry liner and the taper each take their own rate from the library, line by line. 33 sec
Change several lines at once Tick a floor's lines and set the area, trade or plant on all of them at once. 33 sec
Group by area or floor Group the sheet by floor, with a subtotal for each storey. 34 sec

Coming soon Ask your estimate anything. Claude first, ChatGPT to follow. See how it will work

Questions

Can I price in square metres?

Yes. Units are free text, so m², m, nr and item all work. Bidfident doesn't convert between units, so price each line in the unit its rate is in.

Can taping and jointing have a different rate from boarding?

Yes. Set up a taper as its own trade with its own rate, and give the jointing line that trade. Each line then takes its trade's rate.

Can I build a partition type as one line?

Yes. Save it in the rate library as an assembly, such as a metal stud partition boarded both sides. Pick it from the line picker and it fills the whole line at once.

Can I price each floor separately?

Yes. Tag each line with an area or location, then group the sheet by it to see a subtotal for each floor.

Does it measure walls from the drawings?

No. Bidfident doesn't read quantities from drawings. Type your square metres in, or paste them from a spreadsheet.

Can I price skips by the number exchanged?

Yes. Add skips to your preliminaries as each, with the number of exchanges and the price per skip. Supervision can sit beside them by the week, following the programme.

Does Bidfident work with Claude or ChatGPT?

Not yet, but it's coming. You'll be able to connect Bidfident to your own Claude or ChatGPT account and ask about your estimates in plain English. The answers will come from Bidfident's own figures, so they match the estimate. It will use the account you already have: Claude first, ChatGPT to follow.
